Microsoft Project 2013-what is new? Part 5



Hi

I will show you one excellent Report in MS PROJECT 2013!

First I will recall Project from my Last Post:


I will show you cost Table:

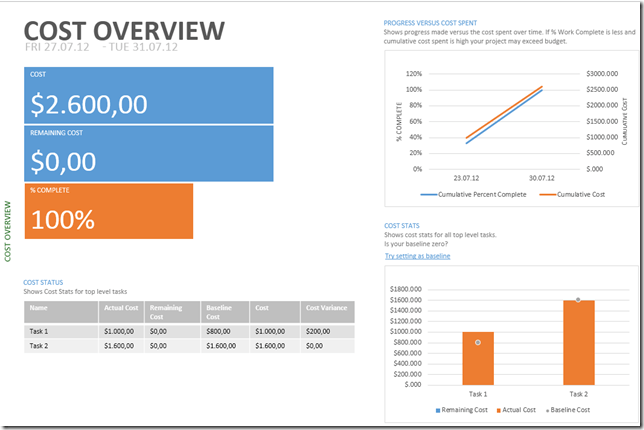

Now, I will run new Report, Cost Overview:


and I will get:

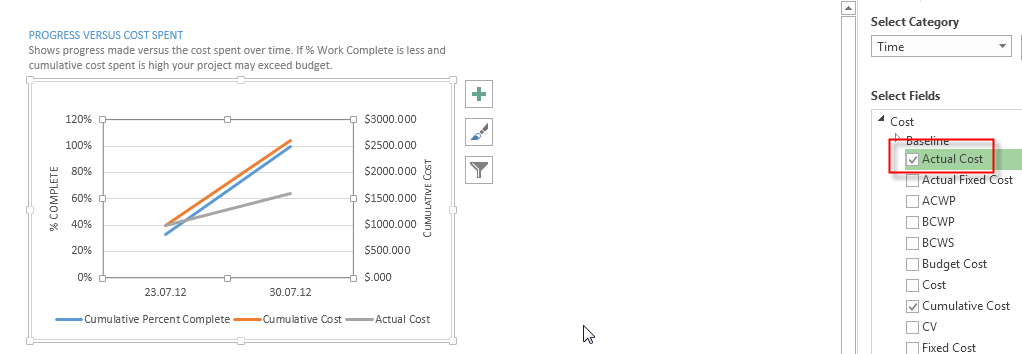

I will Select the Upper Right chart, Progress Versus Cost Spent, and I will do some modifications:

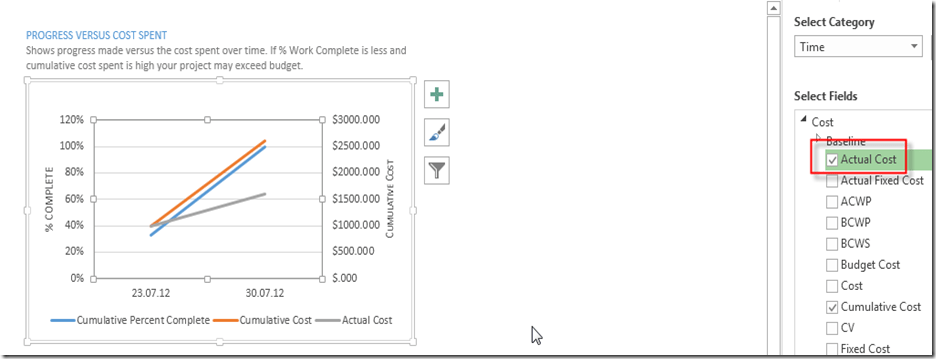

First I have added Actual Cost on the chart.

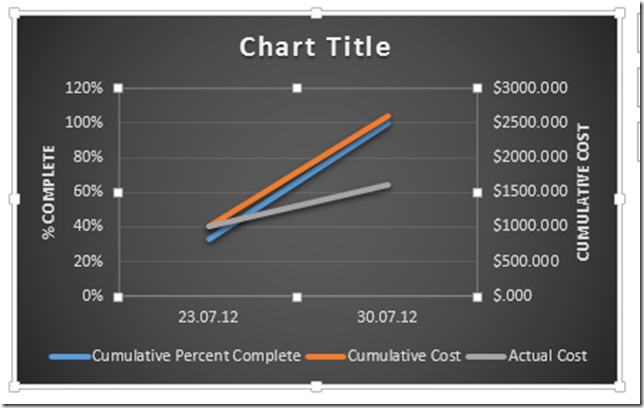

Now I am going to change the Style:


and I will get:

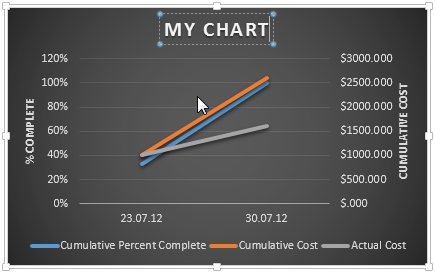

I will change the Title too:

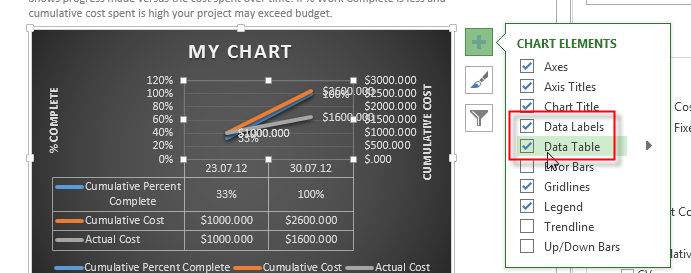

Finally I will add some more data:


and I will get:


It’s messy! I will spread this picture:


It is much better now, isn’t it!

Once again, great job Microsoft!

Regards!
