Hi,
I have a question from one of my Blog Readers! Here it is:
“About overtime, I tried to apply 12 hours a day on Saturday and Sunday, it’s a 2 day work (driving car) and It allocates 24 hours on Saturday. Both days are dayoff (rest time), so it’s 24 hours overtime rate. Is there a way to allocate 12 hours a day?”
Let’s do it!

I will create two Tasks in MS PROJECT 2010:

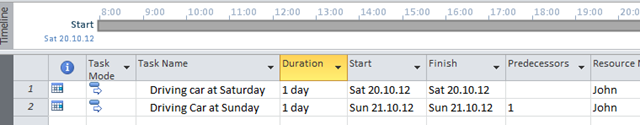

Now I will put Saturday 20.10.2012 as a Start Date for the first Task:

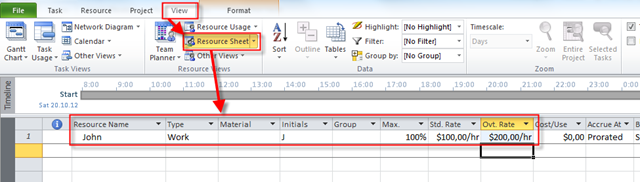

I will add John as Resource with $100 as Standard Rate, and $200 as Overtime Rate:
and finally I will assign John to both my Tasks:

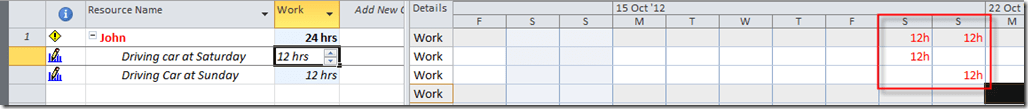

Now I will use Work Table, and I will put 12 hours per day, instead 8:

Now I am going to look at the Detailed View:
and I will get:
I will put 12 hours per day instead of 8:
Now I will switch to the Detail View:

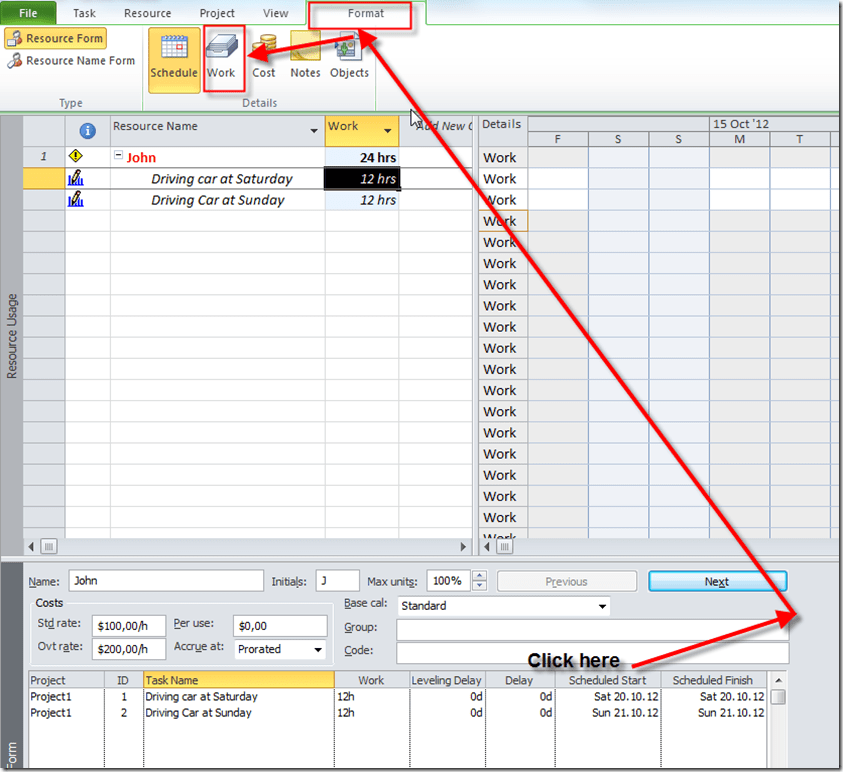

I will click at the bottom part of the screen, and then:
and I will get:

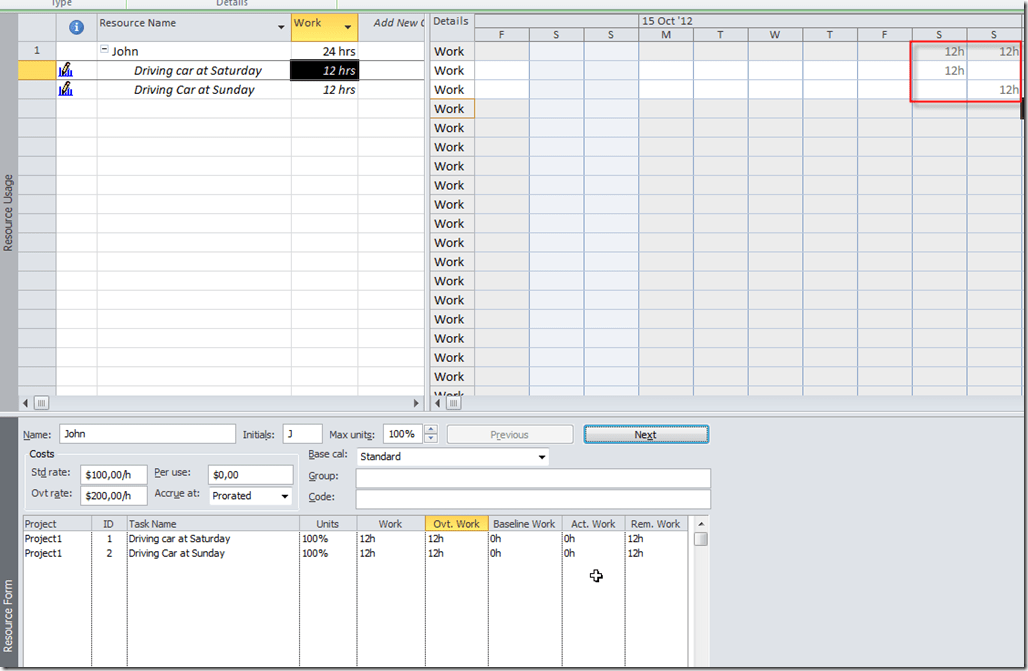

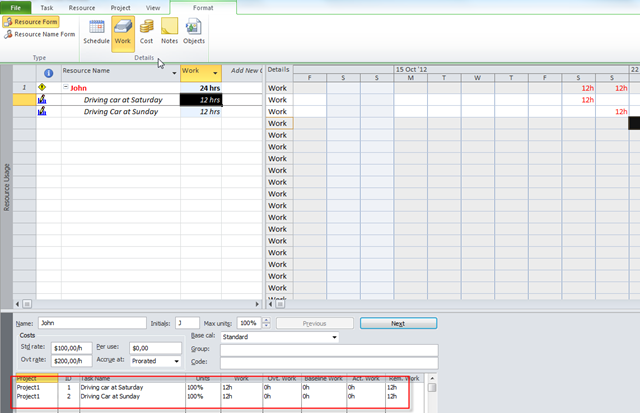

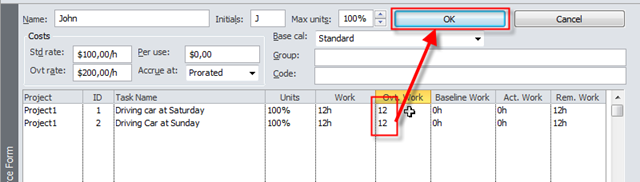

Now I will put in Ovt. Work 12 hours:
and I will get:
John is no more overallocated!

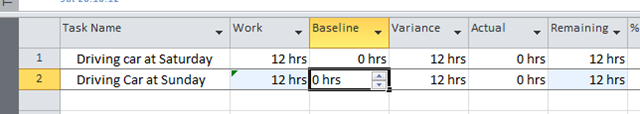

Let see a Cost Table:
and I will get:
John will work 12 hours per day (Saturday and Sunday) and his Overtime Rate is $200! So 12 X $200 = $2400 per day!
And that’s it!
Regards!
Link them for now!
Now I will put Sunday 21.10.2012 as a Start Date for the Second Task:
So I am making Sunday as a working day!

Now I will remove Link between this two Tasks and I am going to put Saturday 20.10.2012 as a Start Date for the first Task, again:
and I will connect them:

Like this:
