How to set different Work days during time period with Microsoft Project for the Web

Hi,

Today I will show you how to set different Work days during time period with Microsoft Project for the Web!

Here is Scenario. Until 10/01/2020 (October the 1st), work days are going to be from Monday to Friday. From 10/10/2020 they are going to be from Monday to Thursday!

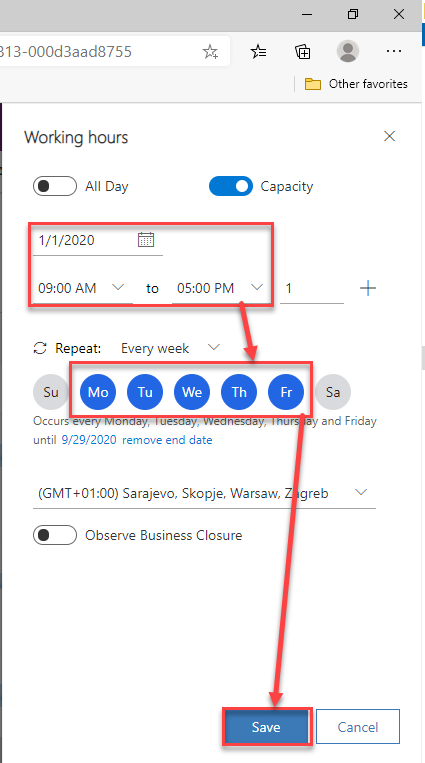

First I will setup Calendar:

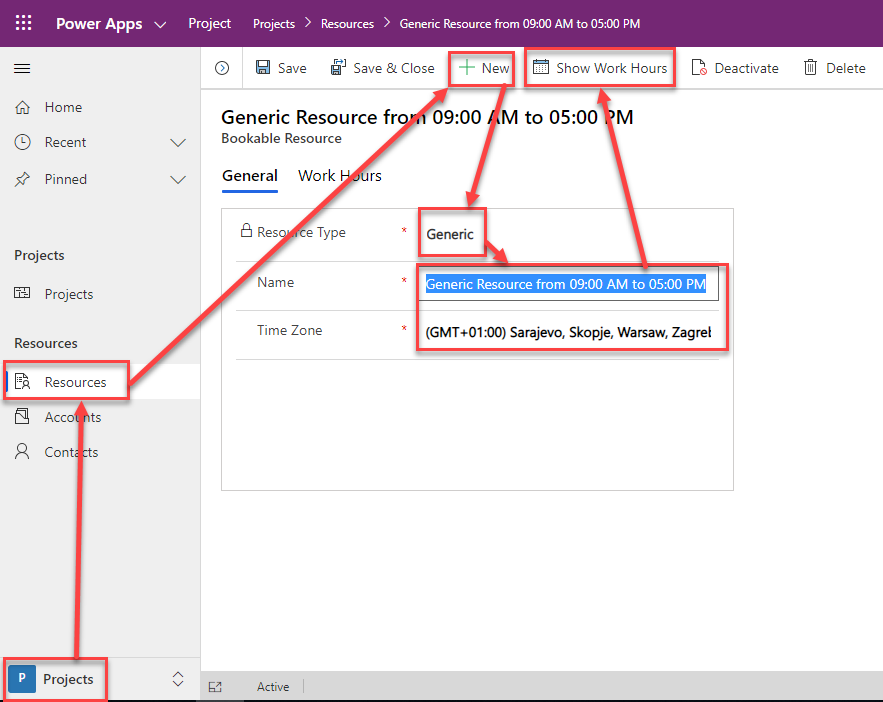

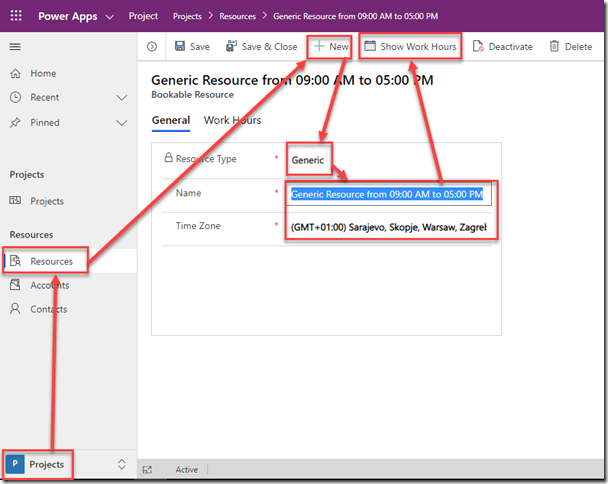

and I will create Generic Resource called: Generic Resource from 09:00 AM to 05:00 PM


and then:


and:

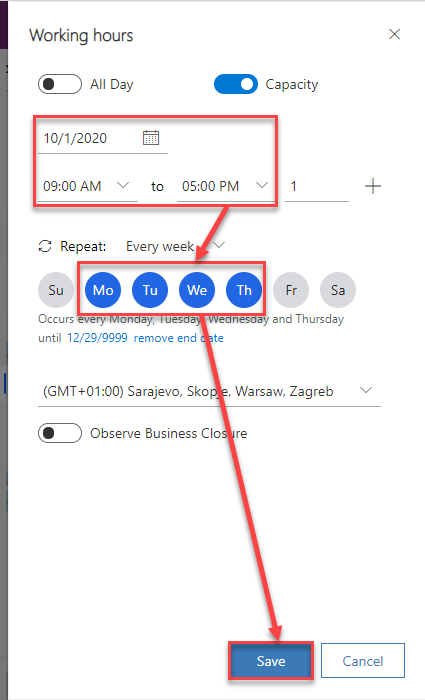

Now, I will choose 10/01/2020, and I will set up work days like this:

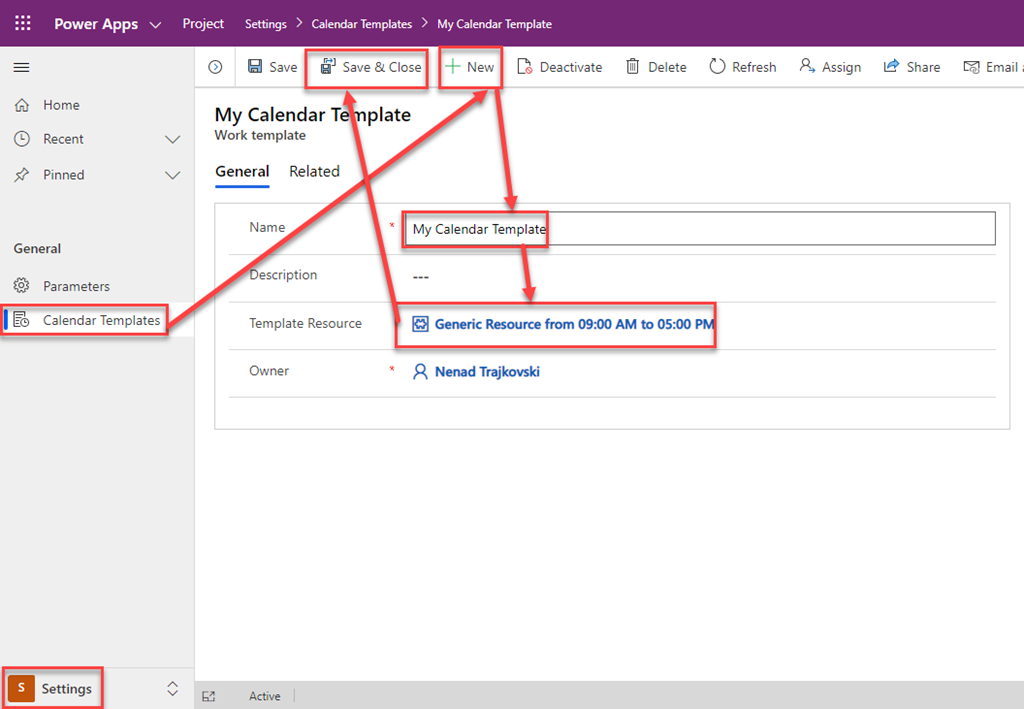

OK! That’s it.  I will use this Resource as a Template for my Calendar Template:


Now, I will create brand new Project:

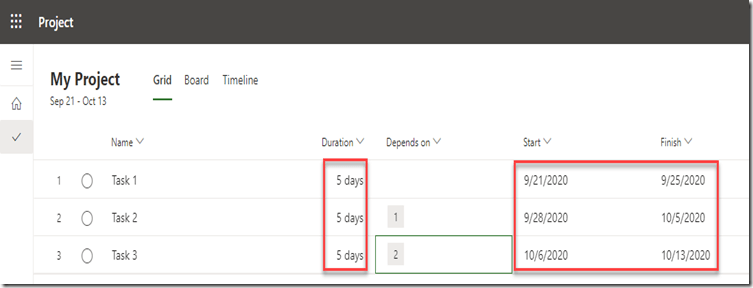

and I will create a Schedule:


or:


Let me explain:

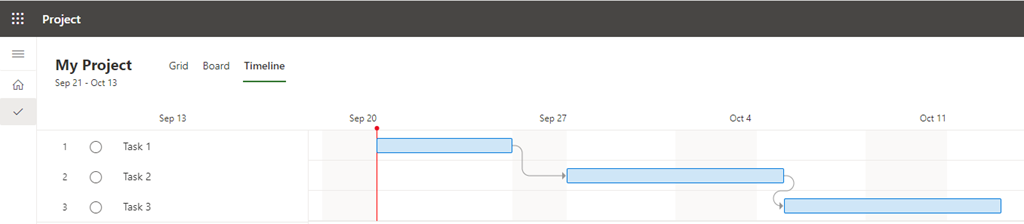

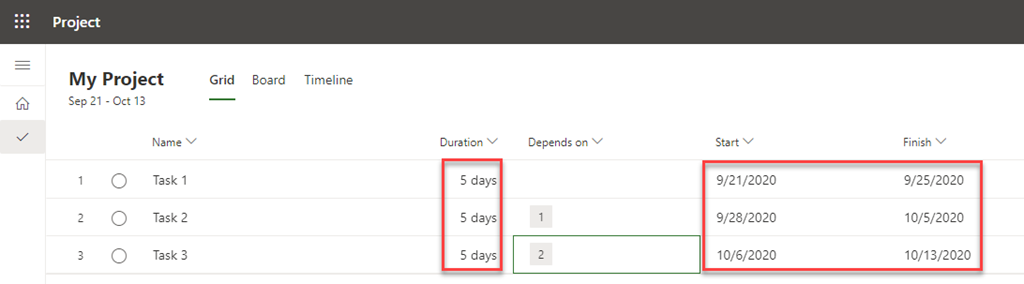

  • Task 1 has 5 days duration. I will start at Monday 9/21/2020 and it will finish at Friday 9/25/2020
  • Task 2 has 5 days duration. I will start at Monday 9/28/2020 and it will finish at Monday, 10/5/2020 since Friday 10/01/2020 is non working day
  • Task 3 has 5 days duration. I will start at Tuesday 10/6/2020 and it will finish at Tuesday 10/13/2020 (e.g. work days are: Tuesday 10/6, Wednesday 10/7, Thursday 10/8, Monday 10/12 and Tuesday 10/13 – those are 5 work days!)

Hope this helps.

Regards!

Unknown's avatar

About Nenad Trajkovski

Location: Zagreb, Croatia Occupation: Project Manager Interests: Project Management and MS PROJECT He was born in Zagreb, Croatia at 1963. After completing his college he started working on projects in different business areas (banking, manufacturing, automotive industry, distribution, oil companies, etc.) developing and implementing ERP systems into different companies. He has got a lot of experience working with people in different business processes and also possesses great knowledge in information technologies and financial services. Today he works as a business consultant, adn Project Manager in PERPETUUM MOBILE d.o.o. Zagreb. He is a regular lecturer for Project Management in MS Innovation Center in Varaždin, Logosoft Sarajevo in Bosnia and Herzegovina and SEAVUS GROUP in Skopje Macedonia. He was named the best lecturer of WINDAYS 2008 while his lecture was also voted as the best. In addition, he was in TOP 10 lecturers at the MS SINERGY 2009 and MS VISIA 2009, 2010. Shares first place as the best lecturer of KulenDays 2009 and 2010 and PMI Conference 2009 in Zagreb. He is also a regular lecturer in the MS Community. He is a Certified Accountant and a PMP (Project Manager Professional) and a PMI-RMP (Risk Manager Professional), MCP, MCT, and Microsoft Certified Technical Specialist - Microsoft Project 2010. From 01.01.2012 awarded with MVP (Microsoft Most Valuable Proffesional - Microsoft Project)!
