Specific Resource overallocation during the day using MS PROJECT 2019

Hi,

I have a question from my Blog reader: “I want to solve overallocation of R1, since it is assigned to Task1 and Task2. I want to divide the work of R1 between  Task 1 and Task 2 to solve overallocation. For example: R1 will be assigned to Task 1 from 08h to 12h and he will be assigned to Task 2 from 13h to 17h. How can I do this please, I need that.”

I will use MS PROJECT 2019. Here is the Project:

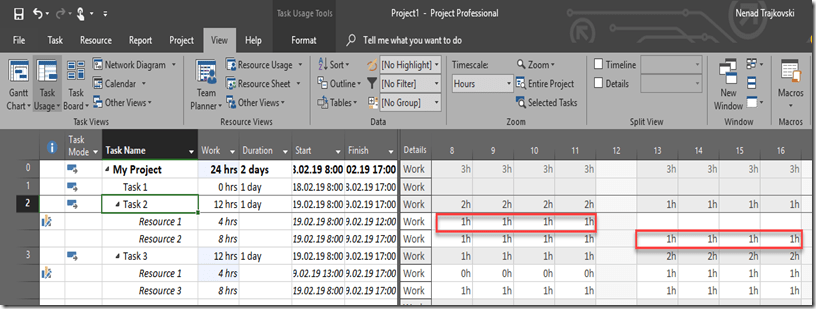

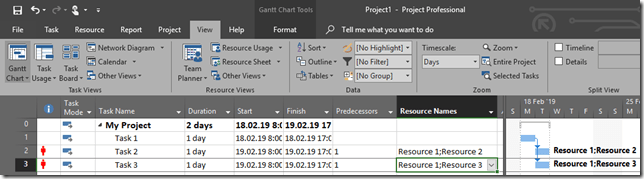

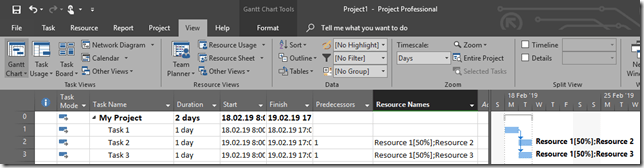

Obviously Resource 1 is overallocated because it should be assigned 50% and not 100%.

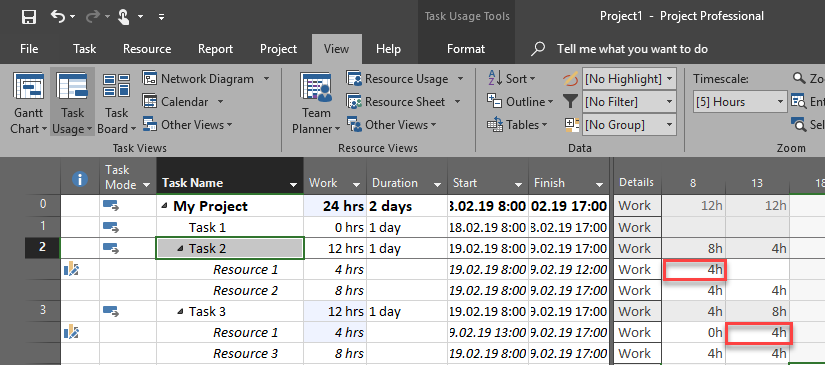

If I do that , I will get:

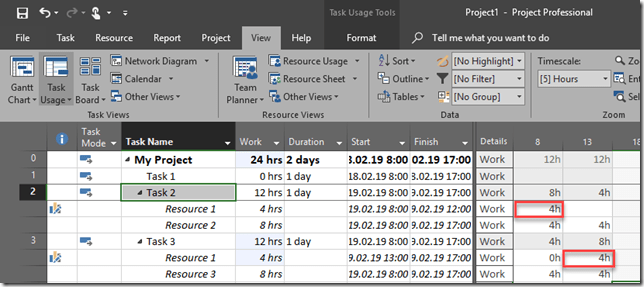

image Now Resource 1 is not overallocated. But let’s see work distribution during the day:

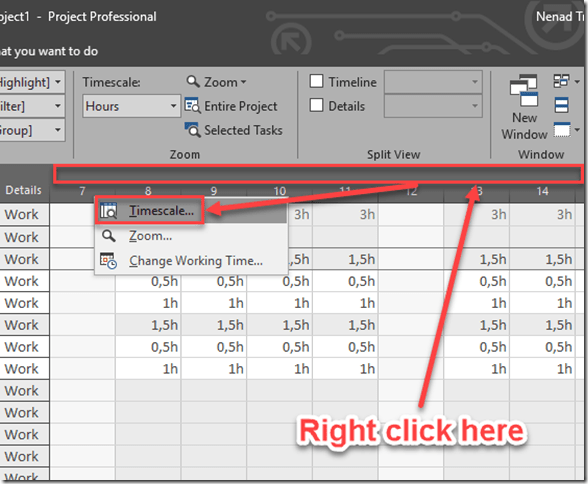

As you can see, Resource 1 is going to work during the day in a way that he/she will work 0,5 hours on one, and then 0,5 hours on the other Task! And in real life this is a rare case (I didn’t see it in my career). How to solve this? Well, hard!

I can manually assign work.

and:

I will get:

Finally, I will adjust assignment:

I will return to “standard” Timescale:

Regards!
