How to make every second Saturday as working day in MS PROJECT 2019

Hi,

sometimes, in your Project you will need to make some Saturdays (or Sundays) make as a working day. Let’s say that I need to work every second Saturday.

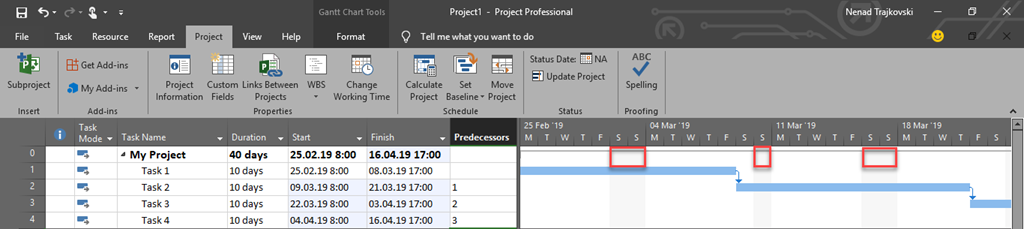

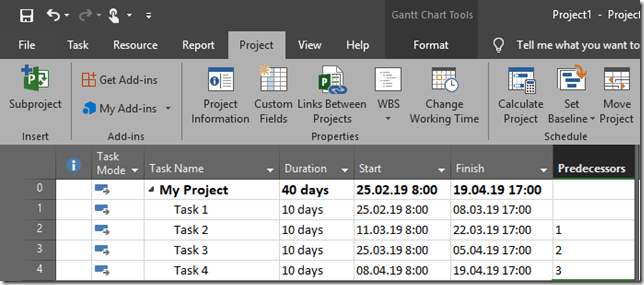

I have a simple Project:

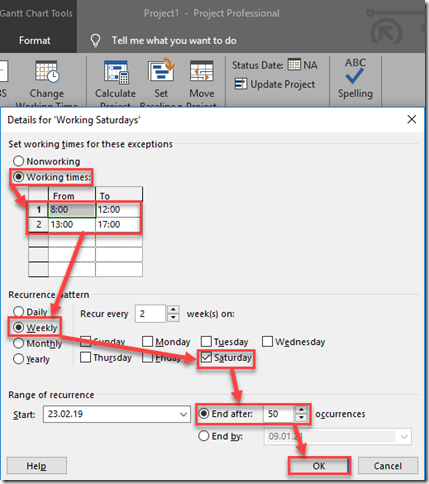

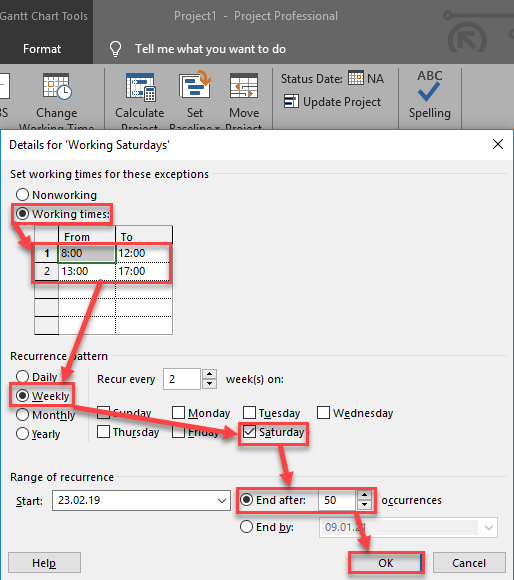

I want to make every second Saturday as a working day. To do that I should follow next steps:


and:


and the result is:


So I’ve got every second Saturday as a working day.

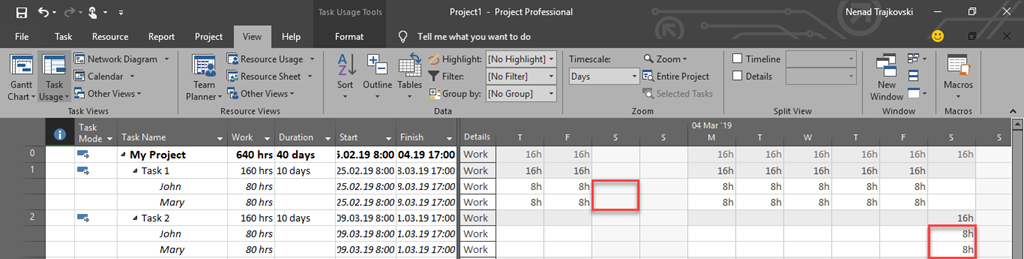

Let’s say that John and Mary are going to work on those Tasks. If I assign them, they will work on those Saturdays as well:


But what if I do not want John to work on any Saturday?


and:

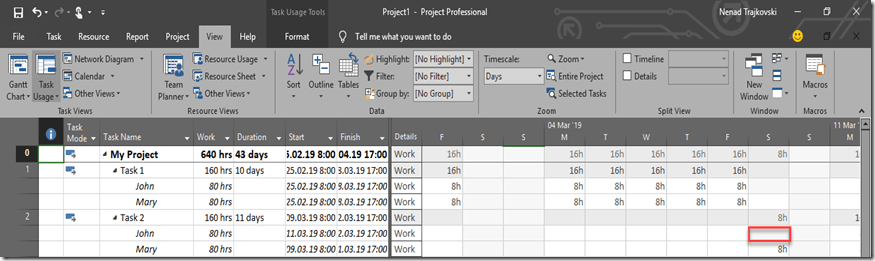

and the Result is:


As you can see, only Mary will work on that specific Saturdays.

Regards!

Unknown's avatar

About Nenad Trajkovski

Location: Zagreb, Croatia Occupation: Project Manager Interests: Project Management and MS PROJECT He was born in Zagreb, Croatia at 1963. After completing his college he started working on projects in different business areas (banking, manufacturing, automotive industry, distribution, oil companies, etc.) developing and implementing ERP systems into different companies. He has got a lot of experience working with people in different business processes and also possesses great knowledge in information technologies and financial services. Today he works as a business consultant, adn Project Manager in PERPETUUM MOBILE d.o.o. Zagreb. He is a regular lecturer for Project Management in MS Innovation Center in Varaždin, Logosoft Sarajevo in Bosnia and Herzegovina and SEAVUS GROUP in Skopje Macedonia. He was named the best lecturer of WINDAYS 2008 while his lecture was also voted as the best. In addition, he was in TOP 10 lecturers at the MS SINERGY 2009 and MS VISIA 2009, 2010. Shares first place as the best lecturer of KulenDays 2009 and 2010 and PMI Conference 2009 in Zagreb. He is also a regular lecturer in the MS Community. He is a Certified Accountant and a PMP (Project Manager Professional) and a PMI-RMP (Risk Manager Professional), MCP, MCT, and Microsoft Certified Technical Specialist - Microsoft Project 2010. From 01.01.2012 awarded with MVP (Microsoft Most Valuable Proffesional - Microsoft Project)!
This entry was posted in MICROSOFT PROJECT 2019, MS PROJECT 2019 and tagged . Bookmark the permalink.

Leave a Reply
