Creating Fixed Duration Task using Task form in MS Project 2019

Hello,

today I’m going to show you how to use Task Form for creating Tasks from the scratch using MS PROJECT 2019!

First of all, let me crate two brand new Project:


OK. I need John and Mary as Resources, as well:


OK, now the Task Form:


Remember the magic formula, the heart of MS PROJECT which is: Work = Duration * Units

Now, I will create brand new Task for which I want to be Fixe duration, non Effort Driven with 5 days of Duration, but I want John to work 16 hours, and Mary 32 hours:

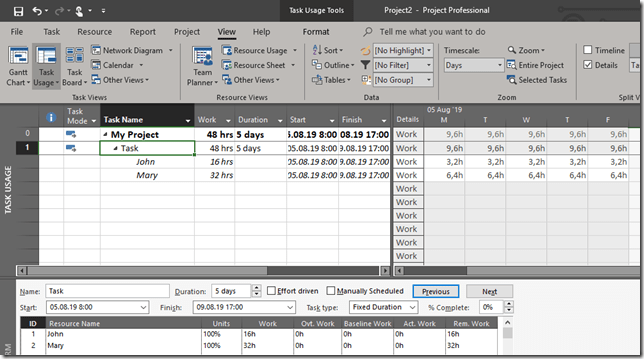

When I hit OK button I will get:

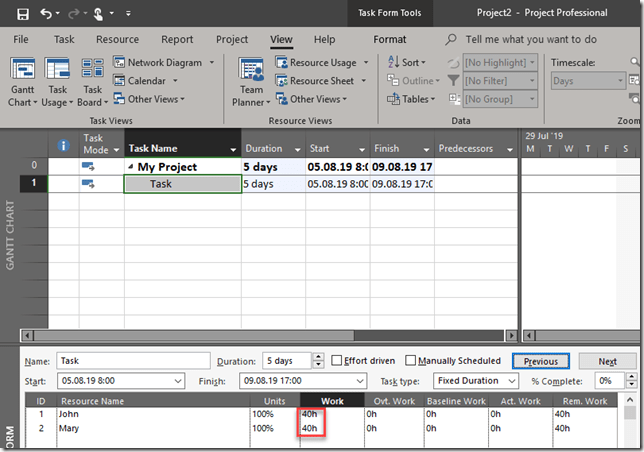

Wow! This is now what I wanted. So, this must be a bug. But it is not!

Since I put Duration = 5 days, and Duration is fixed, and I did not put Units,MS PROJECT calculate work, no matter of values in Work field like this:

Work = Duration * Units, e.g. work = 5 days (8 house per day e.g 40 hours) * UNITS form Resource sheet (e.g. 100%), and the result is Work = 40 hours * 100% = 40 hours for John and Mary.

But, I want that in this 5 days John work 16 hours and Mary 32. I have two options to get that.

First one is to change hours like this:


and I will get:


Second one is to put right Units when creating a new Task, like this:

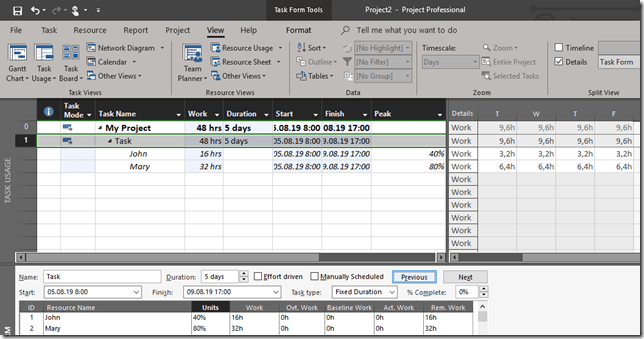

and I will get the same result:


MS PROJECT will calculate work according to magic formula, like this:

  • John: Work = Duration * Units, e.g. work = 5 days (8 house per day e.g 40 hours) * UNITS form  (e.g. 40%), and the result is Work = 40 hours * 40% = 16 hours
  • Mary: Work = Duration * Units, e.g. work = 5 days (8 house per day e.g 40 hours) * UNITS form  (e.g. 80%), and the result is Work = 40 hours * 80% = 32 hours

Hope this helps.

Regards!

Unknown's avatar

About Nenad Trajkovski

Location: Zagreb, Croatia Occupation: Project Manager Interests: Project Management and MS PROJECT He was born in Zagreb, Croatia at 1963. After completing his college he started working on projects in different business areas (banking, manufacturing, automotive industry, distribution, oil companies, etc.) developing and implementing ERP systems into different companies. He has got a lot of experience working with people in different business processes and also possesses great knowledge in information technologies and financial services. Today he works as a business consultant, adn Project Manager in PERPETUUM MOBILE d.o.o. Zagreb. He is a regular lecturer for Project Management in MS Innovation Center in Varaždin, Logosoft Sarajevo in Bosnia and Herzegovina and SEAVUS GROUP in Skopje Macedonia. He was named the best lecturer of WINDAYS 2008 while his lecture was also voted as the best. In addition, he was in TOP 10 lecturers at the MS SINERGY 2009 and MS VISIA 2009, 2010. Shares first place as the best lecturer of KulenDays 2009 and 2010 and PMI Conference 2009 in Zagreb. He is also a regular lecturer in the MS Community. He is a Certified Accountant and a PMP (Project Manager Professional) and a PMI-RMP (Risk Manager Professional), MCP, MCT, and Microsoft Certified Technical Specialist - Microsoft Project 2010. From 01.01.2012 awarded with MVP (Microsoft Most Valuable Proffesional - Microsoft Project)!
This entry was posted in MICROSOFT PROJECT 2019 and tagged , , . Bookmark the permalink.

Leave a Reply
