How to set working hours per day (Calendar Template) in Microsoft Project for the Web?

Hi,

I will show you default setup for Working hours per day in Microsoft Project for the Web. Here is my Project:

OK, let me Create one Task with 8 days Duration:

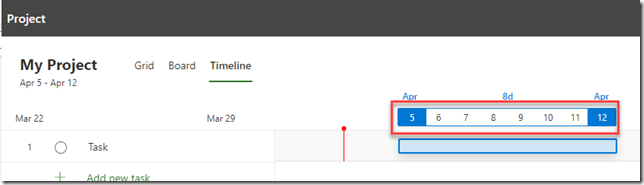

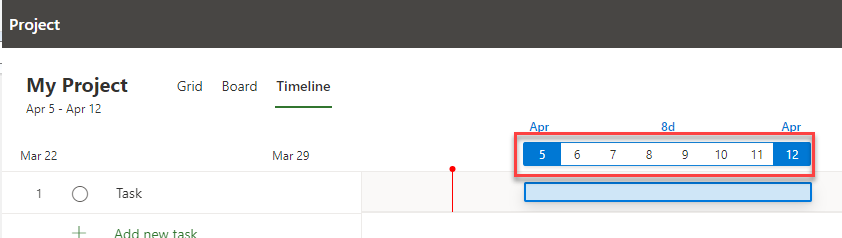

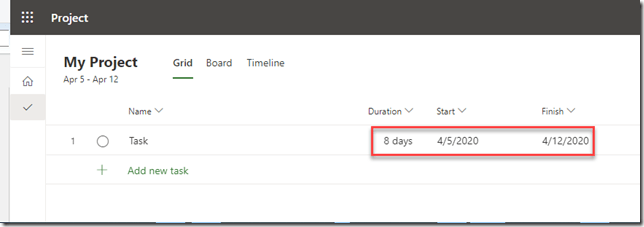

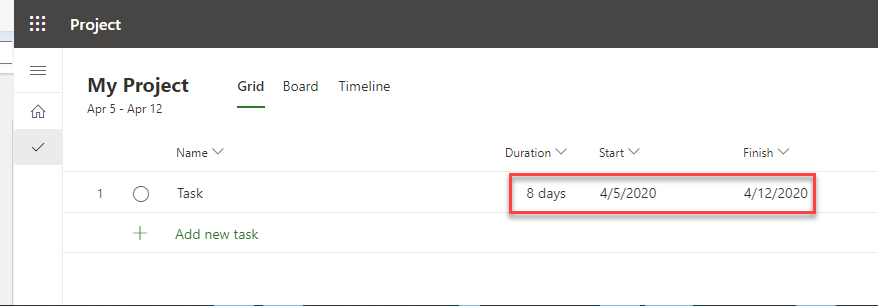

As you can see, Task will start at Monday, 4/5/2020, and Finish at Monday 4/12/2020, e.g. it will be performed during the weekend, as well:

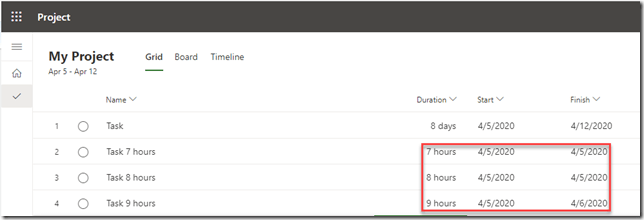

OK. Now I will create three Tasks: Task 7 hours, Task 8 Hours, and Task 9 hours with durations as show in the Picture below:

As you can see, 1 day is 8 hours. In Task 9 hours Finish date is 4/6/2020, and Start date is 4/5/2020, and in Task 8 hours Finish date is 4/5/2020, and Start date is 4/5/2020.

How is it so, and what if I want that my 1 day is 9 hours, but only from Monday to Friday?

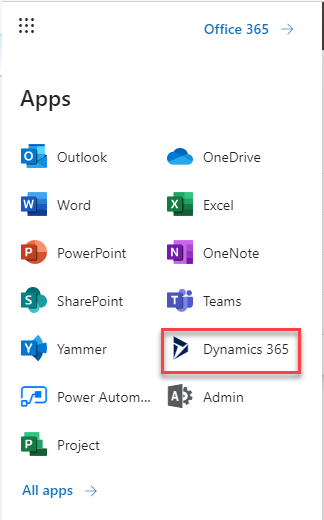

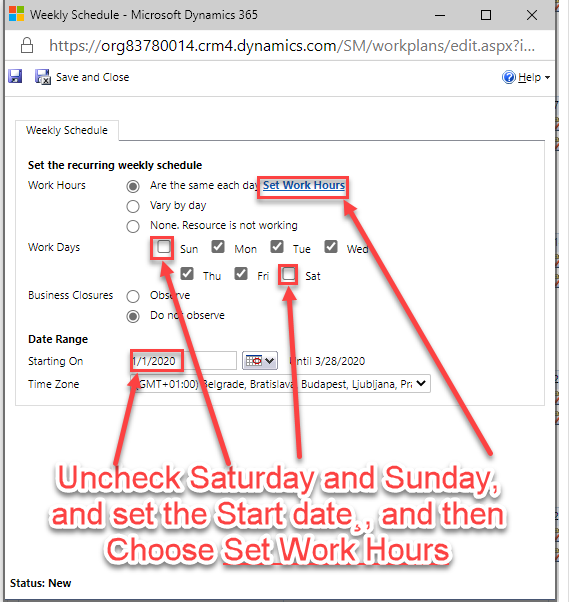

Default Value is that Task is starting from 09:00 AM and finishing at 05:00 PM. To see that I should use Dynamics 365:

and:

and finally:

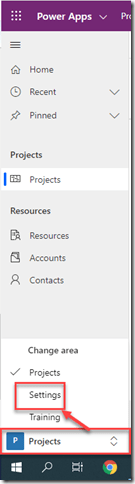

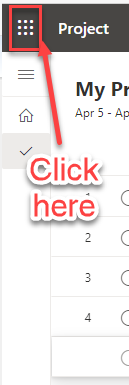

Now I will show you default working time. To do that I should go to settings:

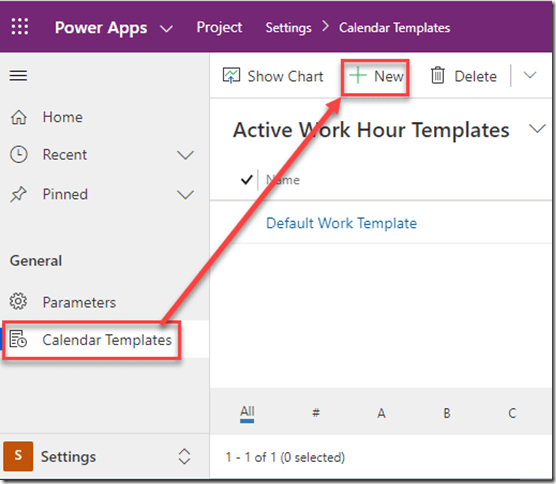

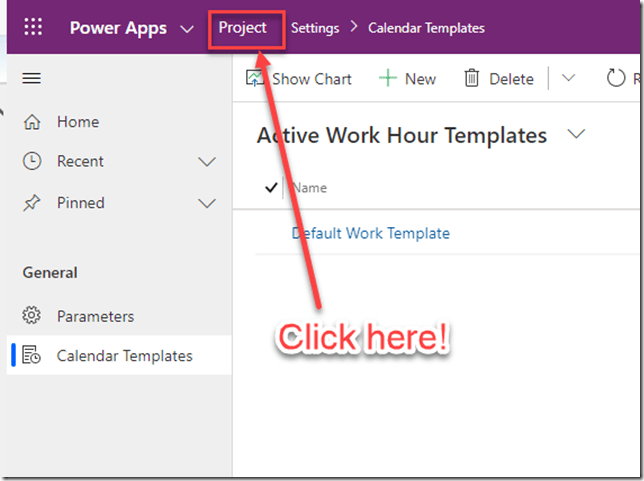

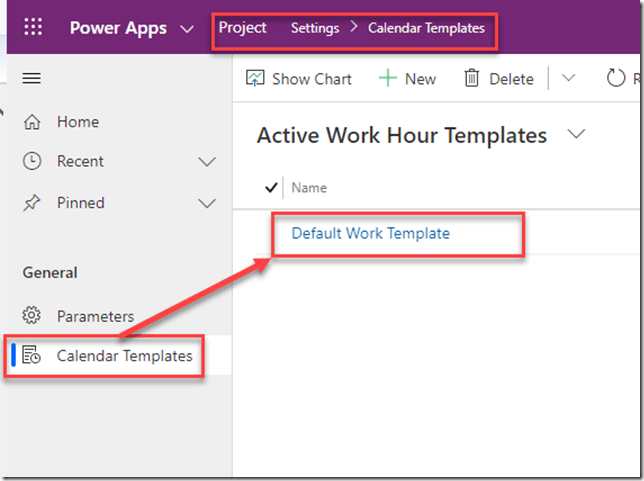

and then to Calendar Templates:

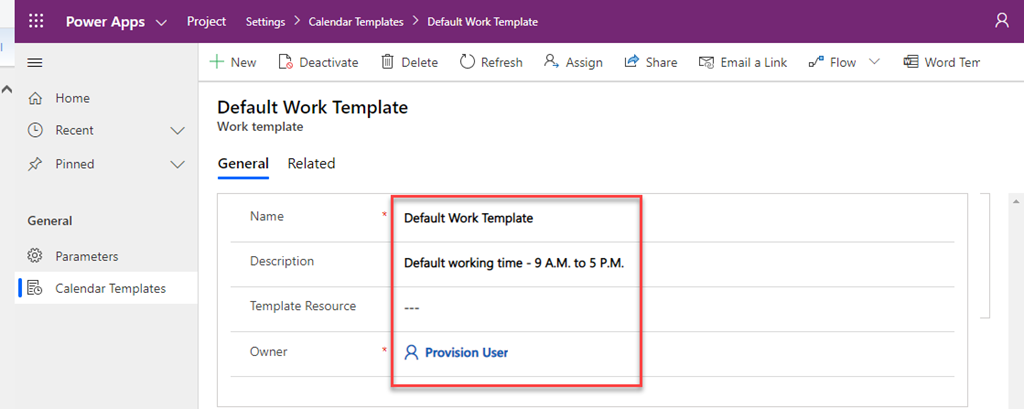

Finally, I will get:

Project for the Web is using this Template if I do not have any other. It is default. Now I will going to create new Template with working hours from 09:00 AM to 06:00 PM, during working days. To accomplish that, first I have to create a resource with those working hours. I will call this Resource: Generic Resource (weekdays, from 09:00 AM to 06:00 PM).

First I will go to the Resource page in Dynamics 365:

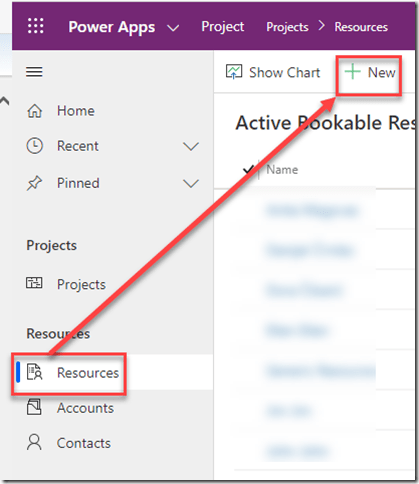

and:

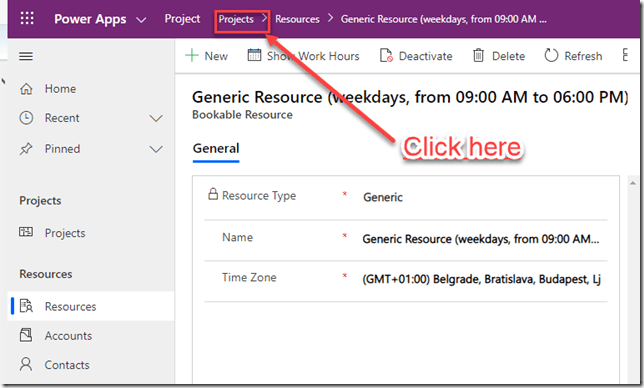

Now I will create new Resource:

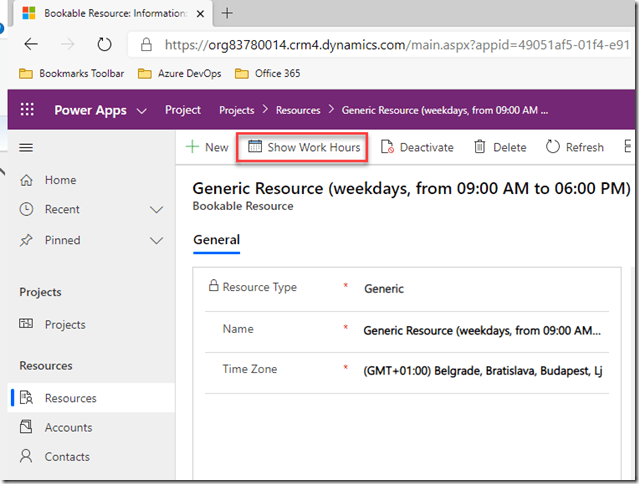

Now I have my Resource and I should setup working time like this.

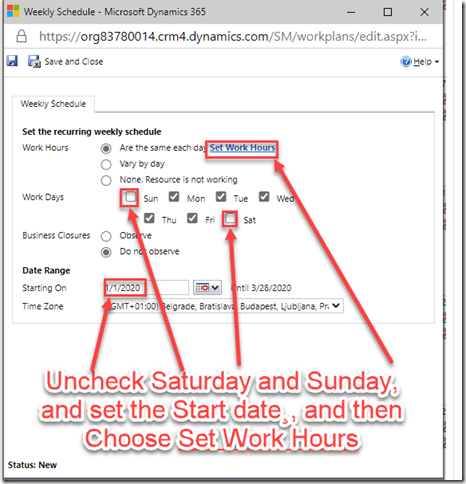

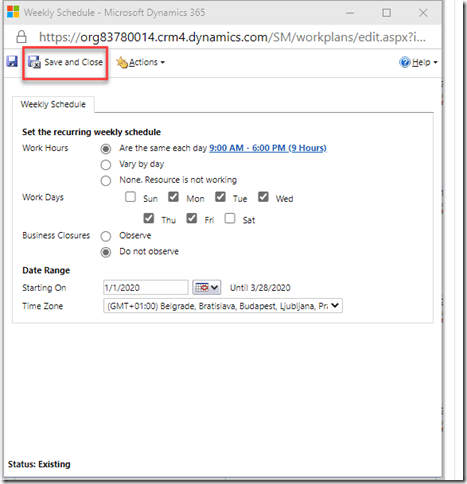

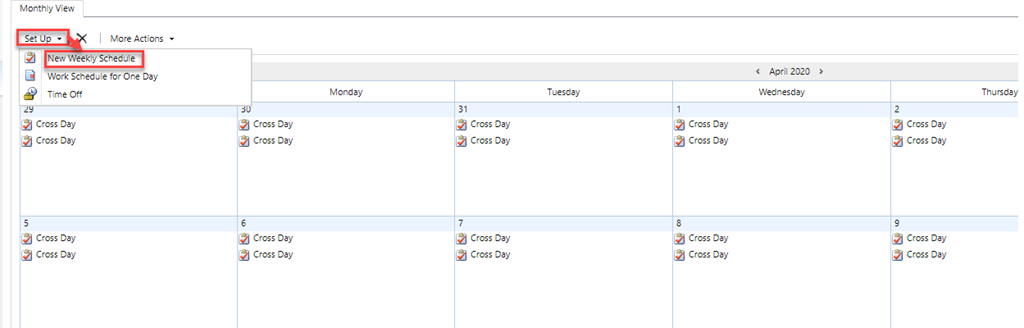

Step 1:

Step 2:

Step 3:

Step 4:

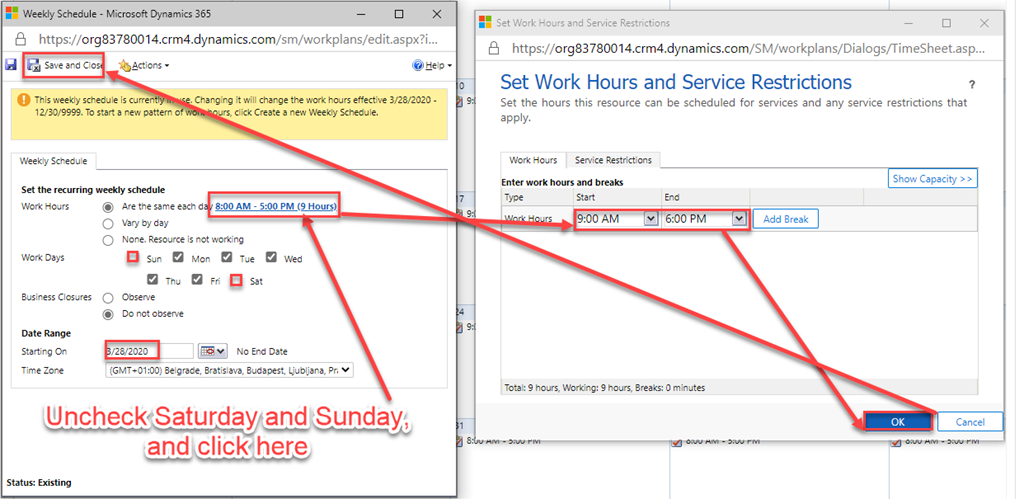

Step 5:

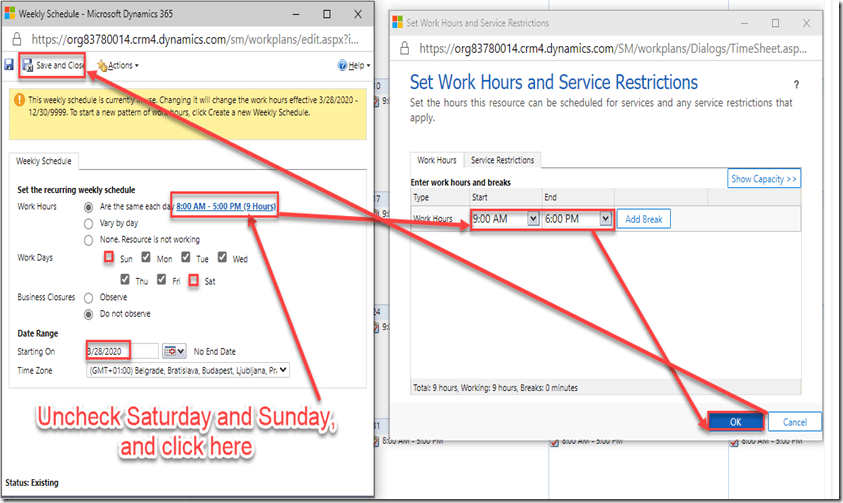

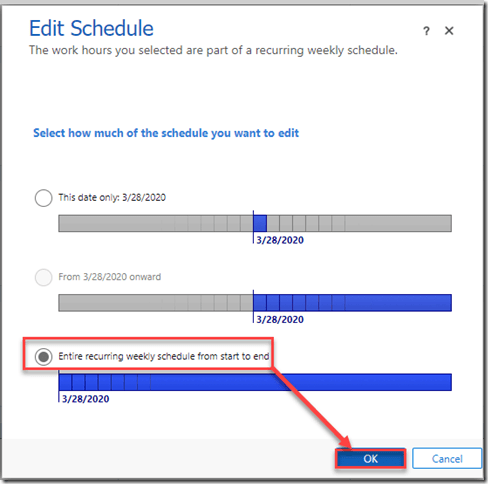

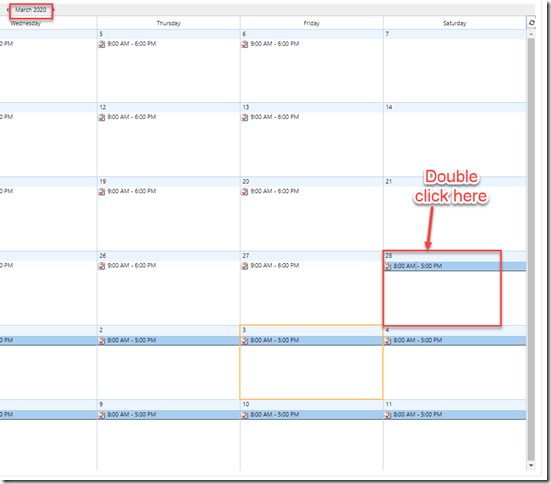

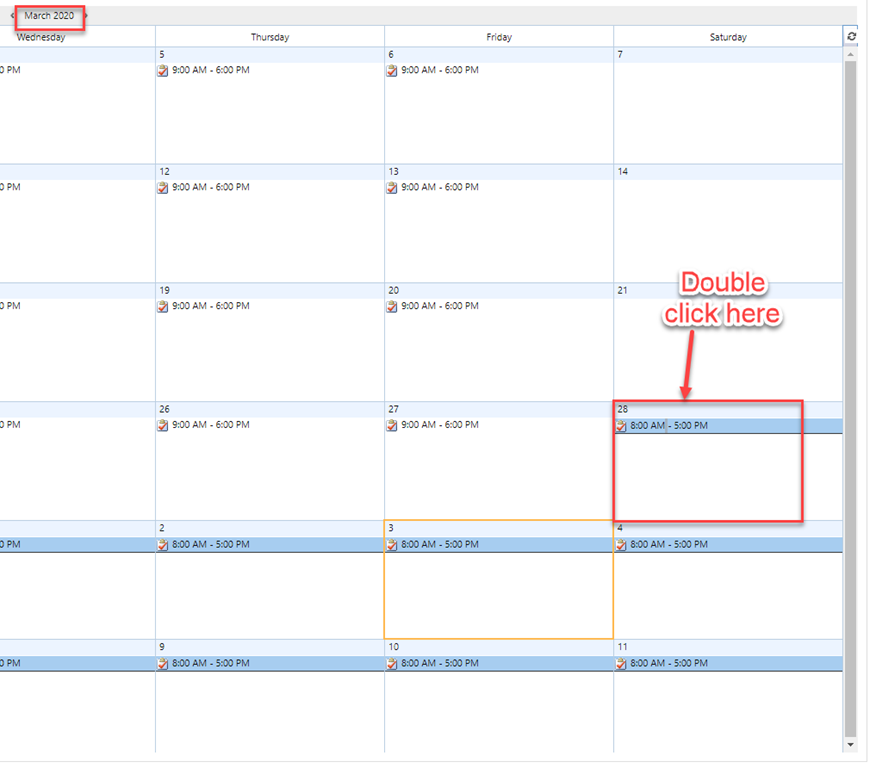

Since those working hours are valid only till 3/28/2020, I will repeat those steps and I will follow those steps:

and:

and finally:

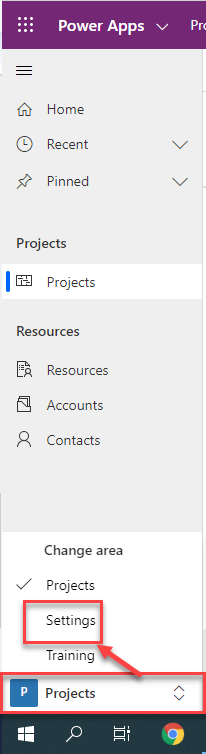

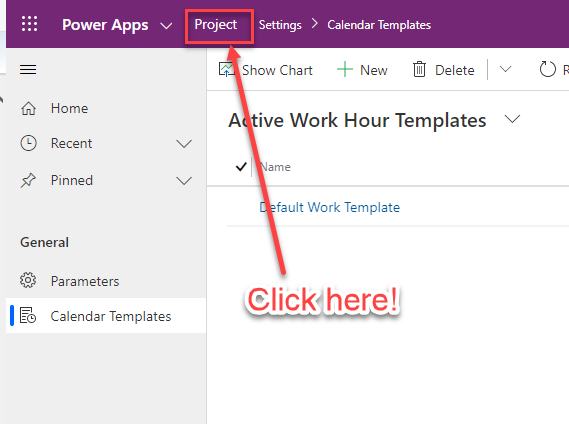

OK, now we should go back to the Settings:

and:

and then:

I will call my Template: Weekdays Calendar from 09:00 AM to 06:00 PM:

OK. I am done here!

Now I will create brand new Project for the Web:

OK, let me Create one Task with 8 days Duration and Task 7 hours, Task 8 hours,  Task 9 hours, and Task 10 hours:

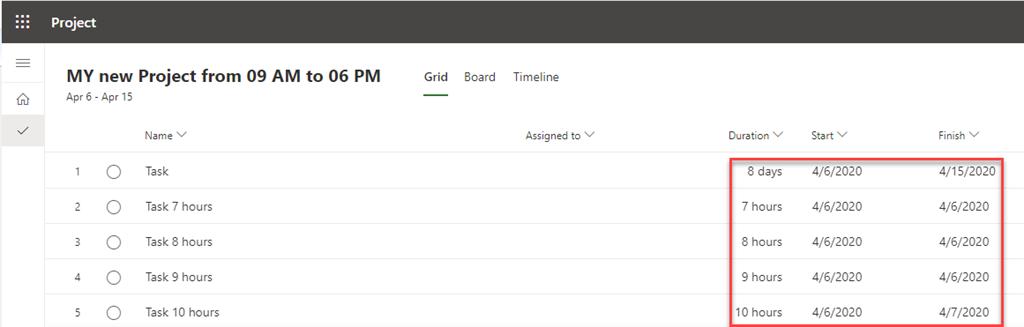

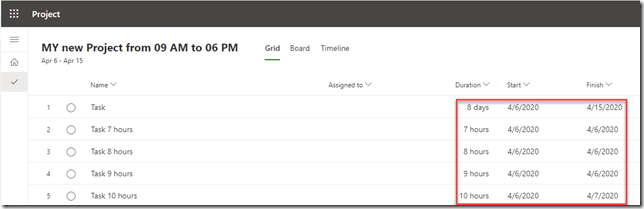

You can see, that Task with 8 days duration is going to be finished at 4/15/2020 e.g. at Wednesday (so Saturday and Sunday are non working hours). Also, you can see that duration of one day is 9 hours, not 8 anymore!

Complicated? Maybe. Powerful? Oh, yes!

Regards!
