There are four different task dependencies (relationships):
Finish to Start (FS): The finish date of predecessor task determines the start date of the successor task
Start to Start (SS): The start date of the predecessor task determines the start date of the successor task
Finish to Finish (FF): The finish date of the predecessor task determines the finish date of the successor task
Start to Finish (SF): The start date of the predecessor task determines the finish date of the successor task
When you link two tasks then the default relationship is Finish to start.
I will now add five tasks and assign a predecessor to Task 2,3,4 and 5 (default: FS):

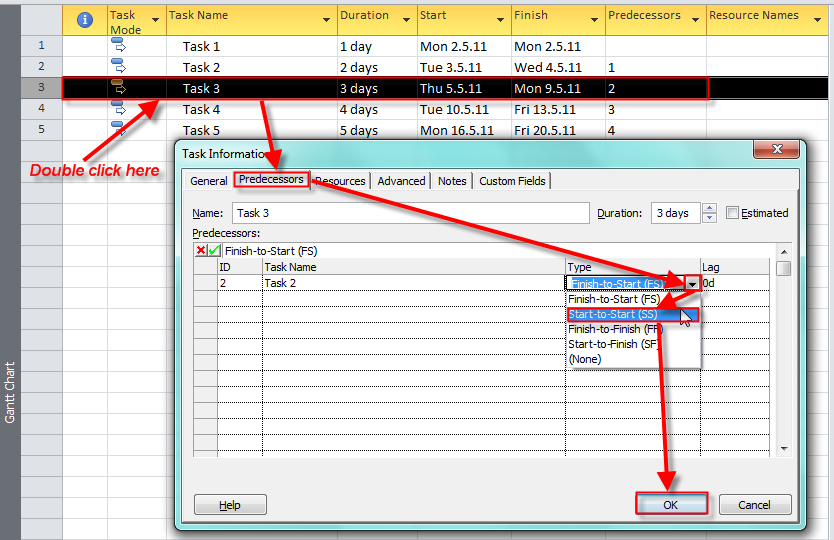

Now I will change the type of relationship between Task 3 and Task 2.
and I will get:
You can see that the Start Date of Task 3 is now the same as a Start date of Task 2, and the End date of Task 3 changed accordingly. And in the Predecessor field of Task 3 you will find 2SS (which means: Task 3 has Task 2 as predecessor, and the relationship is SS – Start to Start)
Now I will change the relationship between Task 3 and Task 4 in the same way, but I will establish Finish to Finish Relationship instead. And I will get:
You can see that the End Date of Task 4 is now the same as the End date of Task 3, and the Start date of Task 4 changed accordingly. And in the Predecessor field of Task 4 you will find 3FF (which means: Task 4 has Task 3 as predecessor, and the relationship is FF – Finish to Finish)

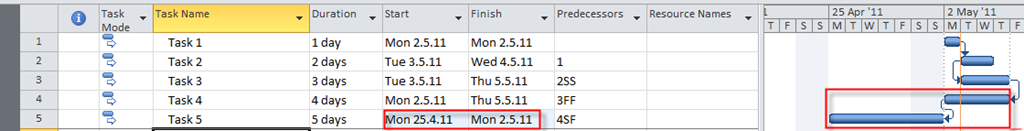

Now I will change the relationship between Task 4 and Task 5 in the same way, but I will establish Start to Finish Relationship instead. Notice that project start date is Monday, 02.05.2011 (this is Start date of Task 1). When I choose Start to Finish relationship and I click the OK button I will get:

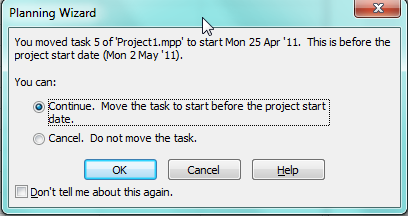

MS Project warns me that if I choose Start to Finish relationship Task 5 will be moved to start date 25.04.2011 which is earlier than project start date (02.05.2011). This happens because in Start to Finish relationship Start date of Task 4 is Finish date of Task 5. Start date of Task 4 is 02.05.2011 and because Finish date of Task 5 is the same and the duration of the Task 5 is 5 days, Start date of Task 5 must be moved 5 days earlier than 02.05.2011 which is 25.04.2011 and it is before the Project start date (02.05.2011). I will choose OK and I will get:
