How to Delay Project in MS PROJECT 2019

Hi all,

I have a question from one of my Blog readers: “The project I am involve in  is using only material resources and the unit rate for each resource did not change through time. Currently the project has more than 4 years of delay . Depending on the current status how am I going to forecast the project end date using Microsoft Project.”

I will show how to do it with MS PROJECT 2019. First of all since only Material Resources are used in Project, I will now use them in my example, because cost remain the same.

Here is on simple Project which starts at 01.01.2019:

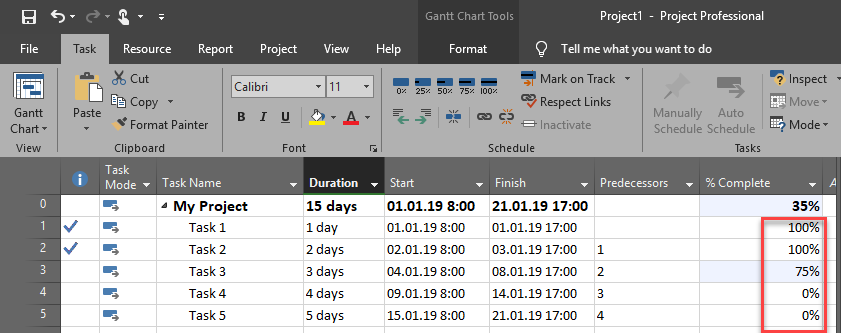

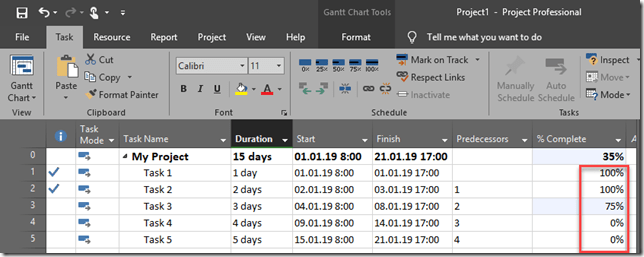

Now, let’s say that Task 1, and Task 2 are finished 100%, and Task 3 is finished 75%:

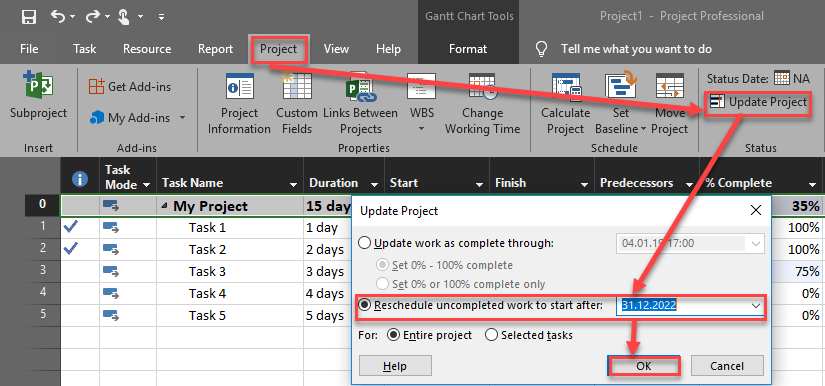

As you can see Project end date is 21.01.2019. Now, let’s say that for some reasons Project has ben postponed, and it will be restarted  01.01.2023. It is easy to put in MS PROJECT:

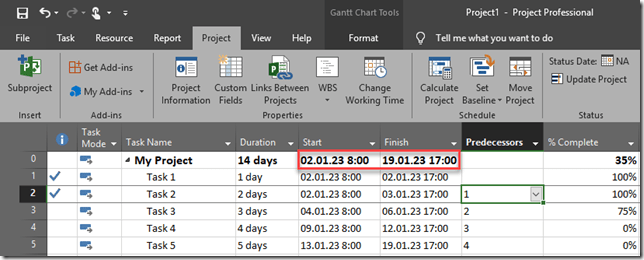

After I click OK button I will get:

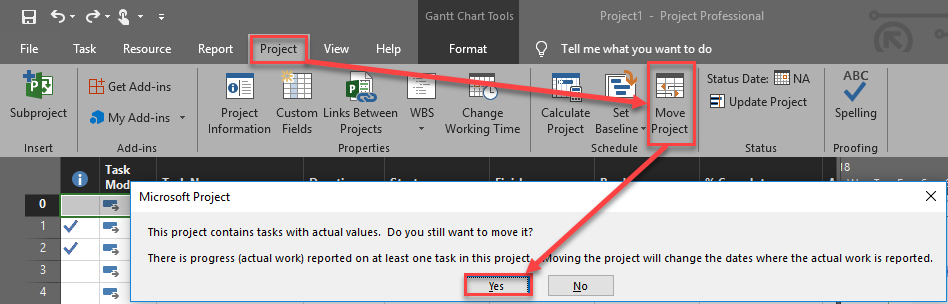

BUT, if I use Move Button, I will get different results:

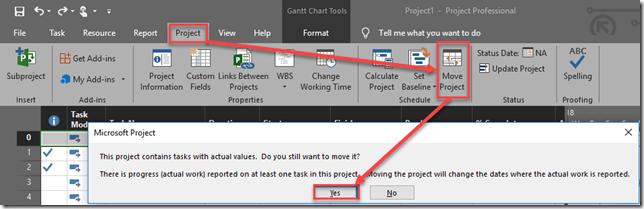

and:

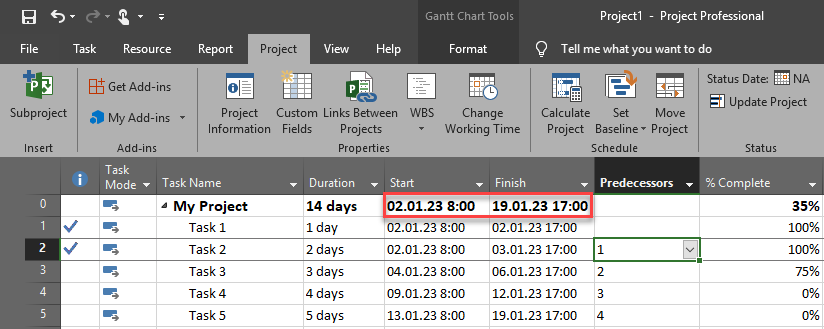

and I will get:

As you can see, the whole Project is moved (finished, and unfinished Tasks).

So be careful what will you use.

Regards!

Unknown's avatar

About Nenad Trajkovski

Location: Zagreb, Croatia Occupation: Project Manager Interests: Project Management and MS PROJECT He was born in Zagreb, Croatia at 1963. After completing his college he started working on projects in different business areas (banking, manufacturing, automotive industry, distribution, oil companies, etc.) developing and implementing ERP systems into different companies. He has got a lot of experience working with people in different business processes and also possesses great knowledge in information technologies and financial services. Today he works as a business consultant, adn Project Manager in PERPETUUM MOBILE d.o.o. Zagreb. He is a regular lecturer for Project Management in MS Innovation Center in Varaždin, Logosoft Sarajevo in Bosnia and Herzegovina and SEAVUS GROUP in Skopje Macedonia. He was named the best lecturer of WINDAYS 2008 while his lecture was also voted as the best. In addition, he was in TOP 10 lecturers at the MS SINERGY 2009 and MS VISIA 2009, 2010. Shares first place as the best lecturer of KulenDays 2009 and 2010 and PMI Conference 2009 in Zagreb. He is also a regular lecturer in the MS Community. He is a Certified Accountant and a PMP (Project Manager Professional) and a PMI-RMP (Risk Manager Professional), MCP, MCT, and Microsoft Certified Technical Specialist - Microsoft Project 2010. From 01.01.2012 awarded with MVP (Microsoft Most Valuable Proffesional - Microsoft Project)!
This entry was posted in MICROSOFT PROJECT, MICROSOFT PROJECT 2019, Micsrosoft Project 2016 and tagged . Bookmark the permalink.

Leave a Reply
