“Keep task on nearest working day when changing to automatically scheduled mode” option in MS PROJECT 2016

Hi,

a lot of my Blog readers asked me about “keep task on nearest working day when changing to automatically scheduled mode” option in MS PROJECT! I will show you what is it, and how does it work in MS PROJECT 2016!

First I am going to crate simple Project with two Tasks, one Automatically Scheduled, and other Manually Scheduled:

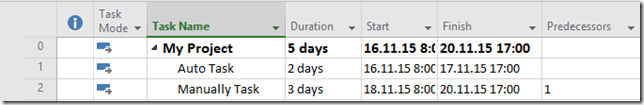

As you can see, I manually put Start Date for Manually Task to Saturday, 21.11.2015.

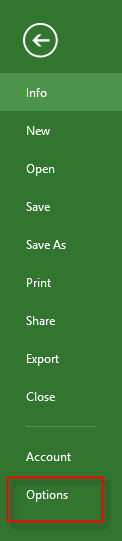

Now, where can I change “keep task on nearest working day when changing to automatically scheduled mode” option?


then:

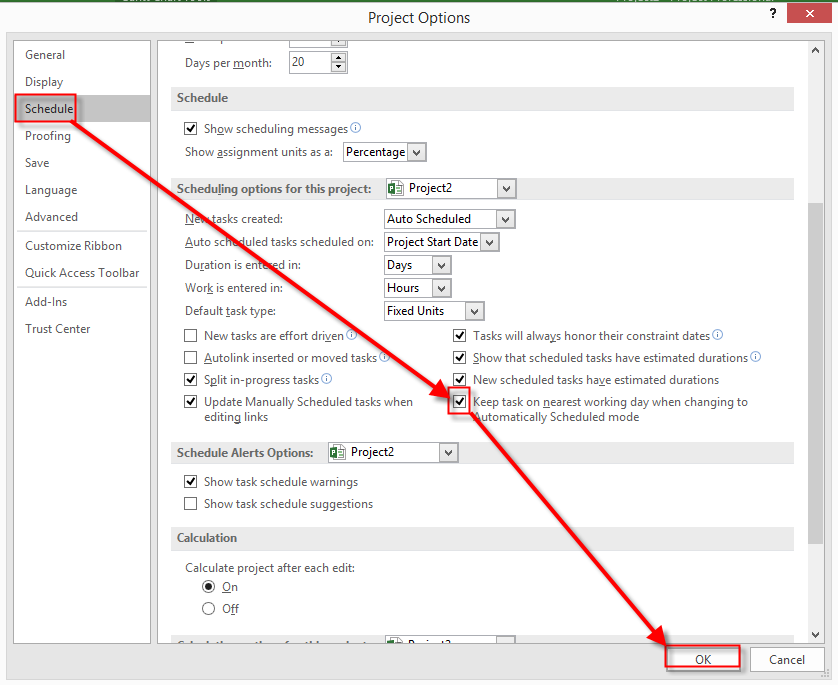

and then:

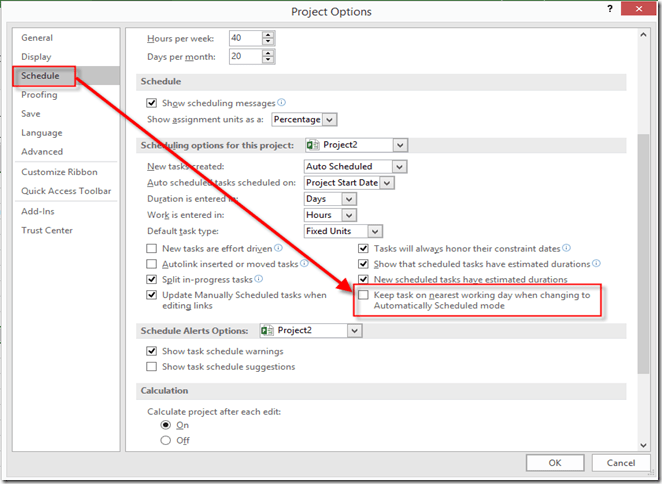

Now, I will change Manually Task (second Task), to Auto Mode, with this option unchecked, and I will get:


You can see that Start Date for this Task is changed to Wednesday, 18.11.2015, immediately after Finish date of first Task. But, what if I check “Keep task on nearest working day when changing to automatically scheduled mode” option?


and then I change Manually Task (second Task), to Auto Mode? I will get:

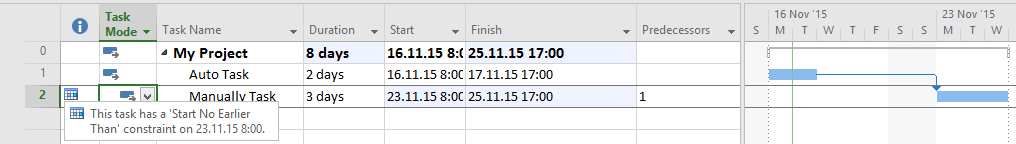

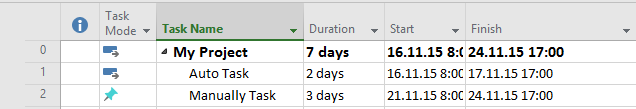

As you can see, Start Date for Second Task is now Monday, 23.11.2015 (the nearest working day to previous date, which was 21.11.2015), and this Task has Start No Earlier Than constraint.

So, if you want that your Task remain with same (or nearest) Start Date when you change it from Manually to Automatically scheduled mode, this option should be checked. On the other hand, if you want that MS PROJECT recalculate Start Date according to its predecessors when you change it from Manually to Automatically scheduled mode, leave this option unchecked. It’s up to you. As simple as that.

Regards!
