Hi,

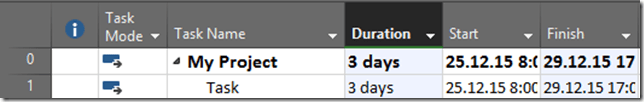

friend of mine got a problem. He has Task in which he wants to put Actual work and Actual Finish date for the Task, but he got odd result. Let me show you a problem with MS PROJECT 2016. firs I am going to create a simple Project with one Task:

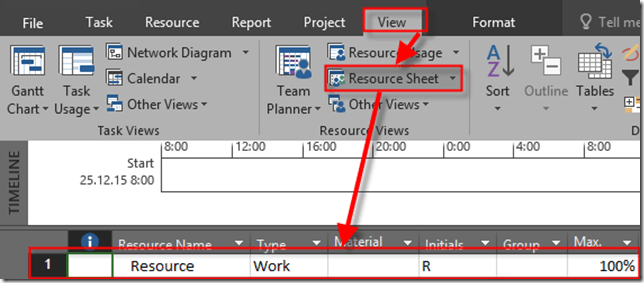

I will create a Resource with 100% availability:
and I will assign Resource to the Task:

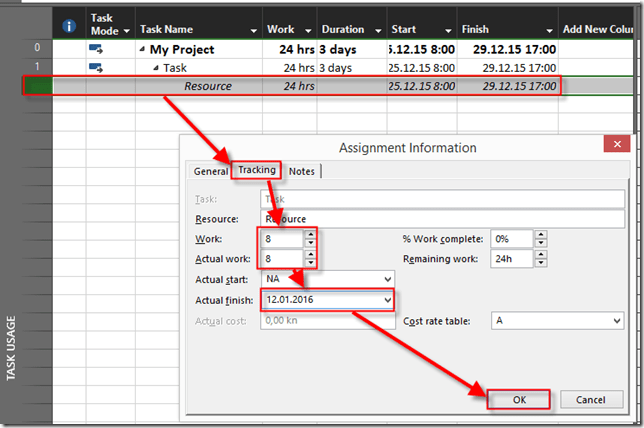

Now suppose that Task is finished at Tuesday, 12.01.2016, and Actual work is 8 hours. Simple, Resource worked only 8 hours to finish the Task during period from 25.12.2016 to 12.01.2016.
I will use Task Usage View:

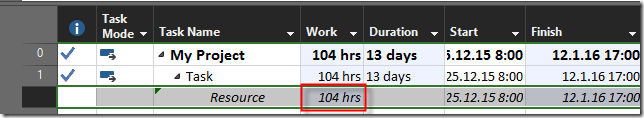

and I will get:

As you can see work is 104 hours, not 8. Is it a bug? Not at all. Because from 25.12.2015 to 12.01.2016 is 13 working days and 13 * 8 hours per day is 104 hours. If you want to have fixed period (Start and Finish date), and fixed hours, you should have Fixed work Task Type:

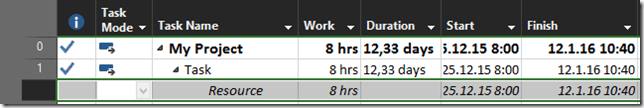

Now I will put same values here:

and I will get:

To conclude, if you want to have fixed hours, and Fixed Actual Start and End Date, use Fixed work Task Type!
Regards!
