How to assign 0$ costs for some Task with the same Resource in MS PROJECT 2013?

Hi,

one of my Blog readers has a problem:

“Good morning, Sir.

I have a slight problem with my project. For some tasks the cost of one resource for tasks is 0$. We have the resource standard rate is 75$/hr for that resource in Resource Center section.
When I tried to create new sample task such as “paint the wall “with the same resource, we assign 1 day of work, and the cost is show up for 600$.

So what is the reason for the missing cost-tasks? and How can we fix it?”

There is a easy way to do it!

First I will make two Tasks for my Project:

I will create one Resource:

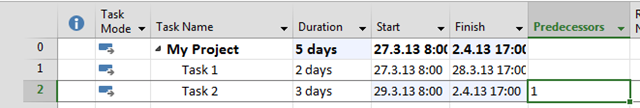

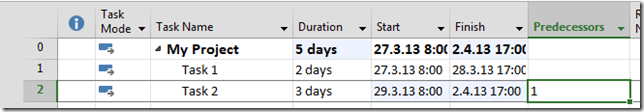

Now I will assign Resource to Task 1, and Task 2.

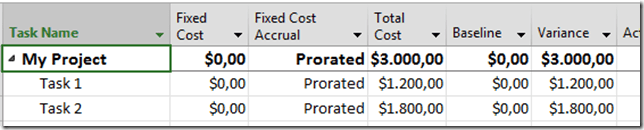

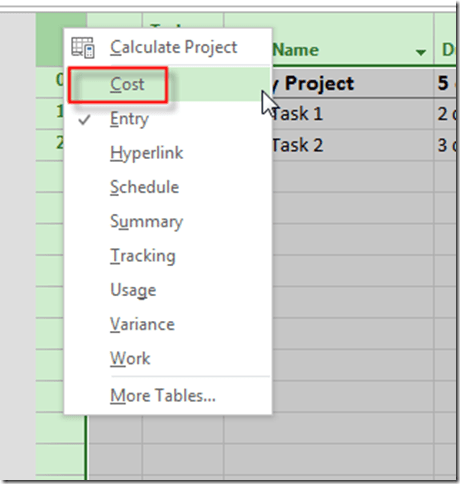

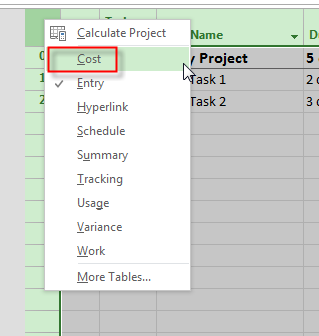

Let’s look at the Cost Table:

and:

But for the Task 2, I want $0 of costs. Piece of cake!

First I will apply Resource Usage View:

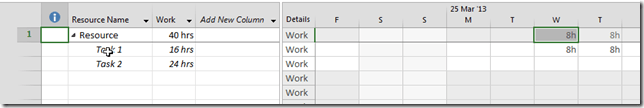

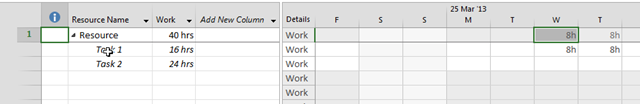

and I will get:

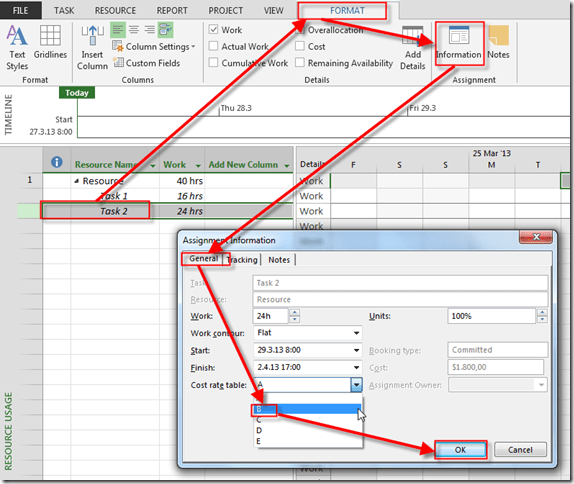

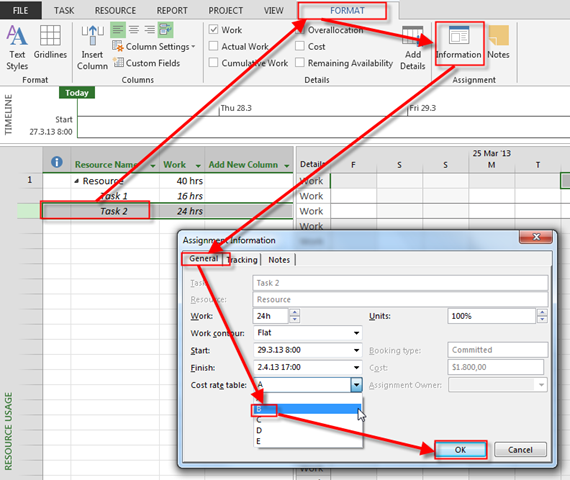

Now I will apply Table B (with $0 rate) for the Task 2:

and, back to the Cost Table:

As you can see, Task 2 has Total Cost=$0.

Regards,
