How to show duration in different units for the same Task in MS PROJECT 2016

Hi,

today I’m going to show you ProjDurConv function which is very useful in MS PROJECT 2016.

Here is the Scenario. Suppose that I have a simple Project with one Task, and it’s Duration is 5 days:


I want to see Duration in hours as well. So, in my example I should see 40 hours because my Project is set up like:


and:


and:


So 5 days are 5 * 8 = 40 hours.

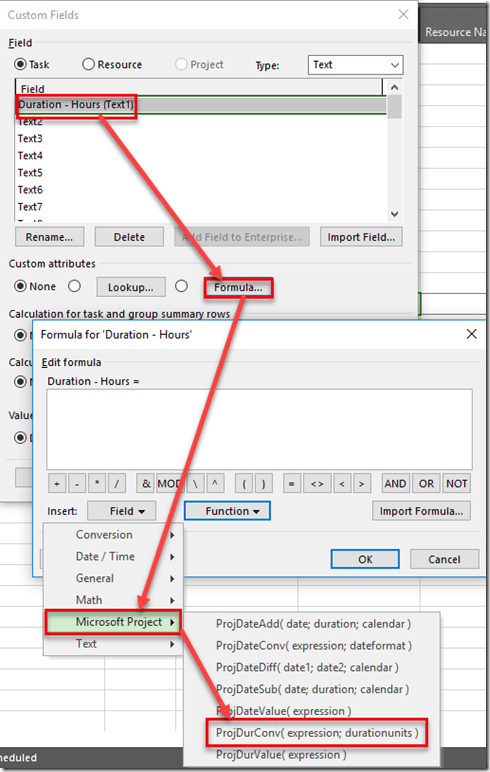

To show this 40 hours I will use custom field with ProjDurConv function (follow this example step by step):


then:


then:


then:


So, MS Project will convert duration from Days  (which is in Duration field), to hours (mention in pjHours).

Now I will show this column in My Gantt Chart:

SNAGHTMLf58948d

Now you can see for one Task, Durations in two different Units of Measures.

I will now Define two resources, John and Mary:

SNAGHTMLf5a4114

Now I will assign John and Mary to the Task (notice That john will be assigned with 50% Units):

SNAGHTMLf5bcf46

As you can see in Work column (which I put in the Gant Chart View), it is 60 Hours (5 days * 8 hours per day for Mary = 40 hours + 5 days * 4 hours per day for John = 20 hours in Total = 60 hours).

OK! Finally I want to see Duration in days but according to work (I want to see how many man days will I spend to this Task). In this case I will use third Custom filed called Man Days:


So, MS Project will convert Work from Hours  (which is in Work field), to Days (mention in pjDays).

Finally I will but this custom field on the Gantt Chart:


As you can see, in Man Days I’ve got 7,5 days (60 hours of total work / 8 hours per day shown in Hours per Day = 7,5 days).

As you can see ProjDurConv is powerful Function and I use it a lot.

Regards!
