How to show different Baseline in Gantt Chart–MS PROJECT 2016

Hi,

I’ve got a question about MS PROJECT 2016:
“Dear Nenad,
How we can have a new baseline (adding task or resource and delete task or resource) and how viewing that new baseline on the Gantt Chart.”

I will show you how to da this Step-by-Step.

1. First I will create a brand new Project:

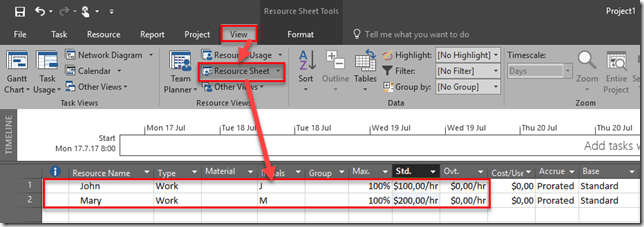

2. I will have Two Resources on the Project – John and Mary:

3. I will assign Resources to those Tasks:

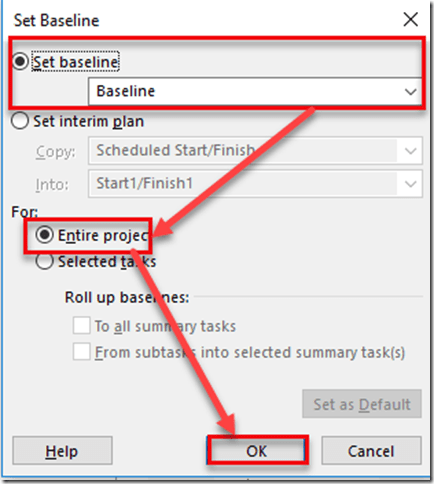

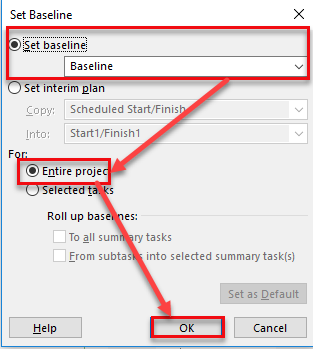

4. I will save the Baseline:

and:

5.  To see Actual Schedule and Baseline Schedule I will use Tracking Gantt View (and you should as well, because this View is justofor that):

Red Bar shows Actual Schedule and Grey Bar shows Baseline Schedule (it is static or frozen)

6. Suppose that Project Plan has changed and I do not need Task 2 no more, but I need Task 4 = 4 days Duration with Task 3 as Predecessor, and Mary will work on that Task (I will show that on regular Gant Chart):

On the Tracking Gantt it looks like:

7. As you can see it looks like a mess. Since this is our new Project Plan we will save it as a separate baseline:

and:

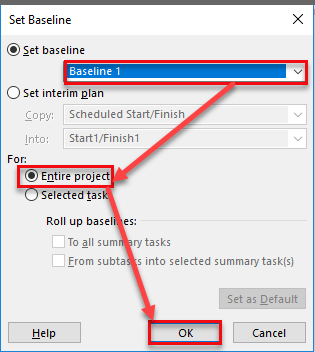

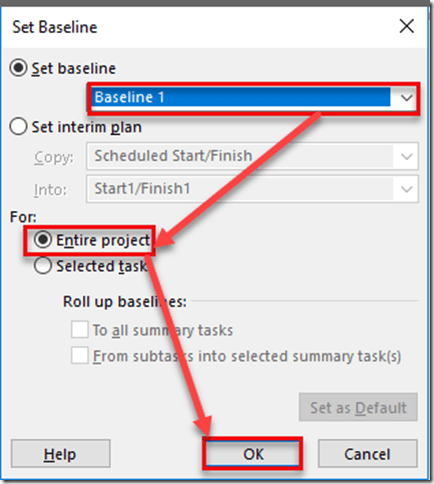

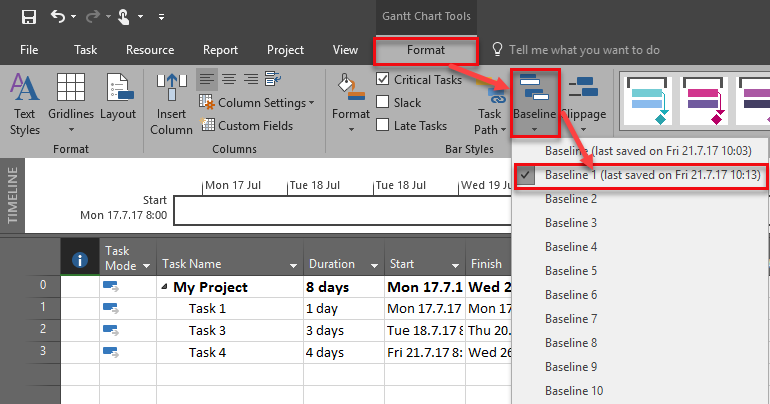

8. Finally I will show this new Baseline (Baseline1) in Tracking Gantt View):

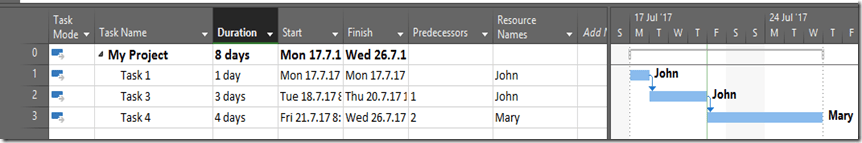

Finally I will get:

I hope this helps.

Regards!
