Setting Up Pay Rates to Apply at Different Times

Hi,

I will explain how can you enter up pay rates for a resource to apply at different times in MS PROJECT 2010

Suppose that you have a Resource with name Mary. Mary is working on your project, and se has 300$ / day. From 23.06.2011 she will has +50% more (e.g 450$/ day)

First I will add two tasks and I will link them:

Now I will add Mary as Resource:


I have left Standard Rate $300/day.

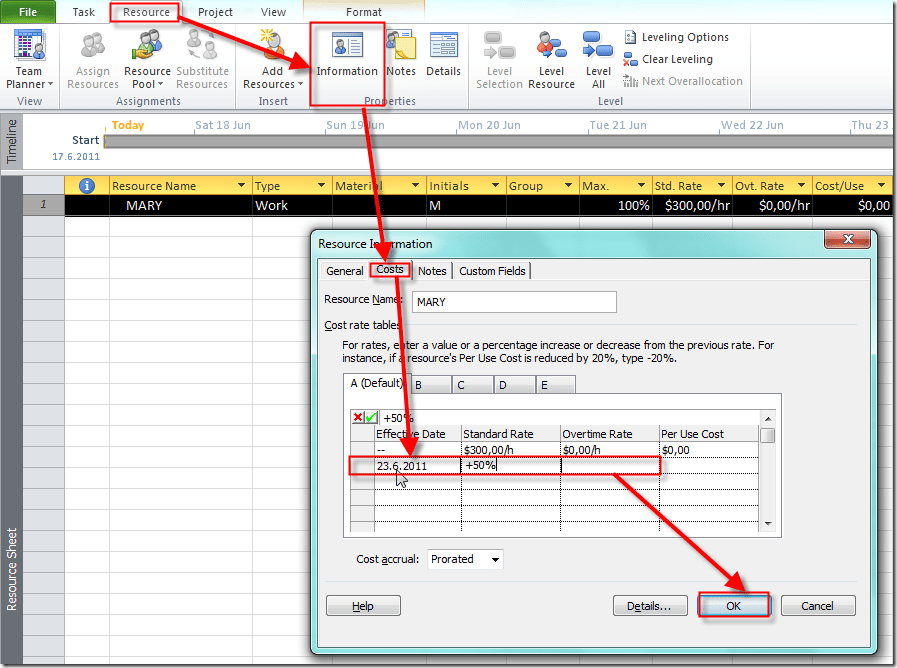

Now I will add two pay rates for Mary.   I will now +50%per day for Mary from 23.06.2011:

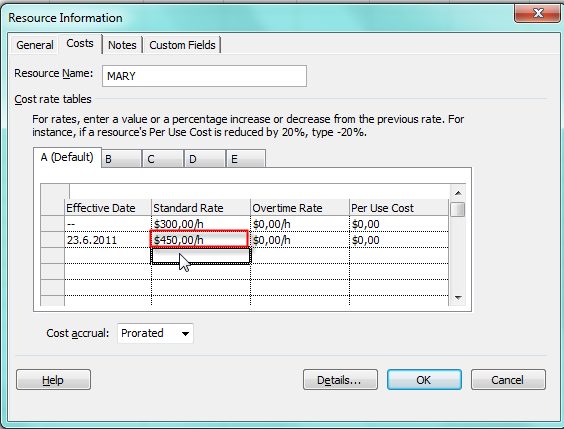

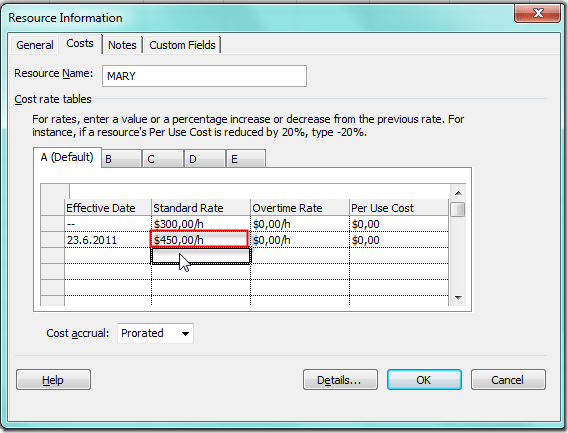

After I click OK I will get:




Now, I will assign Mary to the TASK 1:


You can see $7.200 in the Cost field. TASK 1 has 3 days duration, and Mary’s pay rate is $300/hour –> 3 days X 8 hours/day X $300 = $7.200

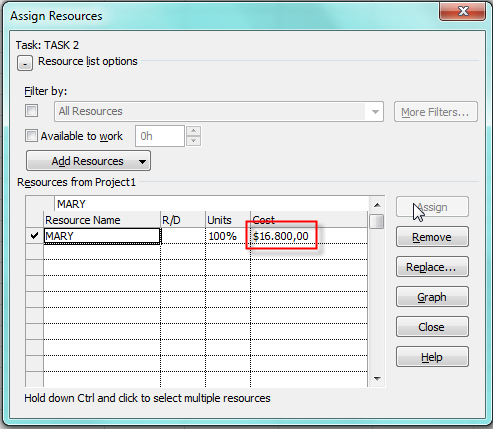

Now, I will assign Mary to the TASK 2:


You can see $16.800 in the Cost field. TASK 1 has 5 days duration, and Mary’s pay rate is $300/hour at 22.06.2011 and $450 from 23.06.2011 –> 1 day X 8 hours/day X $300 = $2.400 (22.06.2011) + 4 days X 8 hours/day X $450 (from 23.06.2011) = 14.400. $2.400 + $14.400 = $16.800

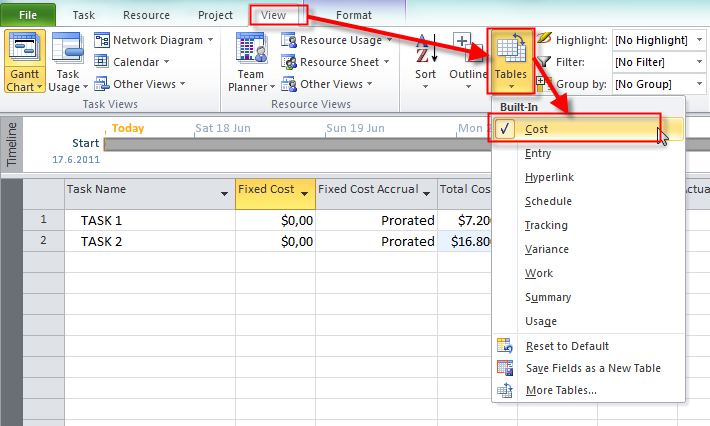

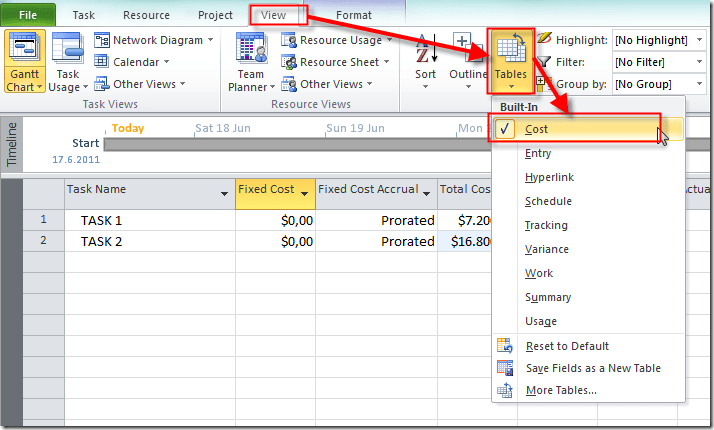

Now, I will choose the Cost Table:


and I will get:

image.

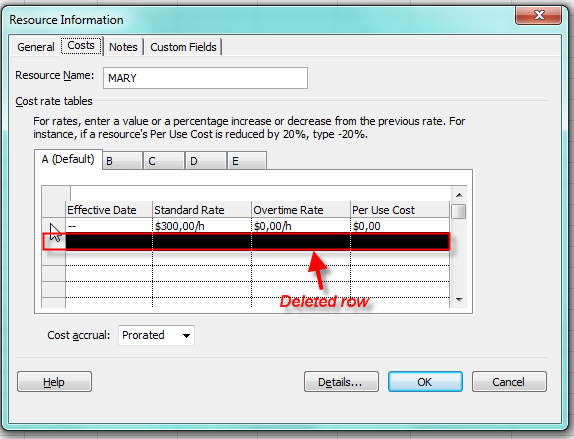

If I delete row from pay rate:


I will get in Cost Table:


Why? TASK 1 has 3 day duration, and TASK 2 has 5 day duration = 8 days. 8 days X 8 hours / day X $300 / hour = 19.200.

Be very careful when you are adding or deleting pay rate for resurces.
