Hi,
In this post I will show some “strange” behavior of MS PROJECT 2010 when I assign two resources to the effort driven, fixed duration Task!

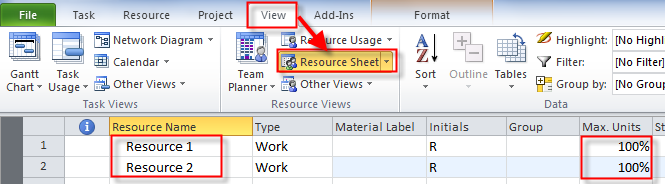

First, as always, set up! I will add two resources to the Project:

Now I will arrange my Gant Chart View in the way that I will add Work field, and I will apply Task Form as a detailed View:

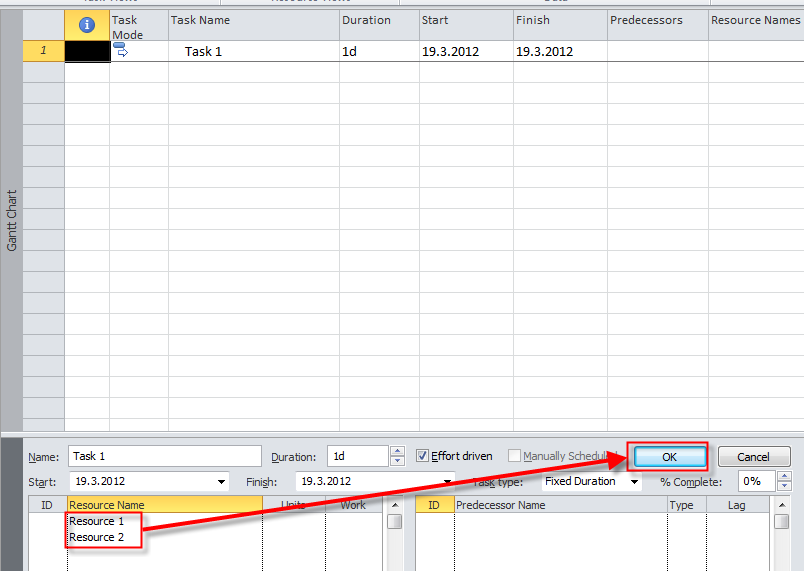

Now I will add a brand new Task:

Now I will assign Resource 1, and Resource 2 to the Task, at the same time:

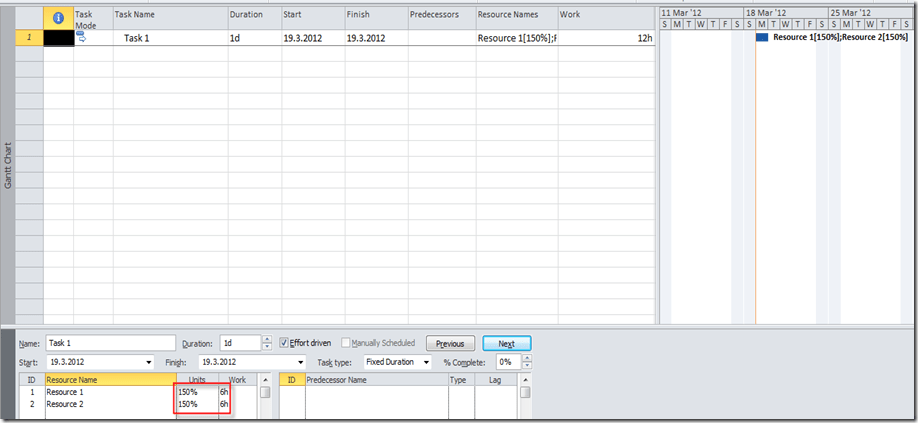

and I will get:

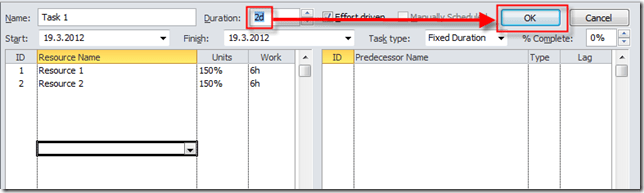

As you can see, Each Resource will work 6 hours per day with 150% units!? In MS PROJECT 2007 Units were 75% (6 hours are 75% of 8 hours, regular working time)! From my point of view, MS PROJECT 2010 consider that Each resource will work 12 hours and that will be 150% Units, because 150% of 8 hours = 12 hours!! Is it a BUG? Well, this is my opinion: YES, SURE IT IS!
Now, I will change Duration from 1 day to 2 days:

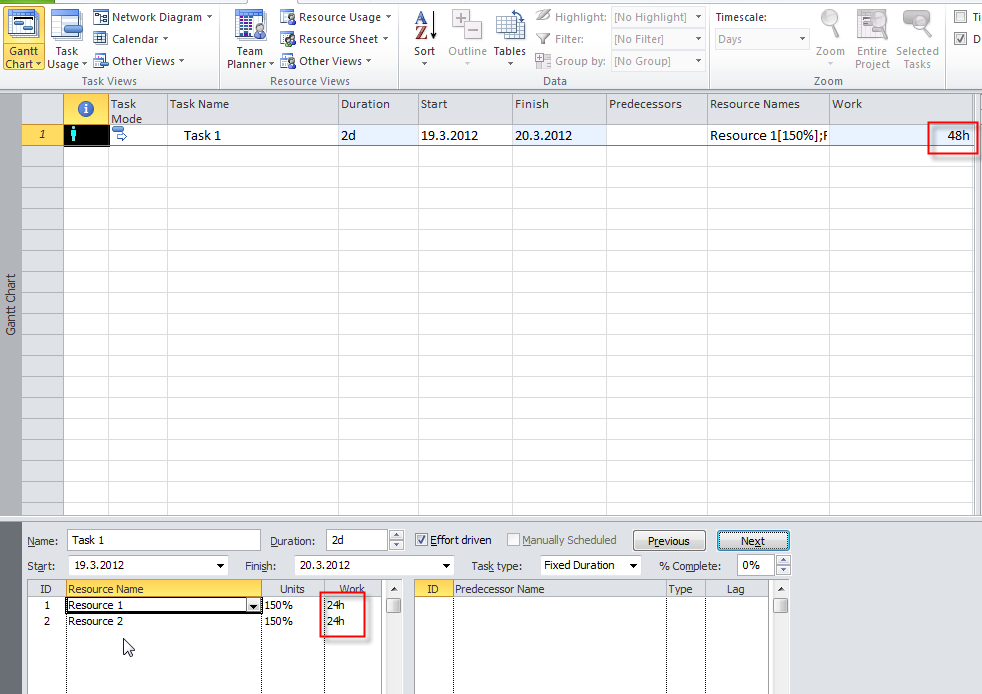

and I will get:

The explanation:
- Old Duration = 1 day, new Duration = 2 days
- Old Work (total) = 12 hours, new Work (total) = 48 hours
- Old Work (per Resource) = 6 hours, new Work (per Resource) = 24 hours
- Old Units = New Units = 150% per Resource
- WORK = DURATION * UNITS. Since Duration is 2 days, and the Task is Fixed Duration, MS PROJECT 2010 now calculates: WORK = 2 days * 150%. = 2 days * 2 resources * 8 hours per day * 150% = 4 * 8 * 150% = 32 * 150% = 48 hours!
Hmmmmmm!
Regards,
