Multiple Resource Pools in Subprojects in MS PROJECT 2013!

Hi,

I have a question from on of my Blog Readers: “Is it possible to use separate Resource to Projects, and then to see all Resources in one Master Project?”

The answer is: “YES” How? I’ll show you in MS PROJECT 2013!

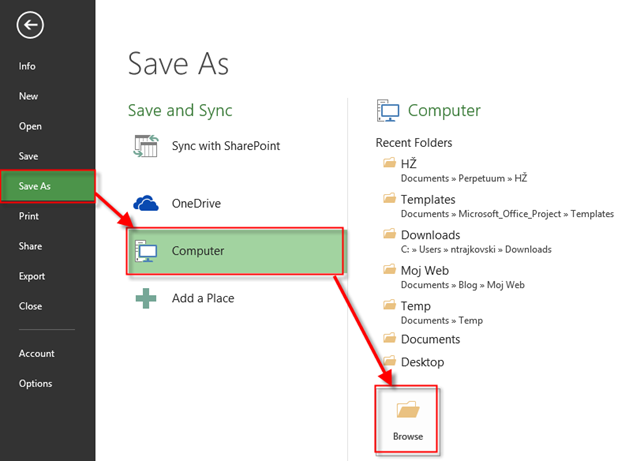

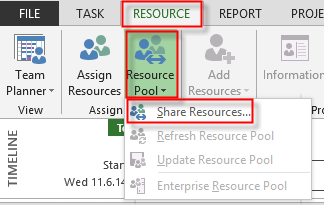

First I’ll create Resource pool (the first one):

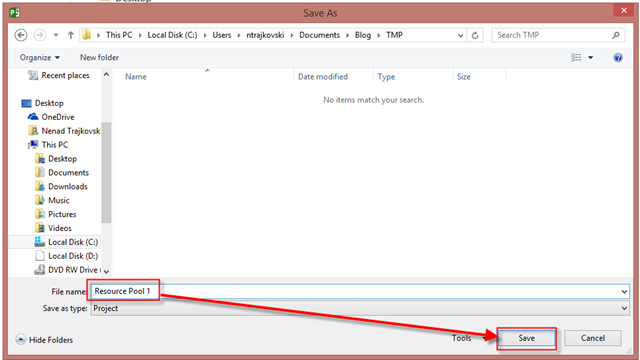

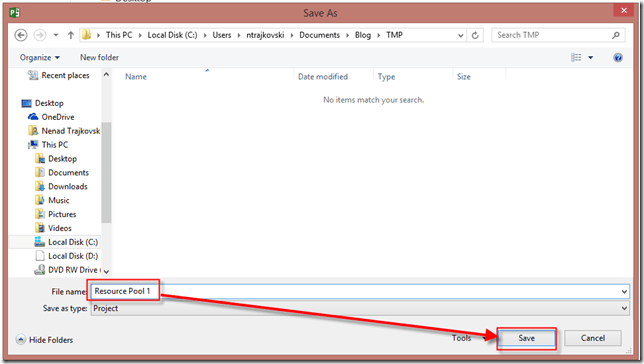

and I’ll save it:


and then:

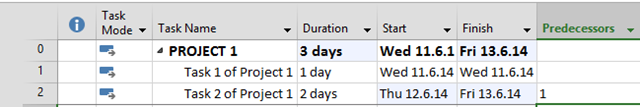

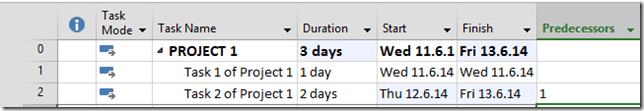

Now I will create two Projects with two Tasks and I will use same Resource Pool:

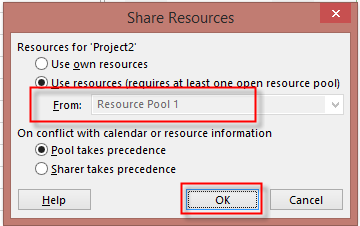

and then:


and:

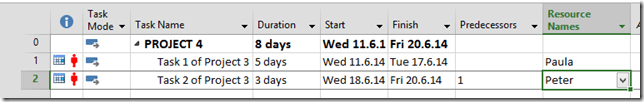

Now I will Assign Resources to Tasks:


Now, the Second Project:

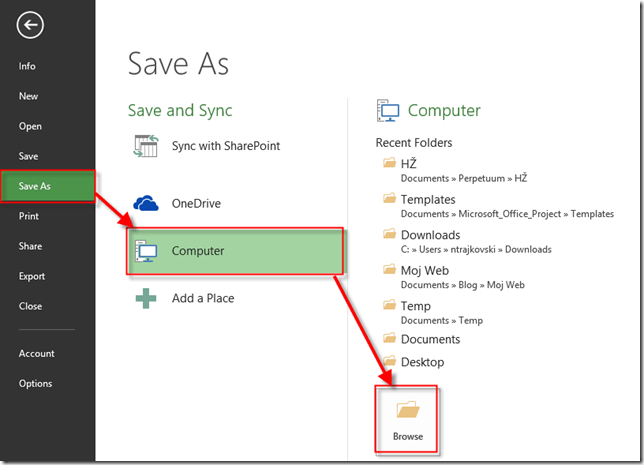

Now I’ll create Second Resource Pool:

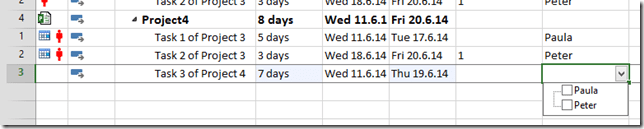

And another two Projects with two Tasks, and with Usage of this Second Resource Pool:


and:

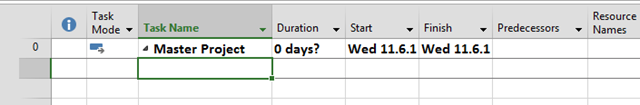

Now I’m going to cerate Master Project with Subprojects:

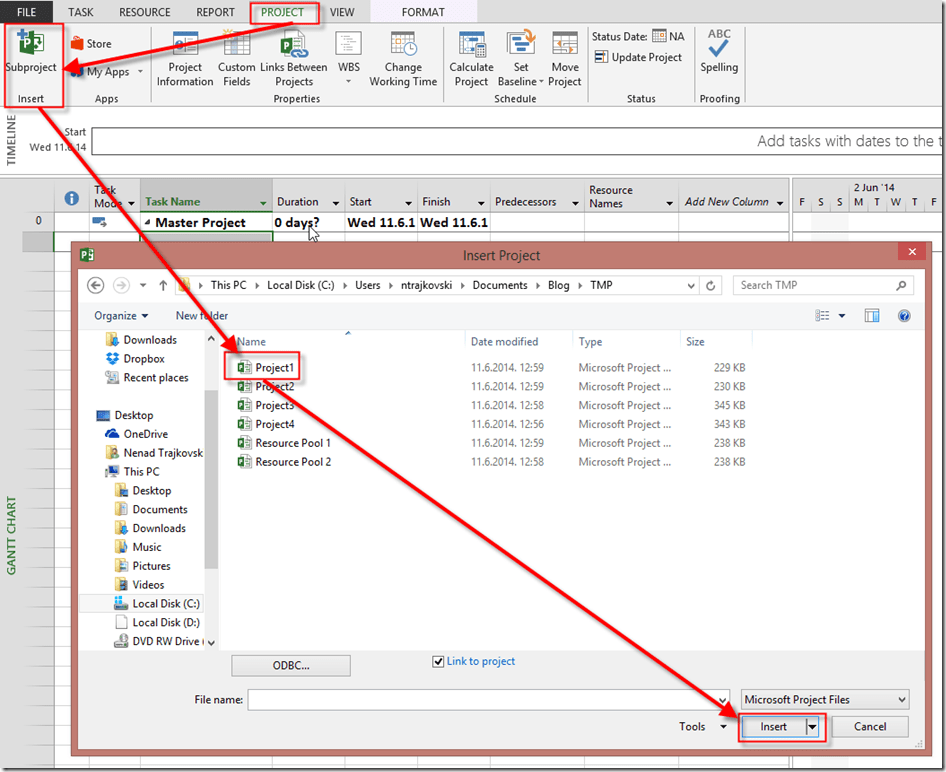

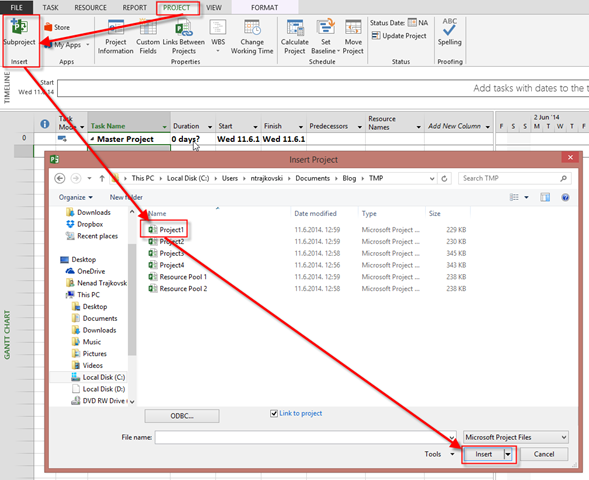

and I’m going to import four Projects like that:


and I’ll get:

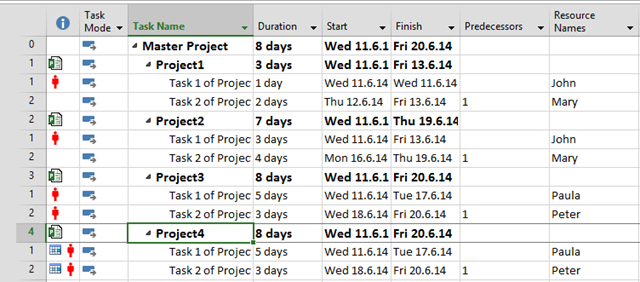

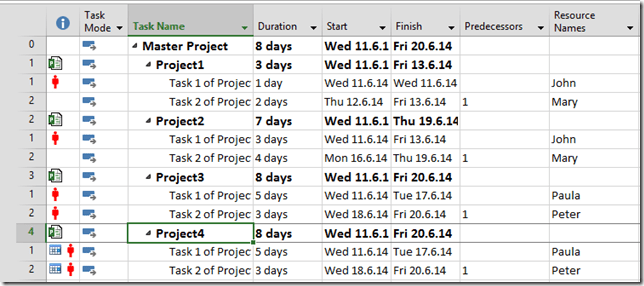

after I import all Projects I’ll have:


As you can see, all Resources are there. And both Resource Pools are open!

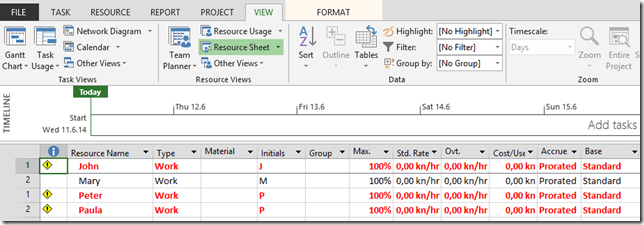

Lets see Resource sheet in Master Project:


OK! Now two Tips!

If you want to add Task to a Project4, for example, you can not use Resource from Resource Pool 1.

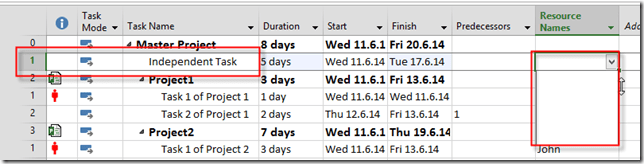

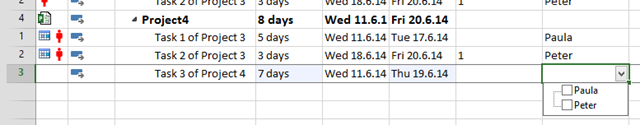

If you want to use independent Task like this:


You can not use any Resource from any Resource pool, either. And you can not assign independent Resource to that Task too! It is impossible!



Regards!
