Custom duration and date fields in MS PROJECT 2013

Here is a question form one of my Blog Readers:

“I have another possible bug in MSP 2013. Try this one
Insert Date1, Insert Duration1, Insert Date2. Now go to custom fields and make date2 a formula [(date1)+(duration1). The obvious answer would be a new date, but this is what I get.

Date1 Durat Date2
Tue 7/8/14 0d Tue 7/8/14
Tue 7/8/14 1d Sat 10/31/15
Tue 7/8/14 2d Wed 2/22/17
Tue 7/8/14 3d Sun 6/17/18
Tue 7/8/14 4d Thu 10/10/19
Tue 7/8/14 5d Mon 2/1/21

it seems to move almost 14 months.

Got any ideas on how to make this work?”

It is not a bug, but might confuse you. I’ll show you how it works in MS PROJECT 2013!

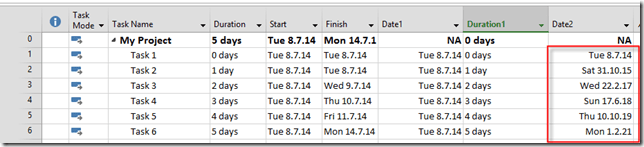

I will repeat steps like above:

I will add custom fields:

and I will put same dates in Date1 field, and same durations in Duration1 fields:

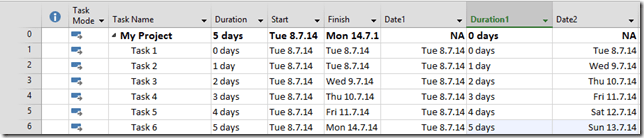

I will create formula for Date2 field:

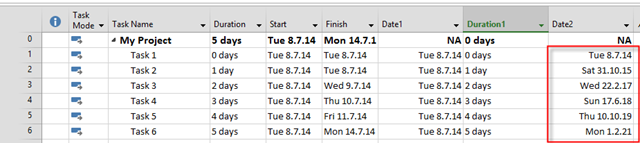

and I will get:

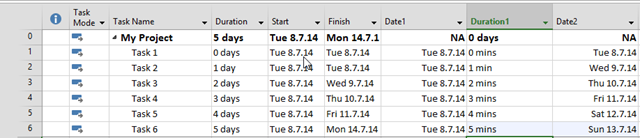

Strange, isn’t it? BUT! I will change Duration1 field with minutes:

It looks fine now. Why? Because Duration1 field is filled with 480 minutes per day. So when you put 1 day it is interpreted as 480 days! So to get right value in Date2, I should rearrange formula like this:

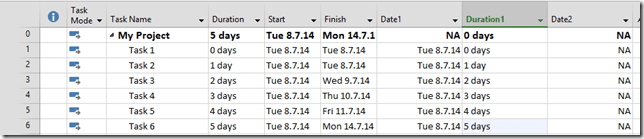

and I will get:

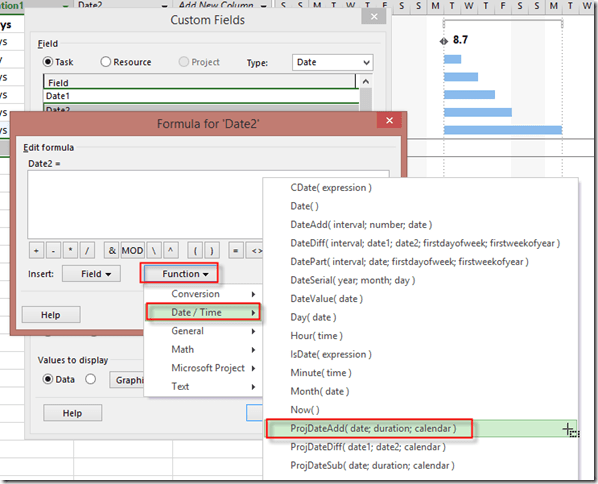

But if I want to consider my Project Calendar I can use this function:

and then:

and I will get:

Notice that Date 2 is same as Finish date. Of course, you can rename Duration field and call it, for example, pessimistic duration, and put different values than in Duration field.

Hope this helps.

Regards!
