The “Wedding” Project! Building the Schedule? – PART 5 (we are almost at the finish)

Hi,

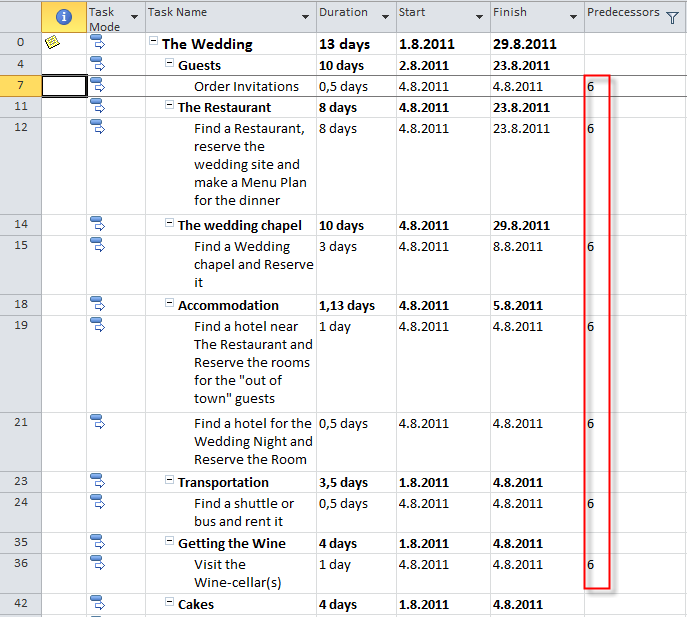

In my previous post I have explained that Task no 6: “Call the guests by phone to the wedding” is a Predecessor of lot of other Tasks. I will again apply a filter to see those task:

Because there are many of them, I decide to assign all those task to the “Wedding agency”, and it means that I have decided that the wedding couple will not perform or conduct all those tasks by themselves, because it will take a lot of time, and the wedding will be too late. Instead of that I will hire the “Wedding agency”, and that means that the agency has a capacity to conduct all those tasks (with predecessor no 6).

OK. If you remember my wedding should be at Saturday. So I have to examine in my Project plan the nearest Saturday. I have to find know ending date of my project according to my current Project Plan:

So, the end date id 29.08.2011. And I suppose that I will find the wedding chapel and the Restaurant which is available the nearest Saturday to that end date. And this is 03.09.2011.

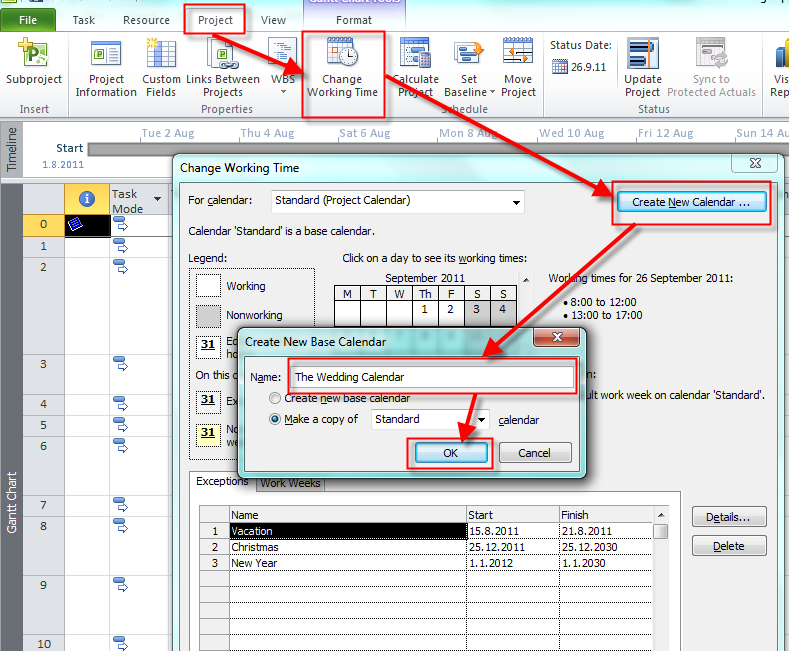

Now the fun begins. There are a couple ways to solve these problems. I will make NOW new calendar for “wedding” tasks:

and then I will erase exceptions:

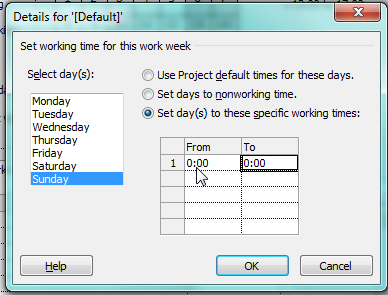

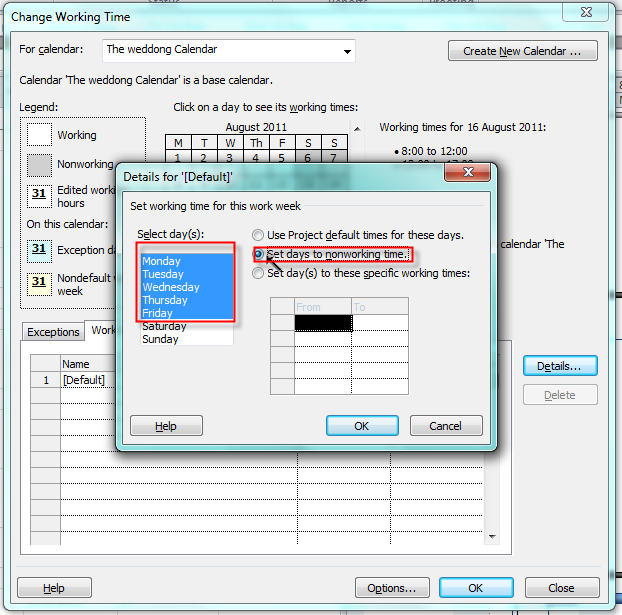

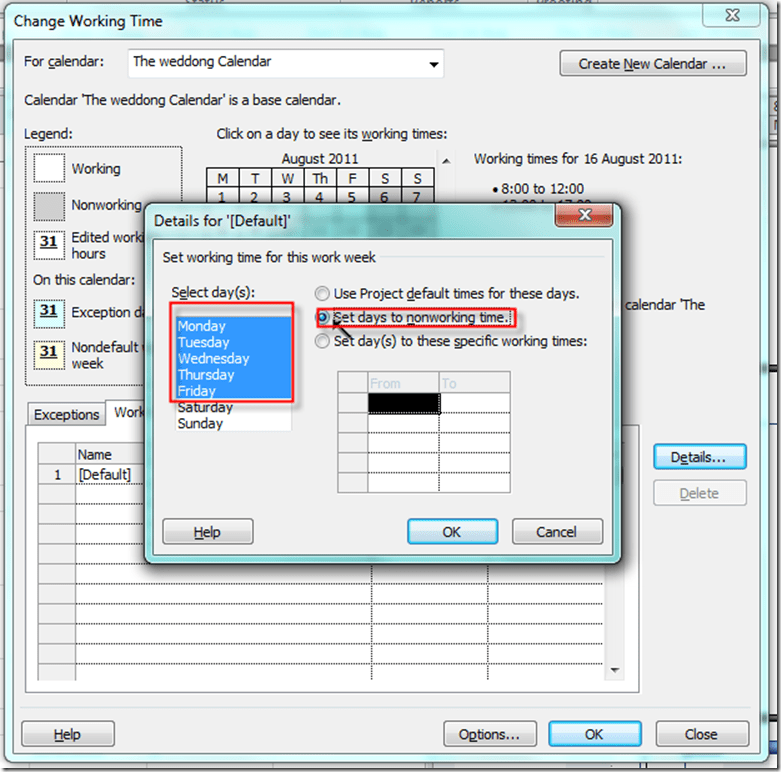

No I will set working time from Saturday 08:00 to 00:00 and Sunday from 00:00 to 00:00:

and:

and finally:

Now I will assign this new calendar to my “wedding” Tasks:

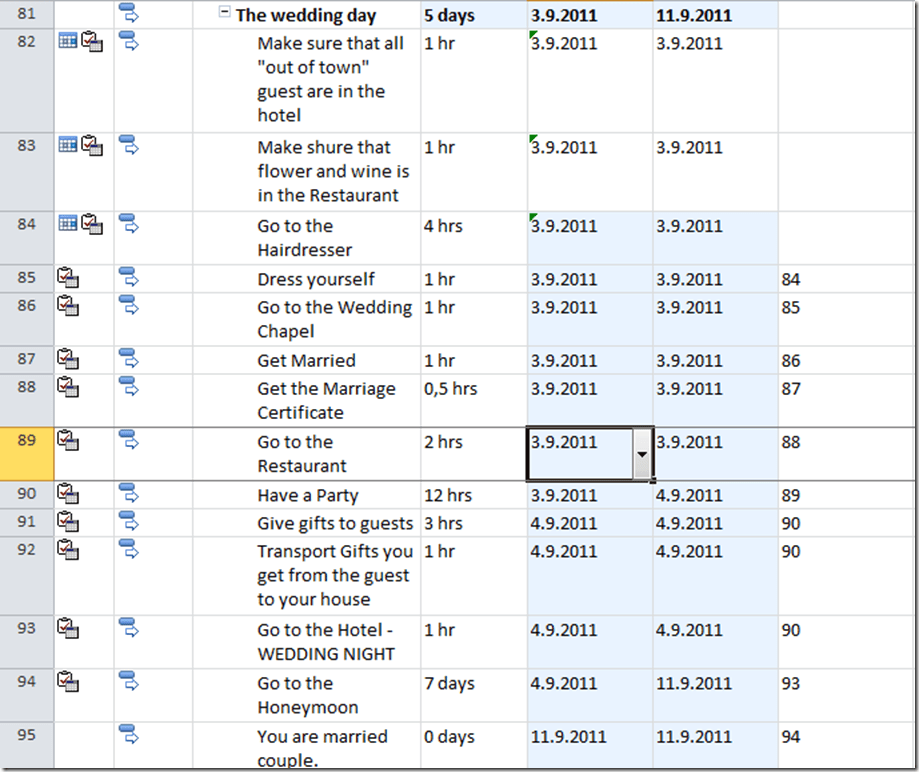

and I will get:

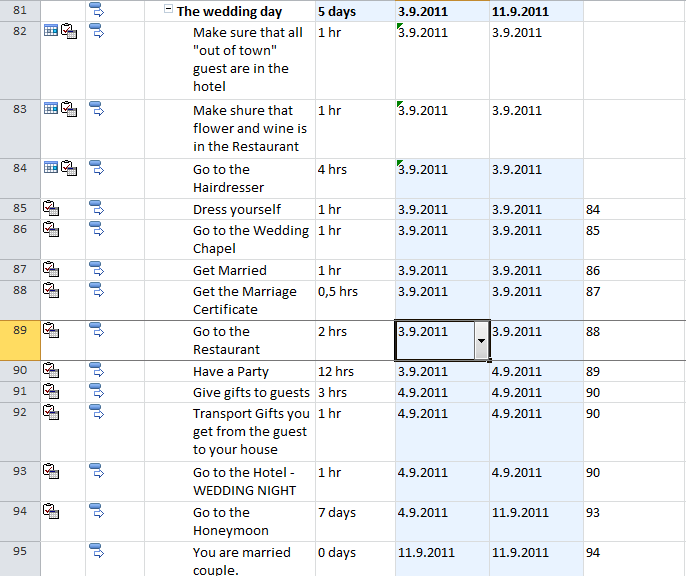

As you can see the start date is 06.08.2011. But this is not what I want.

First I will make a 03.09.2011 as a start date (because THIS IS RIGHT SATHURDAY FOR THE WEDDING):

But I still have to fix some things.

And I will fix them in my next blog post.

I promise the next blog will be the last one with the scheduling of my “Wedding” Project!

Until then,

Best Regards,

Advertisement

About Nenad Trajkovski

Location: Zagreb, Croatia Occupation: Project Manager Interests: Project Management and MS PROJECT He was born in Zagreb, Croatia at 1963. After completing his college he started working on projects in different business areas (banking, manufacturing, automotive industry, distribution, oil companies, etc.) developing and implementing ERP systems into different companies. He has got a lot of experience working with people in different business processes and also possesses great knowledge in information technologies and financial services. Today he works as a business consultant, adn Project Manager in PERPETUUM MOBILE d.o.o. Zagreb. He is a regular lecturer for Project Management in MS Innovation Center in Varaždin, Logosoft Sarajevo in Bosnia and Herzegovina and SEAVUS GROUP in Skopje Macedonia. He was named the best lecturer of WINDAYS 2008 while his lecture was also voted as the best. In addition, he was in TOP 10 lecturers at the MS SINERGY 2009 and MS VISIA 2009, 2010. Shares first place as the best lecturer of KulenDays 2009 and 2010 and PMI Conference 2009 in Zagreb. He is also a regular lecturer in the MS Community. He is a Certified Accountant and a PMP (Project Manager Professional) and a PMI-RMP (Risk Manager Professional), MCP, MCT, and Microsoft Certified Technical Specialist - Microsoft Project 2010. From 01.01.2012 awarded with MVP (Microsoft Most Valuable Proffesional - Microsoft Project)!
This entry was posted in MICROSOFT PROJECT, Microsoft PRoject 2010, MS PROJECT 2010, PMI, PRoject Management and tagged , , , , . Bookmark the permalink.

4 Responses to The “Wedding” Project! Building the Schedule? – PART 5 (we are almost at the finish)

  1. JoAKA says:

    Hi Nenad, can you send me this mmp project please?

  2. architektura wnętrz says:

    *WONDERFUL Post.thanks for share..more wait .. …

  3. Nenad Trajkovski says:

    Thank’s a lot!

Leave a Reply

Fill in your details below or click an icon to log in:

WordPress.com Logo

You are commenting using your WordPress.com account. Log Out /  Change )

Facebook photo

You are commenting using your Facebook account. Log Out /  Change )

Connecting to %s
