Sharing Resources among Projects with MS Project 2010 – Part 2

Hi,

in my previous post I have explained hot to create and use the Resource pool.  Suppose that you want to open your project file which uses a Resource pool in MS PROJECT 2010. You will get:

My strong advice is: always open the Resource pool file!

Now, both files are opened. The “Project” file:

and the Resource pool:

Notice that Resource pool is opened in Read-Only mode, so you can not change anything in this file.

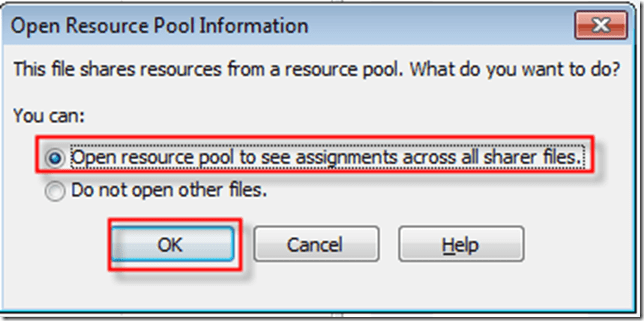

What will happened if I tried to open the Resource Pool before the “Project” (or Sharer) file? I would get:

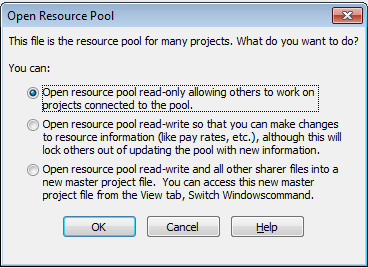

I have three options:

  • In most cases you will use the first option. You will “lock” the Resource pool. You can update the assignment information when you work in read-only mode
  • Use this options when you have to change basic resource information (like pay rate, setup fee, etc.)
  • The third option should be used when you want open the Resource pool with (in read-only mode), and all other sharer files

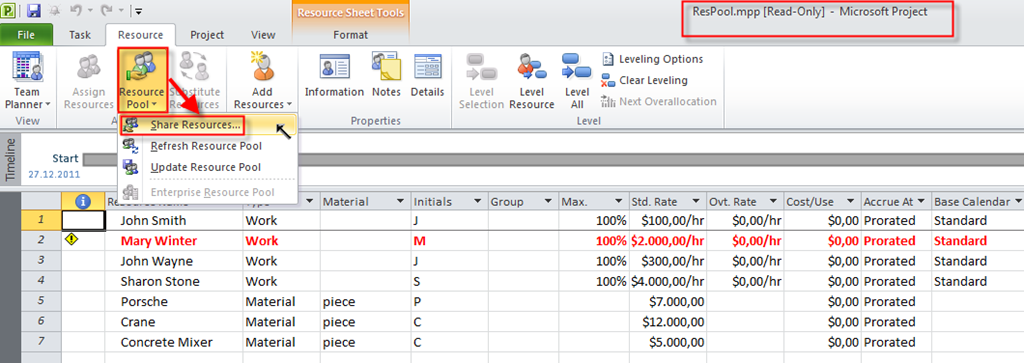

As you already know from my previous post, Mary winter is over allocated. I want to see where, and I want to see that in the Resource pool. So, I will open, the Resource pool in Read-only mode and I will choose the Resource usage view:

You can see that I have two tasks with the same name. It is confusing. But I will ad the new column with the Project Name field:

and I will get:

It is much better now, isn’t it?

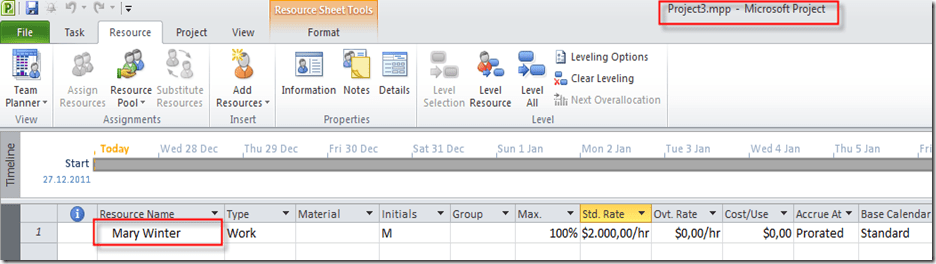

Now, suppose that I want to change pay rate for one of my resources. And I want to make this change visible to my sharer Projects.

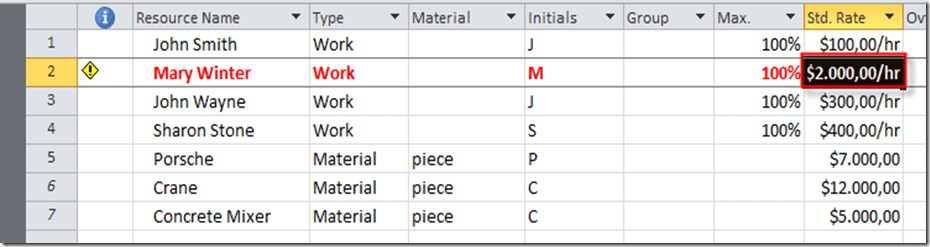

First way is to open Resource pool in read-write mode, and to change that pay rate:

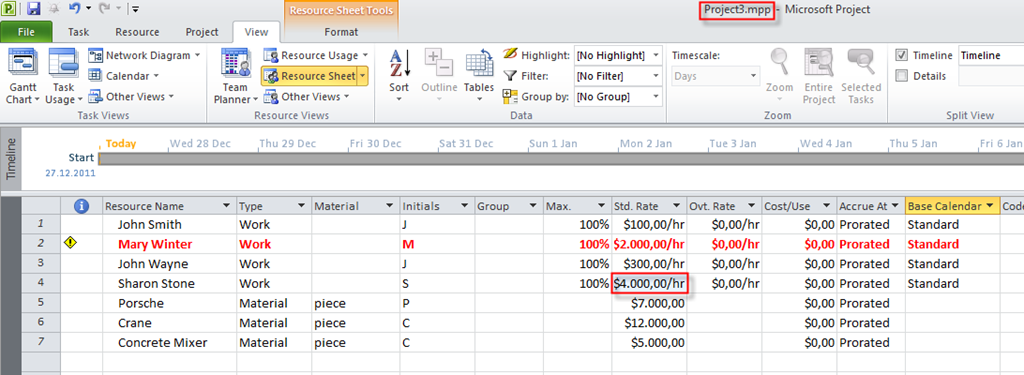

Now I will save the Resource pool, and I will open my “”Project” or Sharer file:

Another way is to open Resource pool as read-only, and make change in the Sharer file:

Now, I will try to save this “Project” file, and I will get:

If I choose OK, I will save those changes to the Sharer file, and it will save the Resource pool as well!

Or, I can use the Update Resource Pool option and I will get the same result:

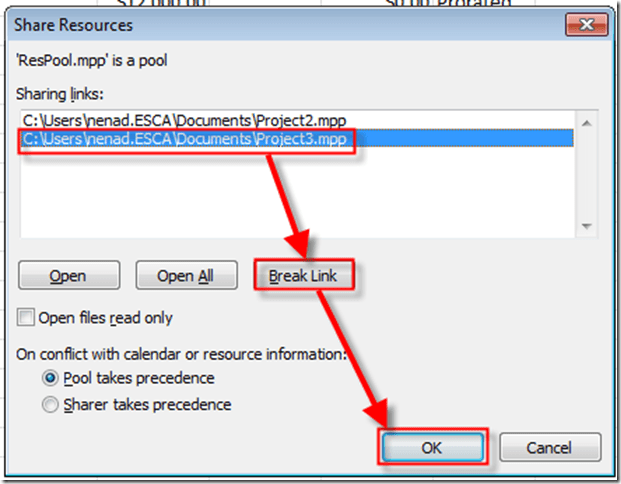

Now the last thing. What if I want do disconnect sharer file from the pool? I will open the Resource pool and in Resource pool I will choose:

and I will get:

If I open the Project file now, I will see only local Resources, or assigned Resources from the pool, but as a Local resources:

As you can see, Mary is no longer over allocated!
