Hi,
my Blog reader has a “problem”:
“Nenad, thank you for replay! Ok, my be I wasn’t clear with my question… Let me explain my self one more time. Perhaps I’m working on some project, it has 28 task with dependences. After planning everything, leveling resources etc. I see my project start 01.01.2015 and will finish 19.07.2016 instead of 30 06.2016 as planed. I’m OK with new finish date. Now I have to check “what if” scenarios. One of them says that I have to check what happen if after 50 work days from the beginning of the project from task 1 till task 12 everything went ok and those task are completed 100% and task 13 which is also should be completed 100% until end of the day 50, but is completed only for 40%. I.e. it will be delayed. Task 13 planned duration is 15 days, so for now it should take a while until it will 100% finish. Task 14 depend on this task (finish to start) so it also will be delayed and so on… Now, the question is: in light of this change whole project end date (19.07.2016) also will be delayed? And how much % of task 13 can be done within his desired time (15 days) so it will not affect original finish date (19.07.2016). My question is: how I can check this scenario in MS Project 2013? Like I said I’ve added “complete” column, inserted % completion according to this scenario, but finish date remain the same (all project task configured auto schedule, so any changes in project should be recalculated immediately). Thank you in advance, Igor.”
I’ll show how to solve this in MS PROJECT 2013.
First I will explain the Problem! Let us say that we have Project Like this one:

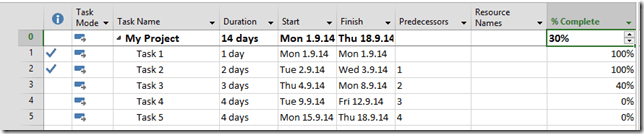

Now suppose that Task 1, and Task 2, are 100% finished (on time), and Task 3 is only 40% finished on time:

As you can see, Task 3 is supposed to be finished (100%) at Monday, 8.9.2014, but it is not. And suppose that you know that your Project status date is 12.09.2014:

So what do we know so far. We know that today is 12.09.2014, and that we are late. So we have to move our incomplete Tasks to Monday, 15.09.2014:
and I will get:
As you can see, Task 3 has split, so the remaining part of this task is rescheduled to Monday, 15.09.2014, and al successors are delayed!
If this is “what if” situation, and you are not happy with Results, just hit undo or CTRL-Z.
Hope this helps,
Regards!
Nice Post i loved it as i’m Attending MS Project Online Classes at proventures India a best Project management Institute in Hyderabad this Post is Very Much Useful for me (http://proventuresindia.com/project-online)
Please remove me from your mailing list.
Thank you.
Regards, Ariel Africa | SRA International Inc.| Pentagon Force Protection Agency LSSN Project Office: 703.681.3077 | BB: 571.245.5195 E-Mail IDs: ariel.l.africa.ctr@mail.mil|ariel_africa@sra.com
I didn’t put you onthe list, so I can’t remove you from it. you should do it on your own!
Hello Nenad,
Could you send me your mail please, I have a question on msproject.
Thanks
nenadtrajk@gmail.com
