I have a question from my Blog reader: “Hi, How can I update Baseline with new Tasks if Project has Tasks with Actual data, e.g I don’t want to loose those actual data, nor I want to change Baseline for those Tasks”
It is very simple. I will show how to do that in MS PROJECT 2013.
First I am going to Create new Project with three Tasks, and I will link them:

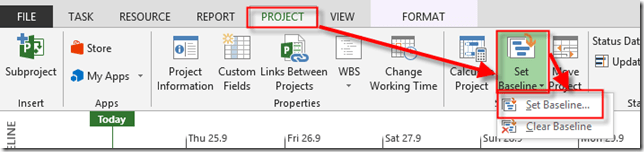

Now I am going to save the Baseline:
and then:
OK, let’s look at the Tracking Gantt View:

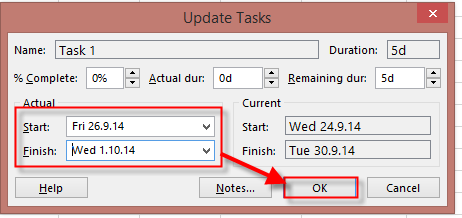

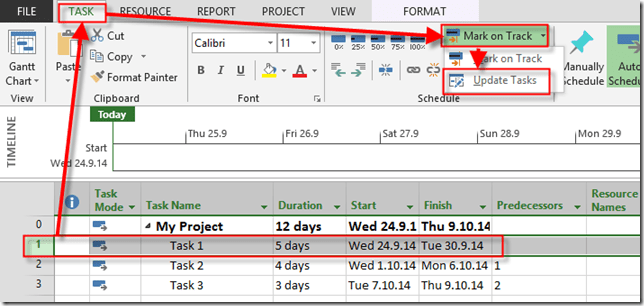

Now suppose that Task 1 was started at 26.02.2014, and finished at 01.10.2014:
and then:

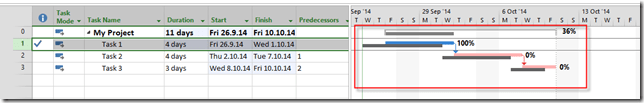

and I’ll get:
Now suppose that I have another two Tasks:

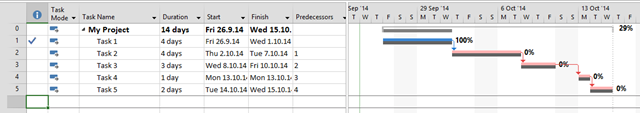

Those Task are not “Baselined” as you can se at the Picture above. Now, if I save the Baseline as I did for the whole Project I will get:
As you can see, Baseline is aligned with Actual data for Task1 to Task 3, and I do not want that.

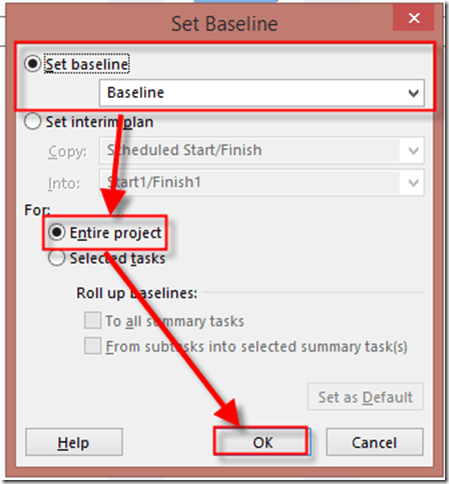

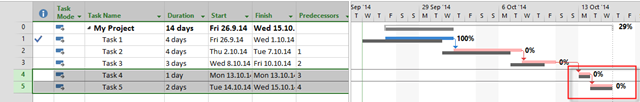

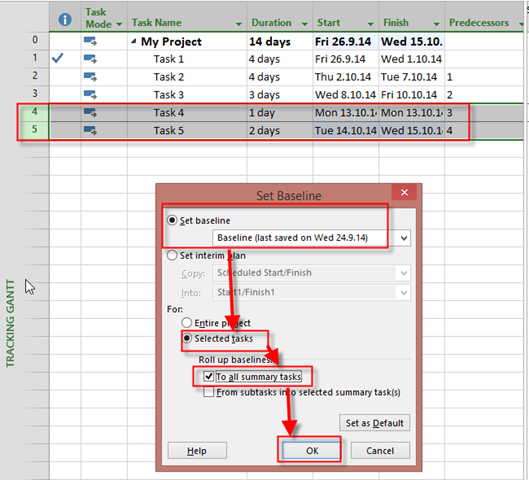

So I will Select only new Task and I will create Baseline like this:
and I will get:

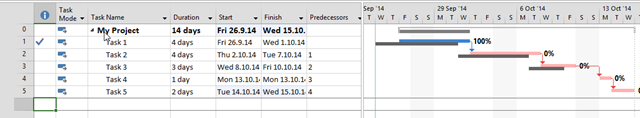

As you can see, Task 4, and Task 5, are now “Baselined”, and Task 1, Task 2, and Task 3, are as they was!
Hope this helps!
Regards!
Like this:
Like Loading...
Related
About Nenad Trajkovski
Location: Zagreb, Croatia
Occupation: Project Manager
Interests: Project Management and MS PROJECT
He was born in Zagreb, Croatia at 1963. After completing his college he started working on projects in different business areas (banking, manufacturing, automotive industry, distribution, oil companies, etc.) developing and implementing ERP systems into different companies. He has got a lot of experience working with people in different business processes and also possesses great knowledge in information technologies and financial services. Today he works as a business consultant, adn Project Manager in PERPETUUM MOBILE d.o.o. Zagreb. He is a regular lecturer for Project Management in MS Innovation Center in Varaždin, Logosoft Sarajevo in Bosnia and Herzegovina and SEAVUS GROUP in Skopje Macedonia. He was named the best lecturer of WINDAYS 2008 while his lecture was also voted as the best. In addition, he was in TOP 10 lecturers at the MS SINERGY 2009 and MS VISIA 2009, 2010. Shares first place as the best lecturer of KulenDays 2009 and 2010 and PMI Conference 2009 in Zagreb. He is also a regular lecturer in the MS Community. He is a Certified Accountant and a PMP (Project Manager Professional) and a PMI-RMP (Risk Manager Professional), MCP, MCT, and Microsoft Certified Technical Specialist - Microsoft Project 2010. From 01.01.2012 awarded with MVP (Microsoft Most Valuable Proffesional - Microsoft Project)!
Dear Nenad,
How we can have a new baseline (adding task or resource and delete task or resource) and how viewing that new baseline on the gantt chart.
Read my Post from 07/21/2017. Everything is explained there. Thanks for asking
Dear Nenad,
How we can create a new baseline (after the baseline one) with adding task, resource or delete task and resouce and show that new baseline on the gantt chart.
Thanks in advance
Hello Nenad
again, a great article. one thing to take care of is the baseline information at resource level while assignment are on tasks. currently it seems that MS Project is not recalculating baseline resource hours/costs while baselining additional tasks.
maybe an idea for new article
Hello!
I did not understand! If you make some new Tasks, and then assign Resources to them, and put new Baseline for new Tasks, in a Cost table I get Baseline Costs. Or you ment something else?
Hi,
yes I meant that. if you have an already set baseline on some resources, the nuber is great, if you re-baseline additional tasks with the same resource, the baseline sum is no more accurate (Resource Usage view or resource table) have a try and you will see that MS Project is not summarizing well the baseline work/costs of the resource
I can reproduce that. In resouce usage View I have everything fine. In cost table as well! Can you give ma an example with mpp fiel to nenadtrajk@gmail.com
Nenad,
Please remove me from your mailing list.
Thank you.
Regards, Ariel Africa | SRA International Inc.| Pentagon Force Protection Agency LSSN Project Office: 703.681.3077 | BB: 571.245.5195 E-Mail IDs: ariel.l.africa.ctr@mail.mil|ariel_africa@sra.com
I did not add you to my list so I can’t remove you from it!
