Fixed duration Tasks and over allocation resolution in MS PROJECT 2016

Hi,

I have interesting question form one of my Blog Readers:

“I have below query in Fixed Duration Task.
Step1: created a task “paint the wall” with duration as 10 days (work starts by a Monday). Task is fixed duration
Step2: created a resource “A” (100%) – (8hrs/day)
Step3: assigned this resource in this task.
Step4: In task usage, changed the timelines middle tier->months, bottom tier->weeks

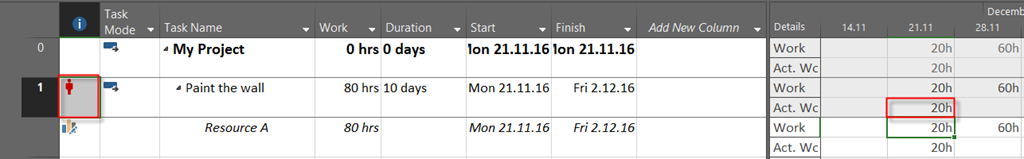

Step5: in task usage, entered actual work = 20hr in that task. It gave an warning message. Skipped.
Now it shows 1st week, Resource works 20hrs, and over allocated in next week with 60hrs.
Now, my query is, if i add another resource “B”, i expect that this extra 20hrs in 2nd week should be assigned to this resource “B”.`
I would like the MS project to calculate by itself and assign 40hrs for resource A and 20hrs to resource B.
Please guide on how to achieve this?”

I will show you how to do that in MS PROJECT 2016! I will follow steps from the question.

Step1: created a task “paint the wall” with duration as 10 days (work starts by a Monday). Task is fixed duration


As you can see, I make this Task Effort Driven, because I will have to split work between Resources.

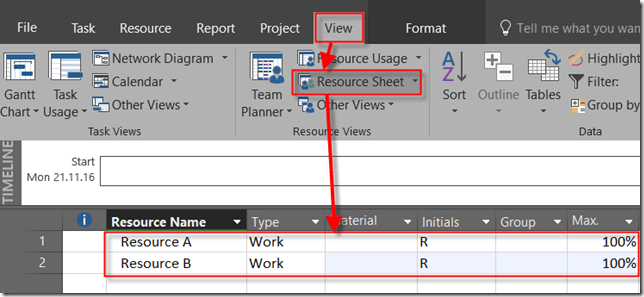

Step2: created a resource “A” (100%) – (8hrs/day)


As you can see, I have another resource, Resource B, because I will need it for latter steps.

Step3: assigned this resource in this task.

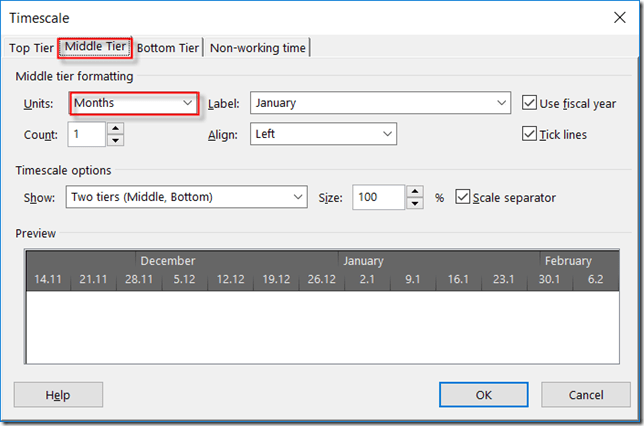

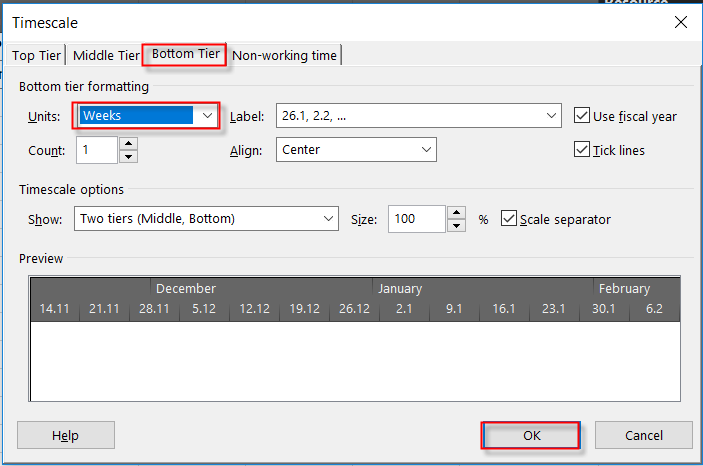

Step4: In task usage, changed the timelines middle tier->months, bottom tier->weeks


and:


Step5: in task usage, entered actual work = 20hr in that task. It gave an warning message. Skipped

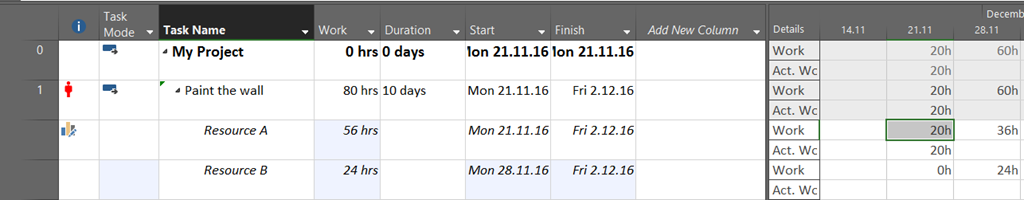

Now it shows 1st week, Resource works 20hrs, and over allocated in next week with 60hrs.
Now, my query is, if i add another resource “B”, i expect that this extra 20hrs in 2nd week should be assigned to this resource “B”.`
I would like the MS project to calculate by itself and assign 40hrs for resource A and 20hrs to resource B

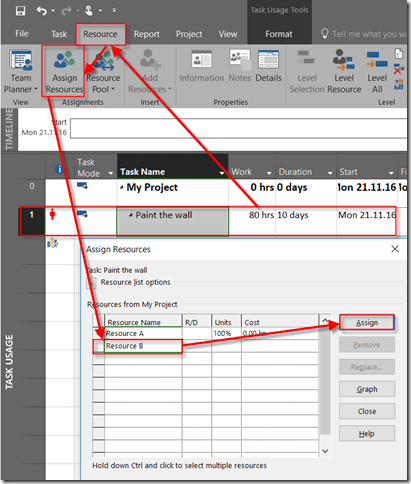

I will assign Resource B on the Task:

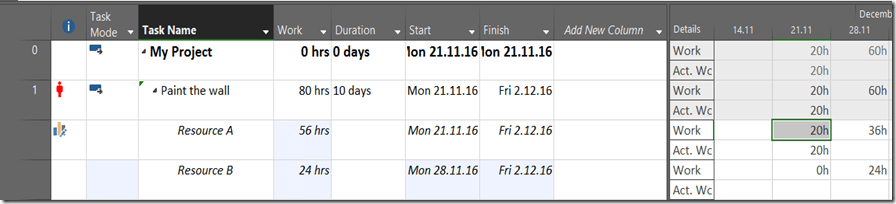

I will get:

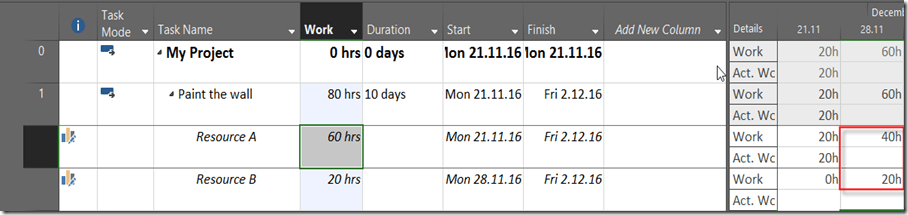

As you can see, remaining work among those Resources is divided in 60/40 (36 hours for Resource A, and 24 hours for Resource B). So, Resource A is not over allocated any more, but it is not what we want. We want that Resource A should work 40 hour, and Resource B 20 hours for Task. So I will have to put those hours manually:

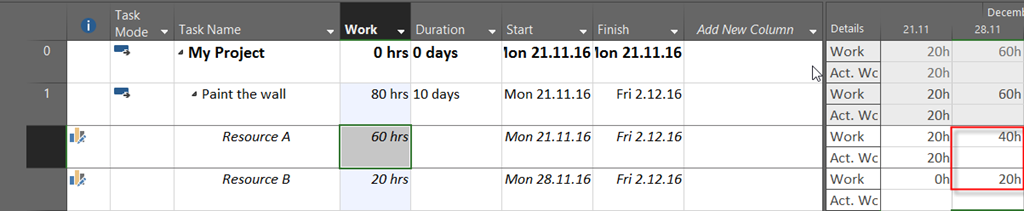

and I’ve got what I wanted.

So, no, this is not going to happens automatically,  you should do it manually.

Hope this helps.

Regards!
