Resource pool and Subprojects in MS PROJECT 2010

Hi,

I will show how can you use Resource Pool with Subprojects in MS PROJECT 2010.

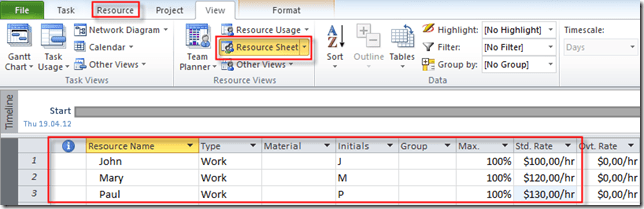

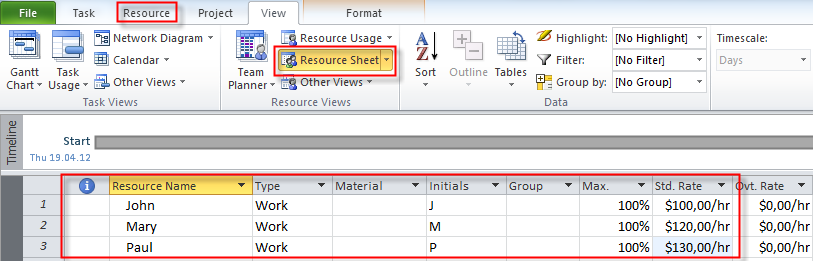

First I am going to make a resource pool:

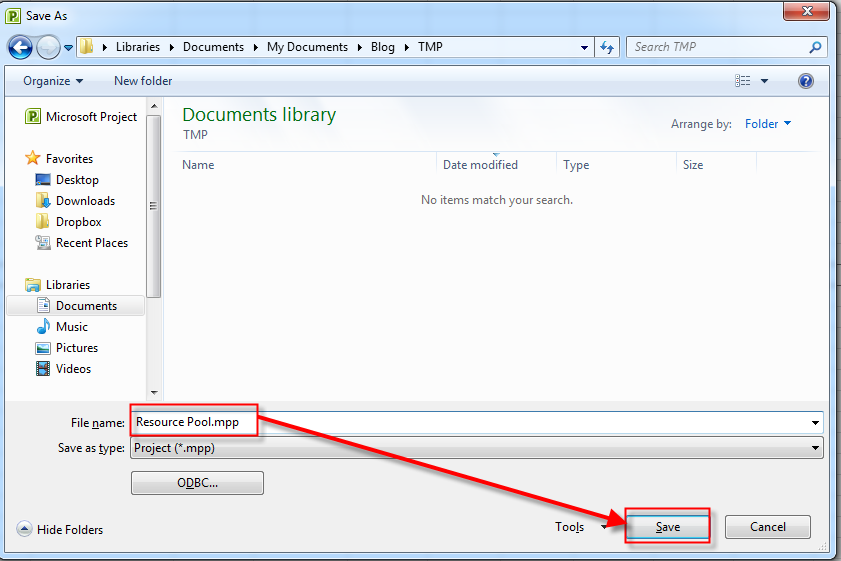

I will save this Resource pool:

and:

I am going to create one Master Project and two Subprojects.

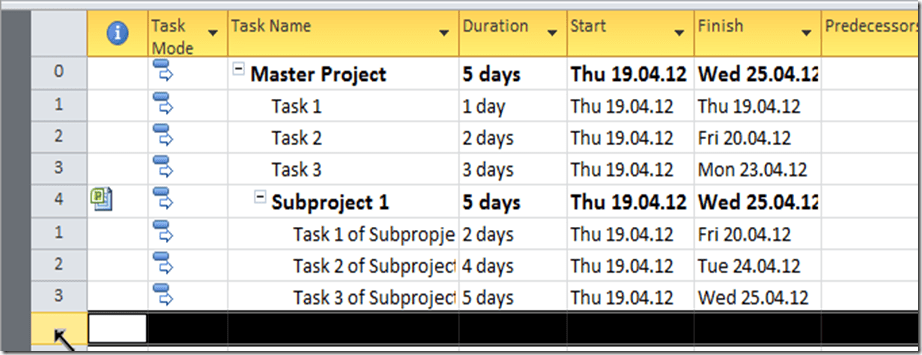

Master Project looks like this:

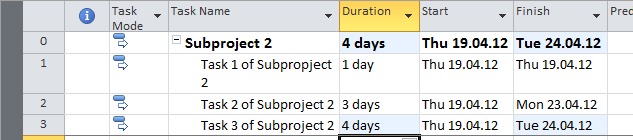

Subprojects are:

and:

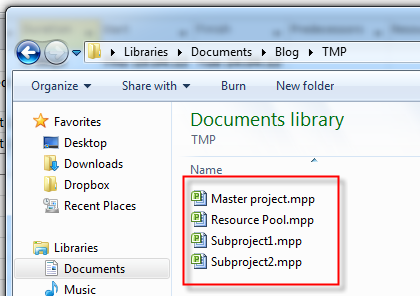

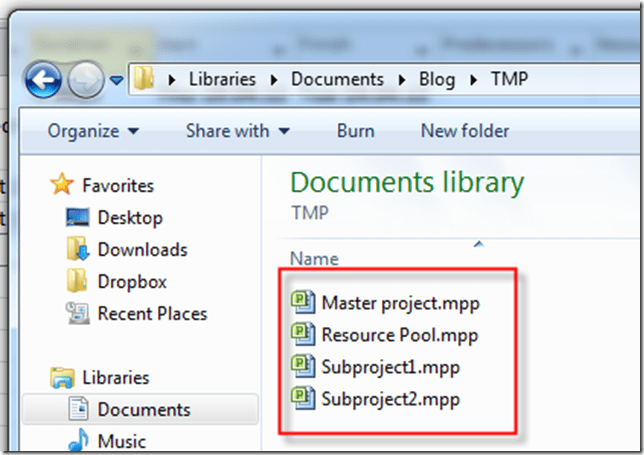

I will save all my Projects and I have:

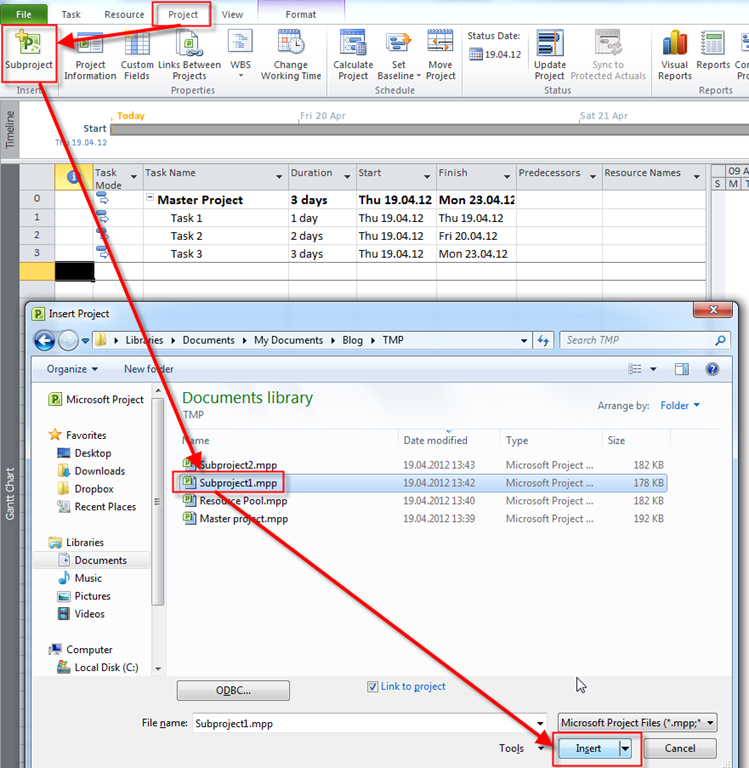

I will open them all and I will add subprojects to my Master Project:

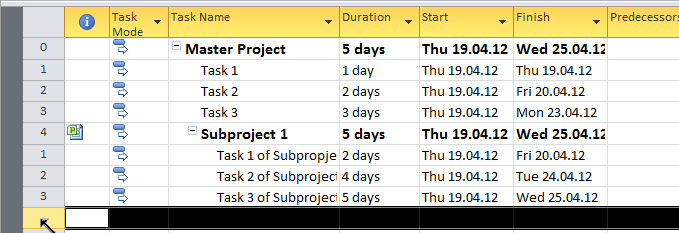

and I will get:

After I add the Second Project as a Subproject I will have:

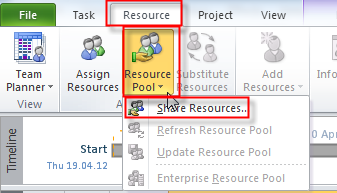

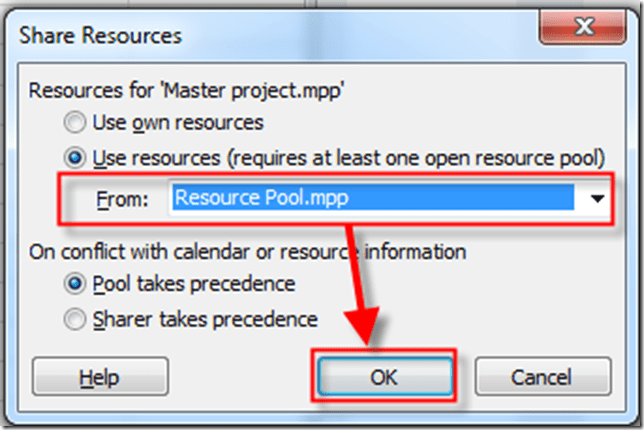

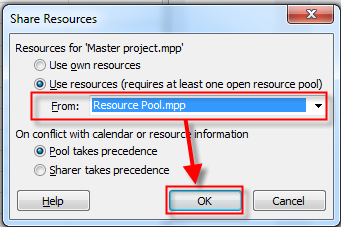

Now I will assign Resource Pool:

and then:

Now I will assign Resource to the Tasks of Master Project:

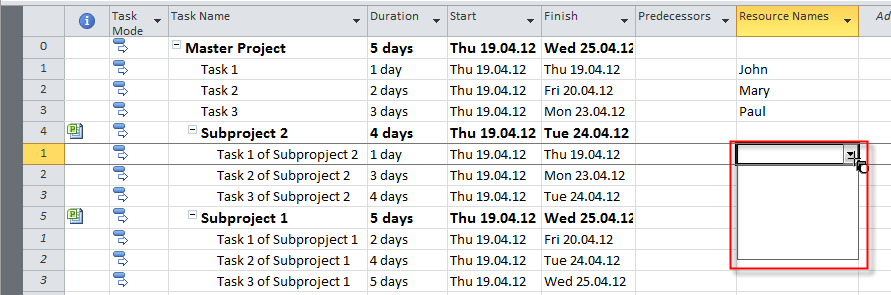

Now I will try to assign Resource to the Subproject Tasks:

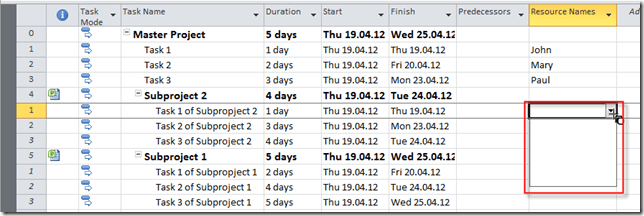

As you can see there are no Resources for that Tasks. If you want to share resource from the same Resource pool in the Subproject Tasks you should assign the Same Resource pool in the Project (subproject):

You should repeat that process for every Subproject.

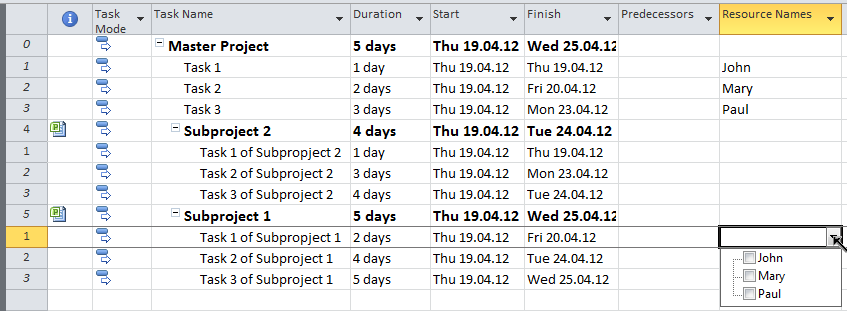

Now if I want to assign Resource to my Subproject Tasks, I can:

and I will get:

Notice that Resources are Over allocated!

It was easy, isn’t it?
