Teams in MS PROJECT SERVER 2010

Hi,

In this Post, I will show you how to create teams in MS PROJECT SERVER 2010. If you red my previous Posts, you have noticed that, for example, RSB lookup field it is built in RBS lookup table in MS PROJECT 2010. But, for the built in Team Name custom field, there is no built in Team Name or any other lookup table!

Where is the Team Name custom field?

Here:

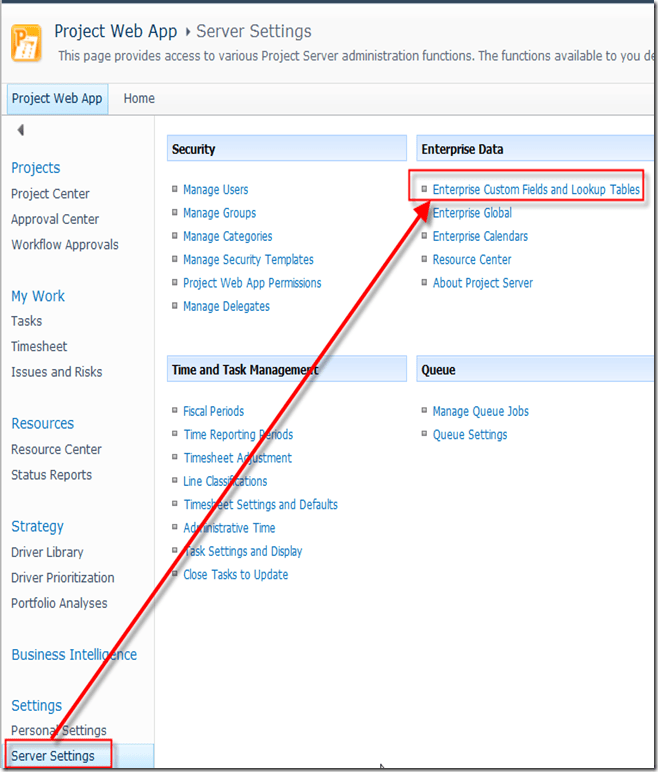

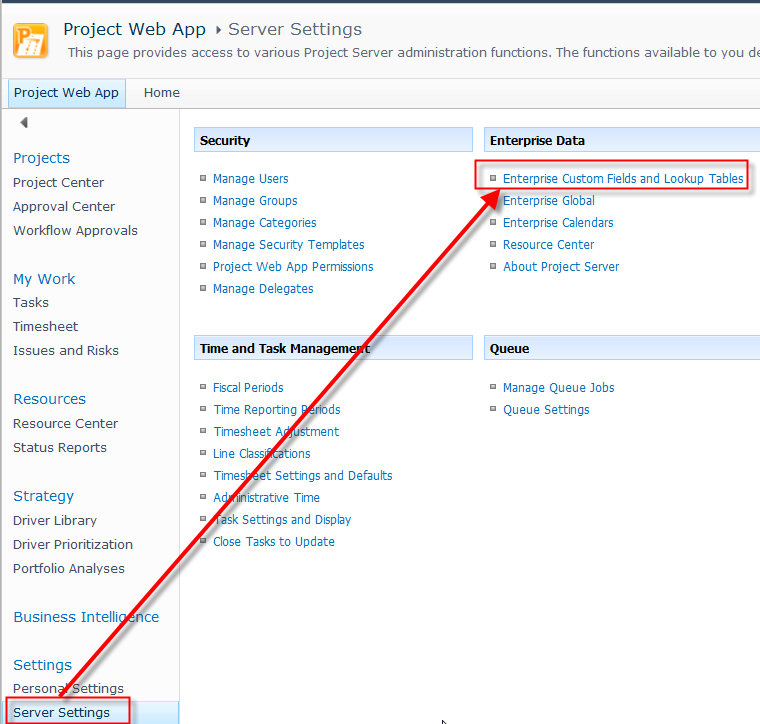

and then:

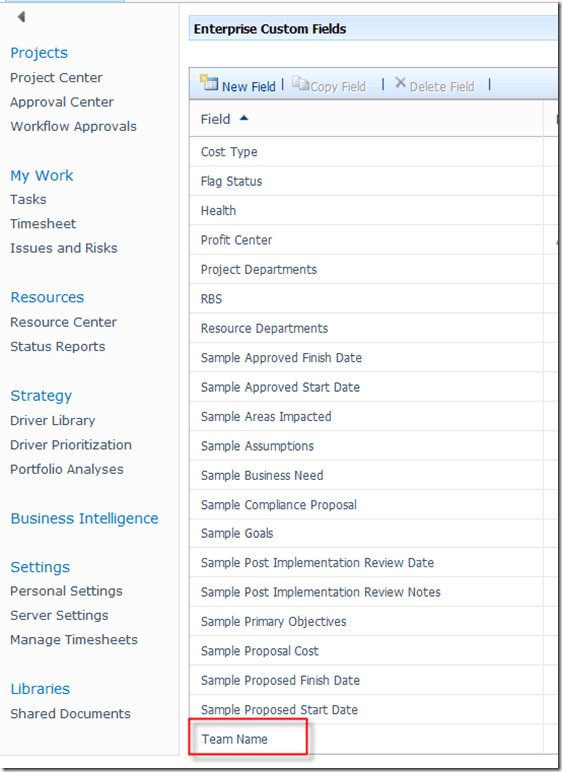

Here it is:

Notice, there is no such a thing like a Team Name lookup table.

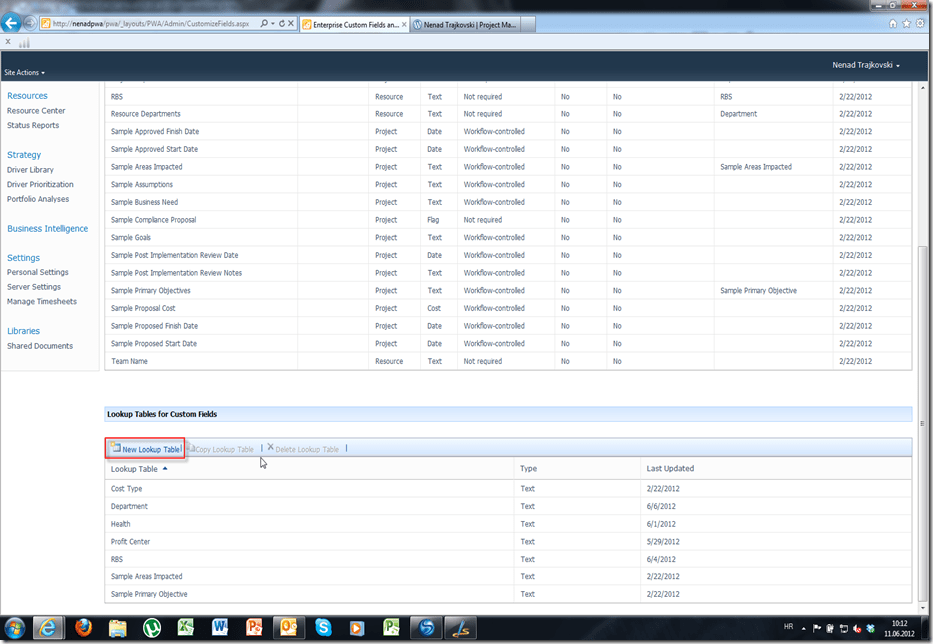

When I click on Team Name, lookup table:

There is no Lookup Table for this field.

I will now create Teams lookup table with simple values:

  • Sap Developers
  • Sap Consultants
  • NAV Developers
  • NAV Consultants
  • MS Project Developers
  • MS Project Consultants

and then:

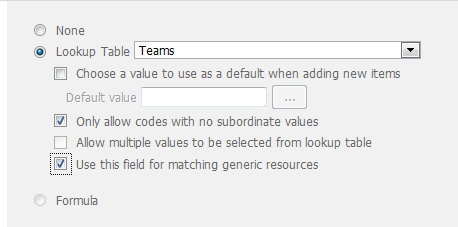

Now I have this custom lookup table, and I have to assign it to the Team Name lookup table:

I will get:

and:

I want to be able to use this field for generic resources, as well!

Finally, I am going to assign some Team values to my resources:

and:

and finally:

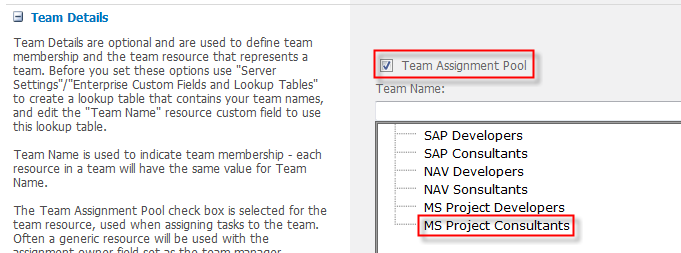

What is Team Assignment Pool? By selecting the Team Assignment Pool check box, you enable other users on the MS Project Consultants team to see any tasks assigned to the Development resource and to accept the assignments in PWA!
