Multiple Critical Paths in MS PROJECT 2013

Hi,

we all know what Critical Path means. It is path in which, if any Activity is late, the whole Project is late.

Let me show you Critical Path in MS PROJECT 2013.

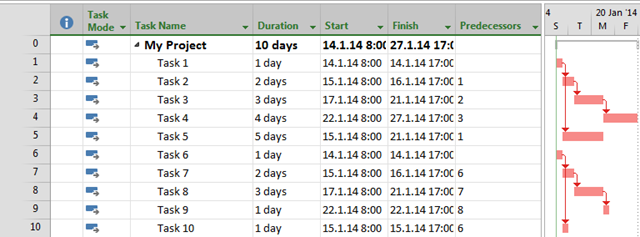

First I’ll create new Project with some Tasks and dependencies between them:

I want to see Critical Path, so I will do next:

and I’ll get:

and I’ll get:

As you can see, Critical Tasks (or Activities, to be more precise) are: Task 1, Task 2, Task 3, and Task 4.

Now Imagine next situation:

As you can see, Task 6 – Task 10, they are not at the Critical Path. But what if I want to see Tasks which are at the, so called, “Critical Path” in this particular Branch? I will do next:

then:

and then:

Finally I’ll get:

Now I have two Critical paths!

I seem a confuse a little bit because with this option, if it is turned on, the late finished date for tasks with no constraints or no successors are set to their early finished date, so they are Critical!

My suggestion is: Do not use this option! I’m tracking only one Critical Path, the real one!

Regards.
