Hi,
I have a question form my Blog Reader:
“Hi Nenad
I have the issue. My tasks are all set to automatically scheduled. I update actuals weekly and once completed I update the project and select ‘reschedule uncompleted work to start after xxxxx’ . MS project then automatically sets a ‘start no earlier’ constraint with date date(xxxxx) on some of my tasks. I then manually need to remove them the next time i want to update the schedule. Any ideas what is driving this behavior would be appreciated.
Thanks
Carol”
I will explain this “issue” in MS PROJECT 2013!
First I will crate simple Project:

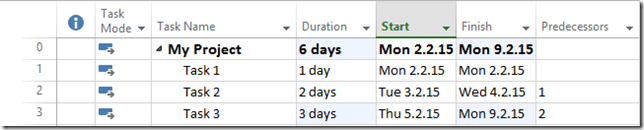

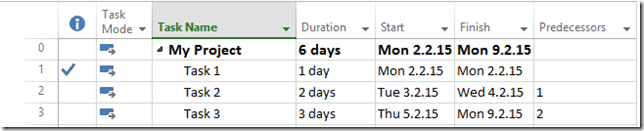

As you can see My Project is supposed to start at Feb, 2th and to finish at Feb, 9th. Suppose that I finished Task 1 on time, so I will mark this Task as 100% completed:

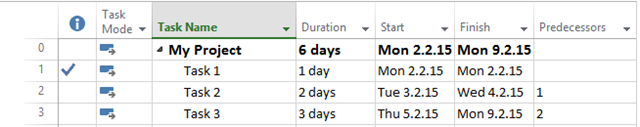

and I’ll get:

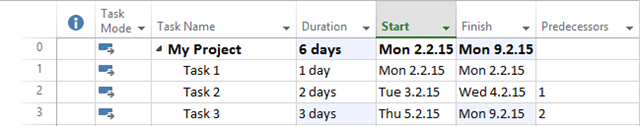

Now suppose, that today is Friday, 6th, and that I didn’t start with work on Task 2 nor Task 3. So I want to reschedule uncompleted work after this date.

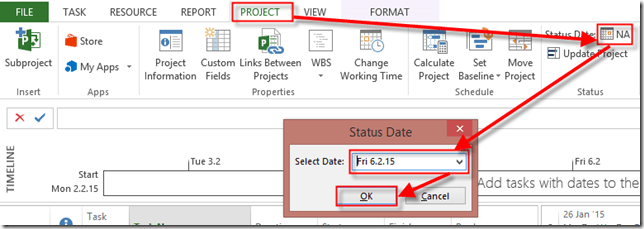

I will first set the Status Date to Friday, 6th:

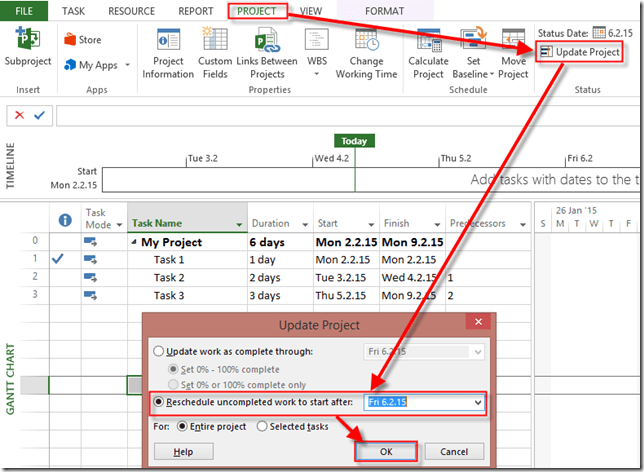

and I will reschedule uncompleted Tasks after this date:

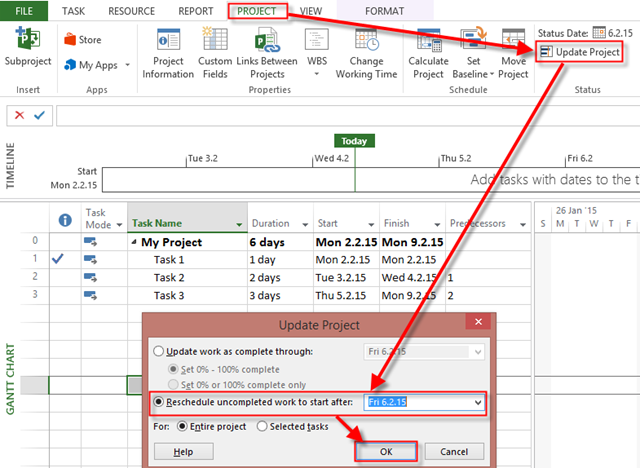

I will get:
You can see the Calendar Icon in Information Column. For Task 2, and Task 3 it says:
WHY? Is this a Bug. No, it’s not. It is logical. Because TODAY is Friday 6th, Task 2 and Task 3 can’t start before that date. So those Task can start at that date and later, but not before, because that will be back to the Past. How can you start to work on soma Tasks in the Past? You can not. So, my suggestion is: Update all your Tasks with actuals, for example, each Friday, and then Reschedule uncompleted work after that Friday and you will get the Real situation in your Project. And yes, some Tasks will have SNET constraint!
Hope this helps.
Best Regards,
Nenad
Hi
Thanks for the discussion. I have a supplementary question.
1. I updated all the project (tasks 2 and 3) to start after Friday 6.2.15.
2. This put task2 at start date 9.2.15 and task3 on 11.2.15.
3. Task2 took very long to complete and it will finish on 20.2.15.
4. There are no dependencies between task2 and task3 which is different then the example above.
5. Today is -> 15.2.15 <-
6. I want to reschedule task3 so I "Reschedule uncompleted work to start after 20.2.15.
I'm working on Project 2010 and what happens is that task3 is not changed. I think that it is not changed because in previous time I rescheduled to start after 6.2.15 this set the task to "don't start before 6.2.15" and now becuase it is not "start as soon as possible" the reschedule does not affect it. Now I Level resources and hell breaks loose.
Do you know any workaround for this?
Thanks and have a nice day
Moshik
It works fine for me. you shuold send me an mpp file
Hi Nenad
Thanks very much for this explanation.
So if I had a task of 5 days duration and on the 5th and final day I updated that task to 80%, does project not automatically assign the remaining uncompleted 20% to the following day? Is that something you manually have to monitor and change?
Thank you
Alley
Hi Nenad,
I’m facing several problems in setting up a master project as well as with entering real work values for resources and levelling. I was wondering though if you can handle such a project for me and what the cost of that might be (of course once you have all relevant details).
I would greatly appreciate your feedback since I’m desperate 😦 to be honest…
Regards / Efthimios Spiridopoulos
my mail is nenadtrajk@gmail.com
