How to make week shifts in MS PROJECT 2016?

Hi,

Today, I will explain next Scenario in MS PROJECT 2016: Suppose that you have a project team who will work 5 days a week (Monday to Friday), but every third week the whole team will be off. This is common situation with a Teams who are working on Project, but also at Operations in their Company.

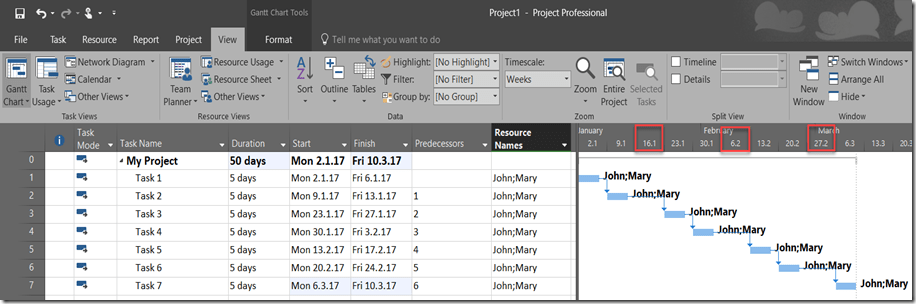

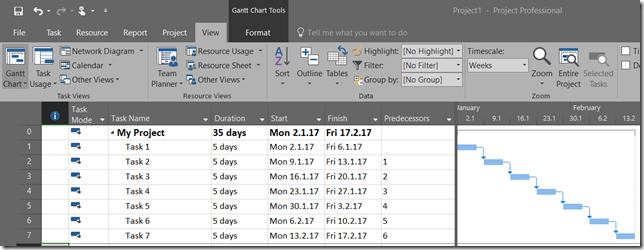

First I will create a simple Project with 7 Tasks, and  each of them will have 5 days Duration:

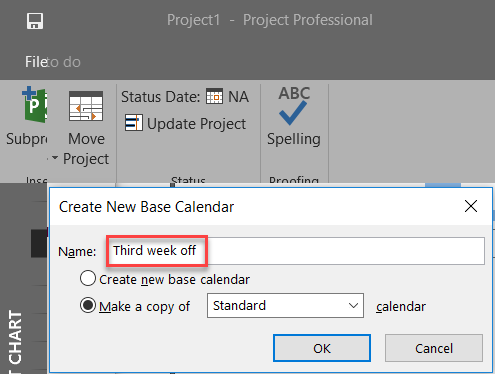

Now, I will crate new Calendar, and I will call it Third week off, and in it I will make every third week as a non working, which is a point of this Post:

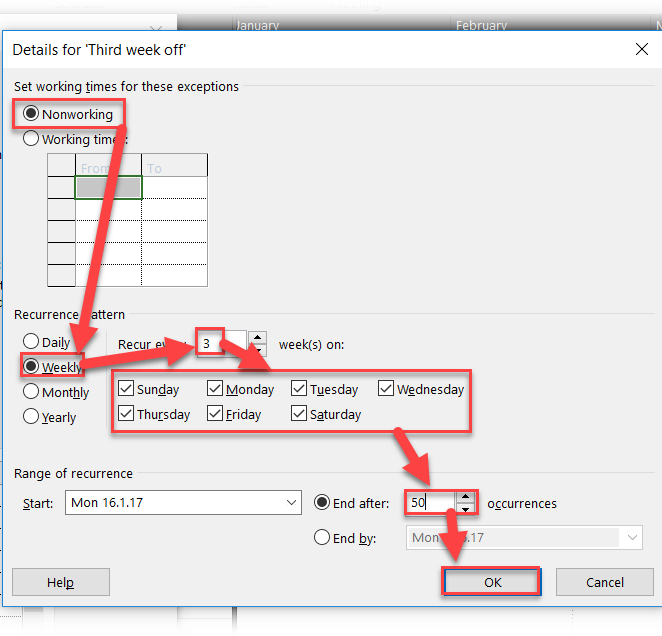

and:

and then:

and:

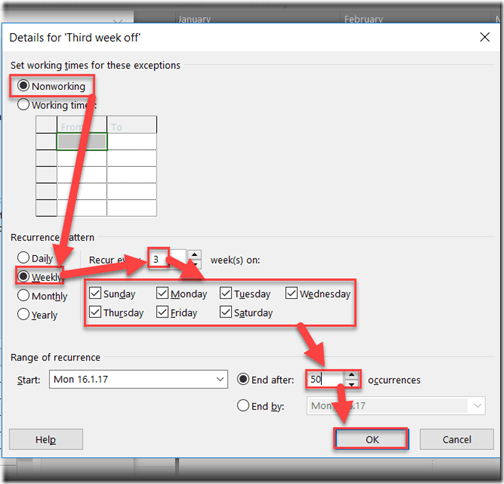

SNAGHTML110e4e6

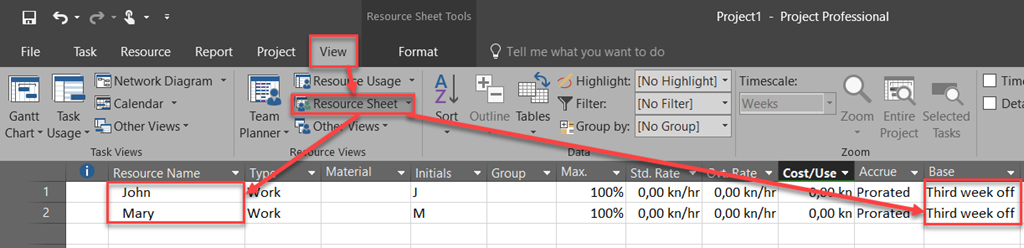

Now I am going to create two Resources, John and Mary, and I will assign this calendar to them:

Finally, I will assign those Resources to my Tasks, and I will get:

As you can see, every third week is non working week.

Easy, isn’t it.

My dear Blog Readers, this is my last post for this Year. I hope that you will read my post next year as well, and I wish you all the best for the New Year – 2017.

Regards!
