Baseline for Subprojects in MS PROJECT 2013

Hi,

Today I’m going to explain how to set and see Baseline for Subprojects in MS PROJECT 2013, and how to see those Baselines in Master Project!

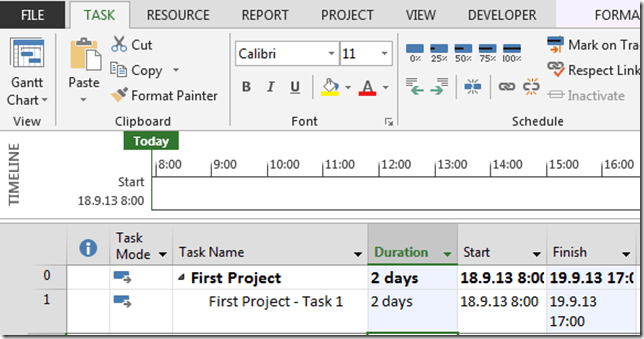

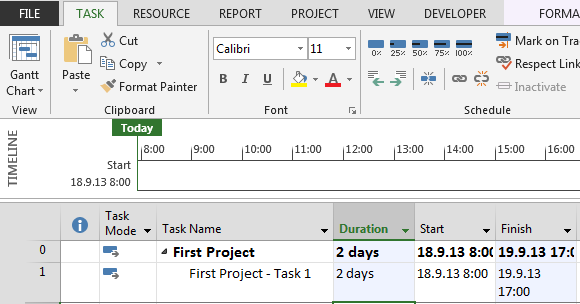

First I’m going to create two Brand new Projects with one Task:

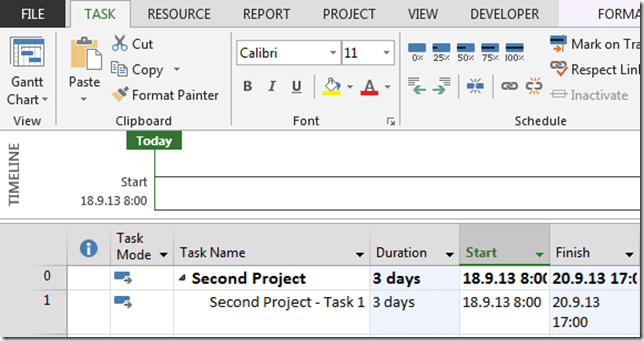

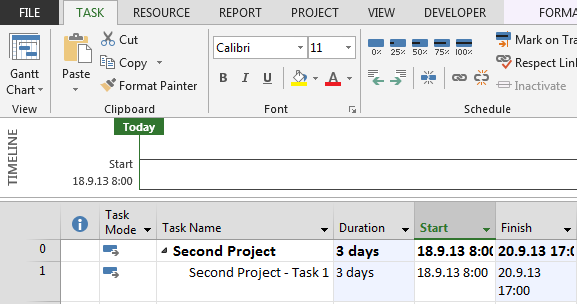

and

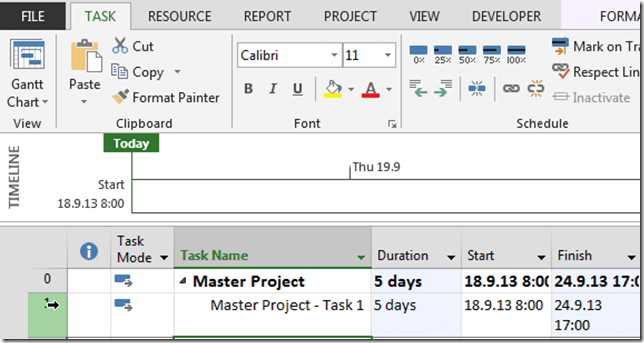

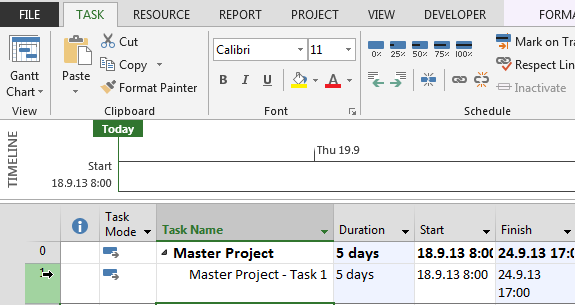

After saving this two Projects I’m going to create Master Project:

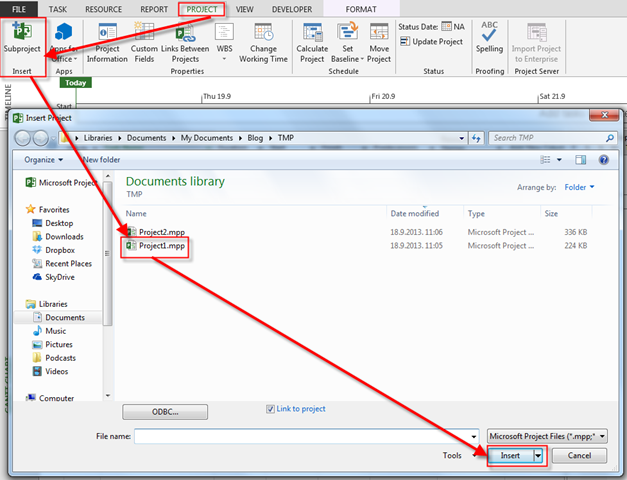

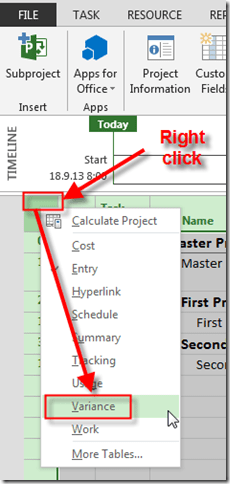

and I’m going to import Subprojects:

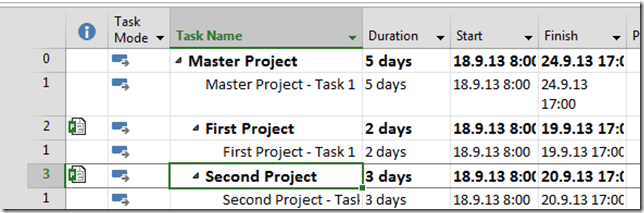

After importing the Second Project I’ll get:

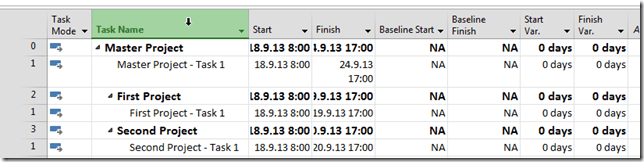

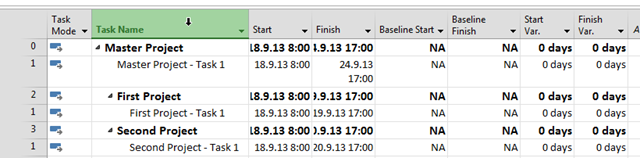

I’ll switch Table to Variance:

and I’’ get:

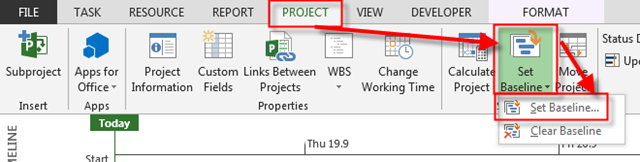

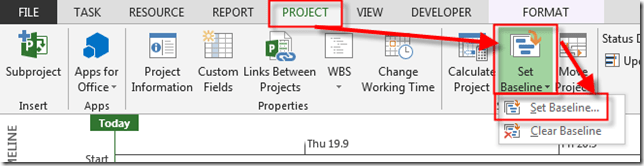

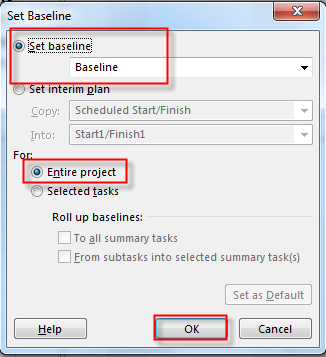

Now I will save the Baseline in Master Project:

and:

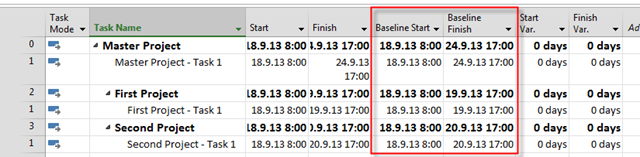

Finally I’ll get:

As you can see, there is a Baseline for Tasks in Master Project, and for summary Tasks in Subprojects, but there is no Baseline for Tasks in Subprojects. To get those I’ll save the baseline for each Subproject separately:

The Procedure of saving Baseline in Subprojects is same as ion Master Project so I’ll not waste time to show you a picture. After saving the Baseline in each Subprojects when I look at the Master Project I will see this:

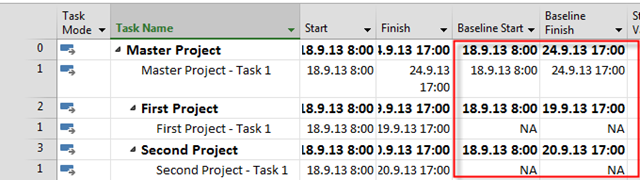

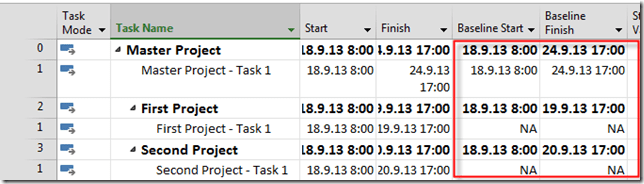

Voila! I can see Baselines for Task in Subprojects!

Piece of cake!

Regards!
