Task Types and how they affect the Schedule–Part 1



Hi,

In next few posts I will explain task types and how do they reflect on Schedule in MS PROJECT 2010.

Basically, there art three Task Types:

  1. Fixed Units (Default)
  2. Fixed Work
  3. Fixed Units

What are those?

  1. Units or Assignment units. It reflects Resource availability on the Task. 100% means full time, 50% means half time etc.
  2. Work.  This is amount of time (hours, days, weeks…) that resource will work on the Task
  3. Duration. This is the time span from the start to the finish date of the Task.

Above this three Task type, all of them can be Effort or Non effort driven! Where is the difference? Suppose that you have two Tasks on your Project.

  • Task 1 = Reading the book. If one person is assigned on that Task and it needs 2 days (for example), and you assign another resource to that Task, it will still take 2 days for each person to read that book. You can not reduce the Task duration on that Task with adding more resources on it. This is Non effort driven Task.
  • Task 2 = Painting the wall. If one person is assigned on that Task and it needs 2 days(for example), and you assign another resource to that Task, it will take shorter duration for completing that task . You reduce the Task duration on that Task with adding more resources on it. This is Effort driven Task.

Now, you MUST REMEMBER THE MAGIC FORMULA

DURATION * UNITS = WORK

In MS PROJECT 2010 when you add new Task to the Project, and/or assign new Resource to it, the default type is: Non effort driven, fixed Units Task!

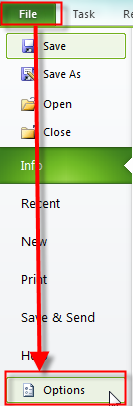

You can change this default settings for your Project:


and then:


I will leave everything “AS IS”!

Now I will describe what will happens if I change something in the Magic Formula:

TASK TYPE If you change: ASSIGNMENT UNITS If you change: WORK If you change: DURATION
FIXED UNITS Changed: DURATION
Unchanged: WORK
Changed: DURATION
Unchanged: UNITS
Changed: WORK
Unchanged: UNITS
FIXED WORK Changed: DURATION
Unchanged: WORK
Changed: DURATION
Unchanged: UNITS
Changed: DURATION
FIXED DURATION Changed: WORK
Unchanged:
DURATION
Changed: WORK
Unchanged:
DURATION
Changed: WORK

FIXED WORK is always EFFORT DRIVEN!

Where does Effort or Non effort driven task comes “in action”? When you assign or remove  additional resource to the Task:

TASK TYPE ADD OR REMOVE RESOURCES (UNITS)
FIXED UNITS – non effort driven Changed: WORK
Unchanged:
DURATION, and UNITS
FIXED UNITS – effort driven Changed: WORK and DURATION
Unchanged:
UNITS
FIXED WORK – effort driven Changed: DURATION
Unchanged:
WORK, and UNITS
FIXED DURATION – non effort driven Unchanged:
DURATION, WORK, and UNITS
FIXED DURATION – effort driven Changed: WORK
Unchanged:
DURATION, and UNITS

When Should a Task  HAVE Fixed Units? This is default type and protect your resource to work more than he or she should. If resource is assigned to the Task 50%, whatever you change this resource will work only 50% of his capacity on that Task!

When Should a Task HAVE Fixed Work? When you assign a resource to the Task, , the task’s duration is translated to the work. If you want (know) to remain those hours constant when you change duration or work for the Task, choose this Task type!

When Should a Task HAVE Fixed Duration? Very simple! If you want that work on the task should be conducted with fixed duration, you will choose this task type, and it will be no change on that duration when you change units or work on it.

From my next post on, I will show you those tasks types in the real examples!
