Day rates per resources in Microsoft Project 2016

Hi, I have the question from my Blog reader: “After trying for weeks, I’m trawling the net for Microsoft Project, to find out how to add day rates per resource to the schedule. I can do this in SAP, but not every firm has it. These cost are variable and should change automatically if the duration increases, – lets say the dates get pushed out, and work takes place on a Saturday I should see a cost increase with out having to go through each activity one by one……
Have you work with this ?”

I will show you the solution using Microsoft Project 2016. first I’m going to create very simple Project, with one Task:

For this example I’m going to modify Standard Calendar in a way that every Saturday and Sunday will be working day:

Now I will create two Resources, John with $100 Standard rate, and Mary with $200 Standard rate:

Finally, I will assign John and Mary to the Task:

Let’s see the Cost Table:

and:

As you can see Total Cost is $12.000,00. John will work 5 days * 8 hours per day * $100 per hour = 40 hours * $100 = $4.000, and Mary will work 5 days * 8 hours per day * $200 per hour = 40 hours * $200 = $8.000. So John + Mary = $4.000 + $8.000 = $12.000

Now let’s say that John will be paid $150 per weekend and Mary will be paid $300. To do that I must do next:

and:

Now I will put 10 days in Duration for the Task:

SNAGHTML98abaaf

and again, let’s see the Cost Table:

As you can see Total Cost is $26.400,00. John will work 5 days * 8 hours per day * $100 per hour = 40 hours * $100 = $4.000, then on Saturday and Sunday he will work 2 days * 8 hours per day *  $150 = 16 hours * $150 = $2.400, and again from Monday to Wednesday he will work 3 days * 8 hours per day * $100 per hour = 24 hours * $100 = $2.400. So John will have $4.000 + $2.400 + $2.400 = $8.800
Mary will work 5 days * 8 hours per day * $200 per hour = 40 hours * $200 = $8.000, then on Saturday and Sunday she will work 2 days * 8 hours per day *  $300 = 16 hours * $300 = $4.800, and again from Monday to Wednesday she will work 3 days * 8 hours per day * $200 per hour = 24 hours * $200 = $4.800. So John will have $8.000 + $4.800 + $4.800 = $17.600. So John + Mary = $8.800 + $17.600 = $26.400

So this is solution! BUT! If you have those double rates for John and Mary for every weekend than you should put it manually, like I did for every weekend. there is no way to put so called “weekend” rates or something like that in MS Project. It is only date based.

Regards!

Posted in MICROSOFT PROJECT, MS PROJECT 2016, PMI, PRoject Management | Tagged , | Leave a comment

Actual duration for manually entered actual work in MS PROJECT 2016

Hi,

I have a question from my Blog reader, and I’m going to explain the problem step by step. Of course I will use MS PROJECT 2016! My blog reader’s problem is written with Italic.

1. Let’s create a 5 days task with 2 resources. John is  assigned at 100% and Mary at 50%.

I will now show Task Usage View with some additional fields:

  1. When the actual work  is manually entered in Actual Work fields on either the table portion of the appropriate view or  in the Timephased view,  Project calculates Actual Duration  and  %Complete using straightforward approach with scheduling formula on the condition that the work that entered for each time period in the Timephased view is exactly equals to each resource assignment units.

    So in the example below Project calculates Actual Duration = Actual Work / Total Units = 32hrs/150% * 8hrs/day = 2.67 days .  From here all other values can be easily calculated.

Let me explain values from the picture above. when you enter Actual duration manually, day by day (or week by week…), formula Work = Duration * Units does not work anymore. Values are calculated like:

Actual Duration. For Monday and Tuesday –> Work = 12 hours (for John and Mary) per day and Actual work is 12 hours as well. So, Actual duration is two days because everything is done! At Wednesday, John and Mary were supposed to Work 12 hours, but Actual work was 8 hours, so Actual duration is 8/12 = 0,67. So Actual duration for whole Task is 2+0,67 0 2,67 days!

  1. But when the manually entered  actual work does not correspond to resource assignment units in the Timephased view, the Actual Duration cannot be calculated using standard scheduling formula as in the example above. In this example the task’s  Actual Work = 37 hrs, %Work Complete = Actual Work / Work =  62% and  Duration = 5.63 days. This part is clear. But how does Project calculate Actual Duration =  3.67 days? If in this example Project calculates the task’s Actual Duration the same way  it calculates the Duration of 5.63 days , the Actual Duration should be calculated as 4 days, not 3.67 days based on the actual duration of the driving resource John.

SNAGHTMLf16d9a

Let me explain values from the picture above. Since you know that formula Work = Duration * Units does not work anymore, Values are calculated like:

Actual Duration. For Monday, Tuesday and Wednesday are equal to Work, because when you enter Actual, Work field is automatically equal to Actual. So Monday, Tuesday and Wednesday are 3 days! At Thursday, John and Mary were supposed to Work 12 hours, but Actual work was 8 hours, so Actual duration is 8/12 = 0,67. So Actual duration for whole Task is 3+0,67 = 3,67 days!

Posted in MICROSOFT PROJECT, Microsoft Project 2013, Micsrosoft Project 2016, MS PROJECT 2016, PMI, PRoject Management | Tagged , , | 1 Comment

Effort without specific Tasks in Projects using Microsoft Project 2016!

Hi,

often I have a question like this: “How to assign Work to someone when that work is not to be linked with any specific Task?”. I will show you how with MS PROJECT 2016!

But first I have to explain the scenario. Is it possible to have work for someone, and that work IS NOT linked to specific Task? The answer is – YES! For example, let’s say that you are Project manager. And, for this scenario I WILL NOT consider regular meeting, which are covered with recurring Tasks.

As a project manager you can have little work. For example, when you are finished with planning, you monitor and control the execution of the Project, and since everything goes perfect, at the end of the Project, you will close it. So, you as a Project manager has a regular work, and you can assign that work to tasks like Planning, Reporting Closing. And this is scenario is fairy tale! Project, always ha a problems. And guess what! you can not plan when will it occur. You cam mitigate Risks o avoid them using proper Risk manager, but problems will almost always occur. So you must plan some hours for solving them. for example you will have to go to meeting with the Customer to find out where are the problems, you will how to figure out with your team, how to solve it, you will have some reports to write and so on. On the other hand, beside the problem, you will have to do some administrative work, which are not regular, ant there is no easy way to determine when will you have to do that work.

So, for those situations you will have to plan some hours. And since you do not know when will you do the work, you will use Manually scheduled tasks: Your Project might looks like this:

As you can see, I put 120 hours to Project Management Task, and I assigned Project manager to it, but I left Duration, and Start Date and End Date empty, because I do not know when this work will be performed.

this Task is in relation to End of the Project Task, because due to best practice not a single task in a Project should be an orphan.

Let’s see Task Usage View:

As you can see work is spread along some dates, but this  not important, since those hours are Planned! And one important thing. If I assign, for example, Project manager to Task 1 Phase 2 I will get:

Let’ s see Resource Usage View:

At Monday and Tuesday Project manger is supposed to work 16 hour per day, but he is not shown as over allocated, because Project management Task is Manually Scheduled. And this is correct. We do not have exact Start date and End date, so this resource should not be over allocated.

Now we can save the Baseline:

and:

Now, let’s say that Project manager has worked 4 hours on the Project management Task at 22.08.2017 and 23.08.2017. you can put those hours on actual work in Task Usage View:

Now in Gant Chart View, you will get:

and It does make a sense.

So, this is on way of using resources and their efforts on non specific Task assigned.

Regards!

Posted in Microsoft Project 2013, Micsrosoft Project 2016, MS PROJECT 2010, MS PROJECT 2016, PMI, PRoject Management | Tagged , , , , | Leave a comment

Over allocation not shown in MS PROJECT 2016 with Windows 10–Bug or not?

Hi,

My blog reader has a problem. He explained it step by step, and I will answer at it in the same way.

Project in certain instances doesn’t flag  over allocated resources.

For example, I created a resource John and assigned him to the project at 50% (Max Units):

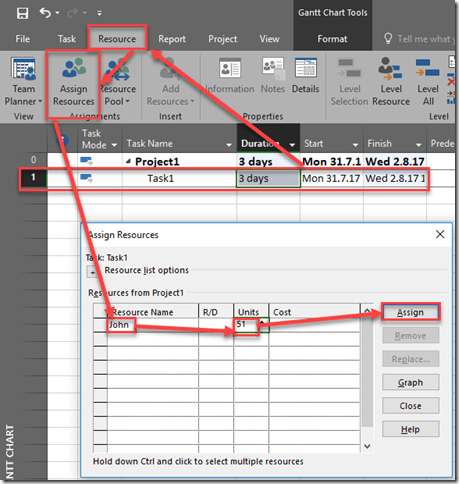

Then I assigned this resource to a task at 51% that exceeds its max units of 50%. In this case Project was supposed to flag John as over allocated resource, but it did not do that. The only place where Project show over allocation is in in the time phased portion of the  Resource Usage view:

Is it a BUG? No! Is it an over allocation? It depends.

In this particular case, this is not over allocation because of setup:

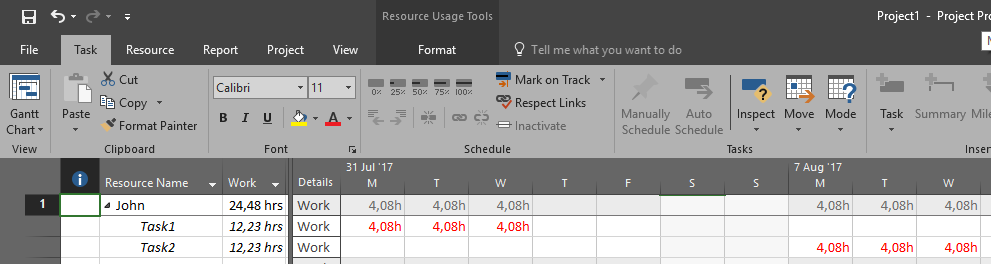

John is assigned to the Task with 51%. It means that he will work 51% of 8 hours = 4,08 hour per day, and he is supposed to work 4 hours per day MAX, because of his 50% availability. So yes, John is over allocated per day (as you can see in Resource Usage View), but since Levelling Options is setup to Week by Week (or maybe Month by Month) generally John is not over allocated. WHY? Because John should work max. 20 hours per week (5 days * 8 hours per day * 50% = 20 hours). Task1 has 3 days duration, and John is assigned with 51% which means that he will work 3 * 4,08 = 12,24 hours in particular week, which is less than 20 hours, so he is NOT over allocated. If I put Day by Day in field mentioned above I will get:

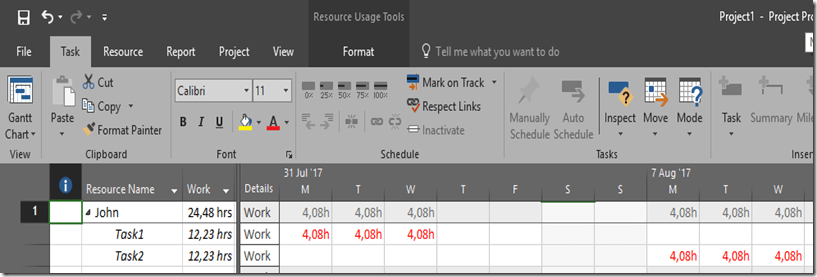

Now John IS over allocated because he is supposed to work no more than 4 hours per day (no matter how many hours he will spend in one week).

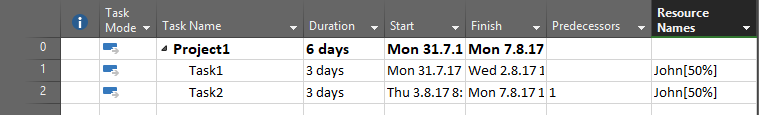

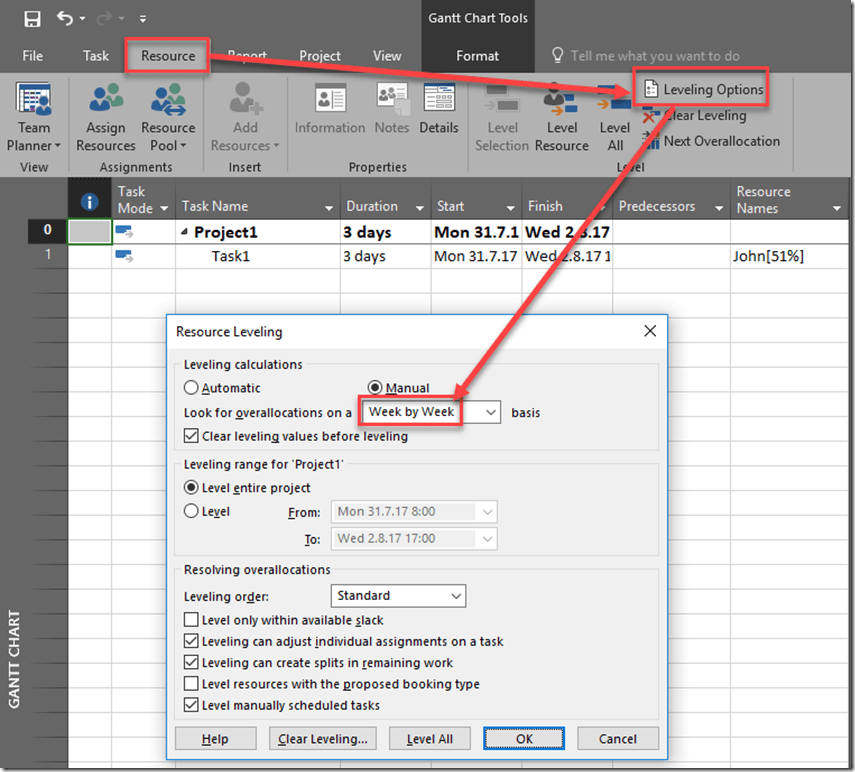

When I assign John at his Max. Units  (50%) or less to both tasks Task 1 and Tasks 2  that have  FS relationship, Project behaves as expected as no over allocation for John is detected.

But when I assign John to both tasks as above, but at any capacity  higher than his Max. Units, e.g. at 51%, Project marks John as over allocated although he is not as the tasks don’t run concurrently.

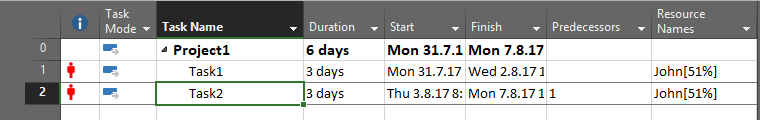

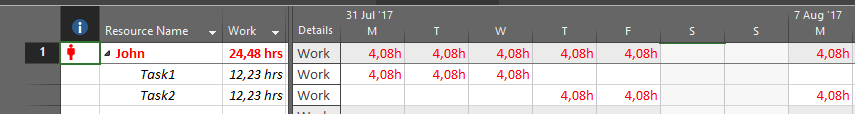

Again, since overallociation is set up to Week by Week, now John IS over allocated. Why? He is supposed to work 4,08 the whole week, which means he is supposed to work 5 * 4,08 = 20,4 hours in this particular week, but his maximum capacity is 20 hours per week.

On the other hand when I add a lag to Task 1,  Project behaves as expected and doesn’t show over allocation with the strange exception  in the time phased portion of the Resource Usage View where the work is displayed in red as being over allocated:

Again, everything works perfect. Since overallociation is set up to Week by Week, now John IS NOT over allocated. Why? He is supposed to work 4,08 for 3 days in a week (because of Lag) , which means he is supposed to work 3 * 4,08 = 12,24 hours in this particular week, but his maximum capacity is 20 hours, and 12,24 is less than 20 hours, so John is NOT over allocated. But he is over allocated in a single day, which is shown in Resource Usage View.

To conclude, before you want to deal with over allocation, be aware that you set it up in a right way (Day by day, Month by Month and so on).

Regards

Posted in MICROSOFT PROJECT, MS PROJECT 2016, PMI, PRoject Management | Tagged , , | 1 Comment

Multiple relationships between Tasks – using dummy Task in MS PROJECT 2016

Hi, my last post Multiple relationships between Tasks–is this possible?, caused a lot of reactions. all of them are about using dummy Task. Here is one of them:

“Insert a dummy milestone to carry part of the logic between the two tasks. I.e. “Task1” > SS > “Start Task1” (the dummy milestone) > SS+1 > Task2. And “Task1” > FF > “Task2.”

OK! Let’s do it with Microsoft Project 2016:

First, I will create Start to Start relationship between Task 1 and Dummy Task:

Now, I will create Start to Start relationship between Task 2 and Dummy Task, with 1 day lag:

as you can see, Task 2 will start 1 day after Task 1 will start.

Finally, I will create Finish to Finish relationship between Task 2 and Task 1:

Yeah! I’ve got what I wanted! Wait! Do I?.

Let’s say that for some reason Task 1 Should start at 31.07.2017. I will put it in Start Date field, and I will create Start no Earlier than constraint:

Everything looks perfect. Task 2 is still going to start one day after Task 1 will start. Now suppose that Task 1 for some reason will have 10 days duration.

as you can see, Task 2 will finish when Task 1 is to be finished, but it will not start one day after Task 1 is supposed to start.

So, once again, you CAN NOT have more than one relationship between two Tasks! Smile

Regards!

Posted in MICROSOFT PROJECT, MS PROJECT 2016, PMI, PRoject Management | Tagged , | 2 Comments

Multiple relationships between Tasks–is this possible?

Hi,

I have a great question form one of my Blog readers:
“Hi Nenad,
thanks for your time and experience. I have a question:
I have to tasks 1 and 2.
Task 2 starts with 1 day of delay of the start of task 2 (Start Start +1 day).
But task 2 cant finish until task 1 is finished.
How can I do that?”

I will show you that you can not do that in this way with MS PROJECT 2016!

First I will create a brand new Project with two Tasks:
Now I have to decide, because there is only one dependencies type that can be establish between two Tasks. In this example it has to be Start to Start with delay of 1 day, like this:

an I will get:

In this case, no matter when the Task 1 will be started, MS PROJECT will automatically move Task 2 to start 1 day after Start Date of Task 1.

But no matter when Task 1 will be finished Task 2 will not depend of that Finish date. To do that (make that Task 1, and Task 2 finish at the same date), I have to establish Finish to Finish dependencies:

and I will get:

In this case, no matter when the Task 2 will be finished, MS PROJECT will automatically move Task 2 to finish at the same date as Task 1.

But now I do not have Start Date set for Task 2 one day after Task 1 will be started. Of course I can manually adjust Start Date for Task 2 (and then make Start no Earlier Than constraint for Task 2), like this:

It looks perfect, but it is not. If I, for example, for same case move Task 1 to start at Wednesday, 26.7.2017:

and:

I will get:

Now, I have Start no Earlier Than constraint for Task 1, and the Start Date is Wednesday, 28.07.2017, so Task 2 will start 1 day before Task 1, and not after.

To conclude, you can choose only one dependencies type between Tasks, and then take care manually for the rest , but be aware that in large projects with many Tasks, and multiple dependencies (when one task has multiple predecessors or/and successors) it can be very complicated and you can easily make a mistake which is lately hard to find.

Regards!

Posted in MICROSOFT PROJECT, Microsoft Project 2013, Micsrosoft Project 2016, MS PROJECT 2016 | Tagged , | 4 Comments

How to show different Baseline in Gantt Chart–MS PROJECT 2016

Hi,

I’ve got a question about MS PROJECT 2016:
“Dear Nenad,
How we can have a new baseline (adding task or resource and delete task or resource) and how viewing that new baseline on the Gantt Chart.”

I will show you how to da this Step-by-Step.

1. First I will create a brand new Project:

2. I will have Two Resources on the Project – John and Mary:

3. I will assign Resources to those Tasks:

4. I will save the Baseline:

and:

5.  To see Actual Schedule and Baseline Schedule I will use Tracking Gantt View (and you should as well, because this View is justofor that):

Red Bar shows Actual Schedule and Grey Bar shows Baseline Schedule (it is static or frozen)

6. Suppose that Project Plan has changed and I do not need Task 2 no more, but I need Task 4 = 4 days Duration with Task 3 as Predecessor, and Mary will work on that Task (I will show that on regular Gant Chart):

On the Tracking Gantt it looks like:

7. As you can see it looks like a mess. Since this is our new Project Plan we will save it as a separate baseline:

and:

8. Finally I will show this new Baseline (Baseline1) in Tracking Gantt View):

Finally I will get:

I hope this helps.

Regards!

Posted in MICROSOFT PROJECT, Micsrosoft Project 2016, MS PROJECT 2016, PMI, PRoject Management | Tagged , , | 3 Comments

Task Calendar and Resources – how they fit together in MS PRIJECT 2016?

Hi,

I had a lot of question about the Topic I will write about today. Basically it is about relations between Resource (with no Calendar, or, to be more precise, which has Standard Calendar assigned), and specific Task with Specific Calendar working time.

I will explain this with MS PROJECT 2016 with Very simple Project, which has only one Task, and only one Resource.

Task has 1 day Duration. Suppose, that for some reason work on Task can be done only from 08:30 to 13:30, and from 14:30 to 17:30 (let’s say for security reasons), and this will apply only for this Task.

First, I will create separate Calendar:

and:

OK! Now I will assign Task Calendar to the Task:

and I will get:

As you can see, duration for the Task is 1 day, but for the Project is 0,94 days (and the Project has only one Task).

As you can see on the right side of the screen Task will be worked on from 08:30 to 17:00.

How to explain this? first, if you choose File->Options->Schedule you will notice this:

In  Task Calendar work can start at 08:30, so it will start at that time. On the Task Calendar, work can end at 17:30, but because the Schedule (see screenshot above) says that end time is at 17:00, the work will end at that time. So, the Task will be worked on from 08:30 to 17:00 with on hour break  from 13:30 to 14:30 (according to the Task Calendar9, and that is 7,5 hours of total work. But, because on Schedule Option it says that it is 8 hours per day, duration for the Project is calculated as 7,5 / 8 = 0,94.

Now I will assign Resource – John to the Task. he has no specific calendar, so he is supposed to work from 08:00 to 12:00 and from 13:00 to 17:00. When I assign him, I will get this (I will show you on the Task Usage View):

  • Monday, 10.07.2017:

  • Tuesday, 11.07.2017:

I will explain this result, step by step:

  1. Task Duration is 1 day, and this is 8 hours of work to be done on it (see 3 pictures above)
  2. John can work from 08:00 to 12:00 and from 13:00 to 17:00
  3. Task Calendar says that on Task work can be done from 08:30 to 13:30 and from 14:30 to 17:30
  4. According to that, John will start to work at 08:30 (because of Task Calendar) and he will work to 12:00 (because of his Calendar), and this is 3,5 hours. He will continue at 13:00 (because of his Calendar) and he will work to 13:30 (because of Task Calendar) and this is 0,5 hours. Then he will continue at 14:30 (because of Task Calendar), and he will work to 17:00 (because of his Calendar) and this is 2,5 hours. So he will work 3,5+0,5+2,5= 6,5 hours at Monday. At Tuesday John has to work remaining 1,5 hours and he will start to work at 08:30 (because of Task Calendar) and he will work to 10:00.
  5. Duration for the Project says that it is 1,19 days. It is confused. Why? Because you will think that the calculation should be 6,5 hours on Monday /8 hours per day (in Schedule options) + 1,5 hours on Monday /8 hours per day (in Schedule options) = 1. But MS PROJECT calculates it like: Monday = 1 day because it was worked on it the whole day (whenever it was possible to work!). On Tuesday it was worked 1,5 hours of 8 available, so it is 1,5/8 = 0,19. Do the Total duration is 1 (Monday) + 0,19 (Tuesday) = 1,19 days

To conclude, it can be confusing, but you should get use to it.

Regards!

Posted in MICROSOFT PROJECT, Microsoft Project 2013, MS PROJECT 2016, PMI, PRoject Management | Tagged , , | Leave a comment

Scheduled Start and Scheduled Finish fields in MS PROJECT 2016

Hi,

today I will explain two fields, not so often used in MS PROJECT 2016: Scheduled Start and Scheduled Finish. First I will create one simple Project with three Tasks, connected like this:

As you can see Scheduled Start is equal to Start field, and Scheduled Finish is equal to Finish field. and this is always true as long as Task is in auto scheduled mode. BUT! I wil schange, for example Task 2 from Auto to Manual scheduled mode:

As you can see, nothing has changed. But, let’s say that I do not know, Start and Finish date for this Task, And I will put TBD in those fields:

So, even I do not actually know when my task is about to begin  (maybe because I do not know who will work on it, when those Resources will be available), I still have Scheduled values based on the known data  8which is Duration in my Example).

Good to know that, and very useful fields.

Regards

Posted in MICROSOFT PROJECT, MS PROJECT 2016, PMI, PRoject Management | Tagged , , | Leave a comment

How to show duration in different units for the same Task in MS PROJECT 2016

Hi,

today I’m going to show you ProjDurConv function which is very useful in MS PROJECT 2016.

Here is the Scenario. Suppose that I have a simple Project with one Task, and it’s Duration is 5 days:

I want to see Duration in hours as well. So, in my example I should see 40 hours because my Project is set up like:

and:

and:

So 5 days are 5 * 8 = 40 hours.

To show this 40 hours I will use custom field with ProjDurConv function (follow this example step by step):

then:

then:

then:

So, MS Project will convert duration from Days  (which is in Duration field), to hours (mention in pjHours).

Now I will show this column in My Gantt Chart:

SNAGHTMLf58948d

Now you can see for one Task, Durations in two different Units of Measures.

I will now Define two resources, John and Mary:

SNAGHTMLf5a4114

Now I will assign John and Mary to the Task (notice That john will be assigned with 50% Units):

SNAGHTMLf5bcf46

As you can see in Work column (which I put in the Gant Chart View), it is 60 Hours (5 days * 8 hours per day for Mary = 40 hours + 5 days * 4 hours per day for John = 20 hours in Total = 60 hours).

OK! Finally I want to see Duration in days but according to work (I want to see how many man days will I spend to this Task). In this case I will use third Custom filed called Man Days:

So, MS Project will convert Work from Hours  (which is in Work field), to Days (mention in pjDays).

Finally I will but this custom field on the Gantt Chart:

As you can see, in Man Days I’ve got 7,5 days (60 hours of total work / 8 hours per day shown in Hours per Day = 7,5 days).

As you can see ProjDurConv is powerful Function and I use it a lot.

Regards!

Posted in Micsrosoft Project 2016, MS PROJECT 2016, PMI, PRoject Management | Tagged , | Leave a comment
